A solar battery stores the electricity your panels produce during the day and makes it available at night - reducing your grid draw by 50–80% in most European households. Without a battery, a typical grid-tied solar system self-consumes only 25–30% of its production (the rest exports to the grid at low rates). With a 10 kWh battery, self-consumption rises to 60–80%.
This guide covers everything about solar battery storage: how AC and DC coupling differ, LFP vs NMC chemistry, how to size the right capacity, and whether the economics make sense at current prices in Europe.
What you'll learn
- Three reasons to add a battery beyond just self-consumption
- AC vs DC coupling - efficiency numbers and when each applies
- LFP vs NMC chemistry trade-offs for residential storage
- The sizing formula with a worked example
- Top solar batteries available in Europe (2026) with pricing
- Payback period for a 10 kWh battery in Germany at current prices
Why Add a Battery to Your Solar System?
Three reasons dominate in practice - and they appeal to different buyers.
1. Self-Consumption Maximization
European electricity import costs run €0.25–0.45/kWh depending on country and tariff. Typical solar export tariffs pay €0.04–0.10/kWh. The spread is 4x–10x. Every kWh you store and use yourself instead of exporting is worth the difference.
A household exporting 60% of its solar production at €0.07/kWh and buying back at €0.32/kWh loses €0.25 per kWh on the exchange. A battery captures that value. For a 10 kWp system producing 10,000 kWh/yr with 6,000 kWh exported, that gap costs €1,500/yr before a battery.
2. Backup Power
Grid-tied solar without a battery goes offline during a blackout - for safety reasons, inverters are required to stop feeding the grid if it loses power. A battery system with backup capability maintains power to critical loads during outages. Hybrid inverters like the Fronius Symo GEN24 and Huawei SUN2000 include automatic backup switching.
3. Time-of-Use Arbitrage
Where electricity tariffs vary by time of day (common in the UK, some German utilities, and across Scandinavia), batteries can charge from cheap overnight grid electricity and discharge during expensive peak periods - even without solar. For households on dynamic tariffs, this can add €100–300/yr of additional savings on top of self-consumption benefits.
Key Takeaway
Self-consumption is the primary financial driver for most European households. Backup power is the primary emotional driver. Time-of-use arbitrage is a secondary benefit that depends entirely on your tariff structure.

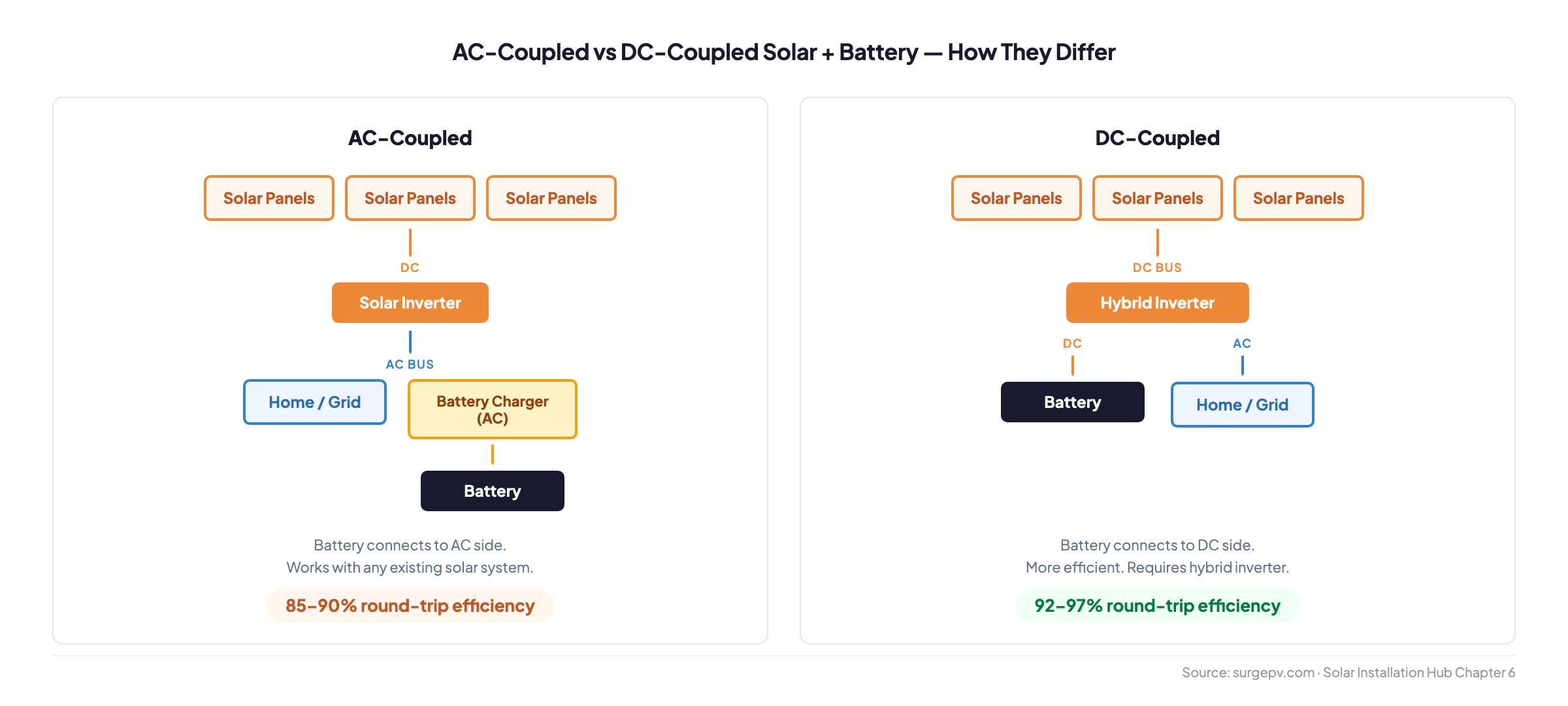

AC-Coupled vs DC-Coupled: Which Connection Type?
The connection type determines how the battery interacts with your solar panels and inverter - and it significantly affects system efficiency.

DC-Coupled Storage
In a DC-coupled system, the battery connects directly to the DC bus of a hybrid inverter. Solar panels feed the hybrid inverter, which charges the battery in DC before converting to AC for home use. The energy path is: panels → hybrid inverter DC bus → battery (and simultaneously → AC loads).
Round-trip efficiency for DC coupling: 92–97%. The battery charges and discharges without an extra AC-DC-AC conversion step.
DC coupling is the right choice for new installations. You specify a hybrid inverter from the start and connect the battery to it. See Chapter 5 for hybrid inverter models.
AC-Coupled Storage
In an AC-coupled system, the battery has its own bidirectional inverter and connects to the AC side of the system - after the solar inverter. The energy path is: panels → solar inverter → AC bus → battery inverter → battery (and → AC loads).
Round-trip efficiency for AC coupling: 85–90%. There's an extra AC-DC-AC conversion when charging the battery from solar.
AC coupling makes sense for retrofits - adding a battery to an existing solar installation without replacing the solar inverter. The Tesla Powerwall 3 is AC-coupled by default. So is the Sonnen eco. You don't need a new hybrid inverter, just a compatible gateway device.
Which to Choose
| Scenario | Recommended | Reason |
|---|---|---|
| New solar + battery install | DC-coupled (hybrid inverter) | Higher efficiency, lower long-term cost |
| Adding battery to existing solar | AC-coupled | No inverter replacement needed |
| Backup power is priority | Either - check inverter backup spec | Both can provide backup; confirm automatic switchover |
For a 10 kWh battery cycling once daily, the 5–8 percentage point efficiency difference between AC and DC coupling equals roughly 180–290 kWh/year in lost energy. At €0.32/kWh, that's €58–93/yr. Not dramatic, but it compounds over a 10-year battery life.
LFP vs NMC: Choosing the Right Battery Chemistry
Two lithium chemistries dominate the residential solar storage market. Understanding the difference matters because it affects safety, longevity, and how the battery performs in real-world conditions.
LFP (Lithium Iron Phosphate)
LFP is the preferred chemistry for residential solar storage in 2026. It runs cooler, tolerates heat better, and lasts significantly longer than NMC. Key specs:
- Cycle life: 3,000–6,000 cycles at 80% depth of discharge
- Operating temperature: Performs well from 0°C to 55°C
- Safety: No thermal runaway risk at normal operating temperatures. Does not catch fire when punctured.
- Energy density: Lower than NMC - batteries are larger and heavier for the same kWh
- Products: BYD HVM/HVS, Tesla Powerwall 3, Sonnen eco, VARTA element
NMC (Nickel Manganese Cobalt)
NMC offers higher energy density - you get more kWh in a smaller, lighter package. But this comes with trade-offs:
- Cycle life: 1,500–3,000 cycles
- Temperature sensitivity: Performance degrades noticeably above 35°C; thermal management is critical
- Safety: Higher thermal runaway risk than LFP under abuse conditions
- Use case: Better suited for space-constrained installations or EV applications
The Simple Rule
For residential solar storage in a garage, utility room, or outdoors, specify LFP. Higher cycle life means it outlasts the warranty period by years. The larger physical size is rarely a constraint for home installations.
Degradation in Practice
LFP batteries typically retain 70–80% of their original capacity after 10 years of daily cycling. Most manufacturers guarantee 60–70% capacity retention at end of warranty. An LFP battery warrantied for 10 years will still deliver meaningful storage capacity at year 12–15, reducing replacement frequency relative to NMC.
How to Size Your Battery System
Battery sizing has one governing formula:
Battery capacity (kWh) = Daily consumption (kWh) × Days of autonomy ÷ Depth of discharge (DoD)
For most LFP batteries, DoD = 90% (meaning you can use 90% of rated capacity without degradation). For NMC, DoD is typically 80–85%.
Worked Example
A 3-bedroom home in Germany consumes 12 kWh/day. The owner wants 1 day of autonomy (covering one evening-to-morning cycle):
- 12 kWh/day × 1 day ÷ 0.90 DoD = 13.3 kWh required capacity
The closest standard product is a 13.5 kWh Tesla Powerwall 3 or a BYD HVS 13.8 kWh module. A 10 kWh battery would cover roughly 75% of the evening load - still a large improvement over no battery.
Winter vs Summer Sizing
Here's what most online guides miss: size for winter consumption, not summer. In December in Germany, a 10 kWp solar array produces 30–40% of its July output. The battery must cover far more of the household's needs from a smaller daily solar harvest. If you size for summer self-consumption, the battery will underperform in the months when grid electricity is most expensive to import.
The practical implication: for most European households, a 10–15 kWh battery is the right range. Systems larger than 20 kWh are only justified if you have EV charging loads or run home office equipment overnight.
Pro Tip
Use your generation and financial tool to model monthly production vs consumption. The winter months will show you exactly how much battery capacity you need to maintain target self-consumption through December and January.
Top Solar Batteries in Europe (2026)
| Product | Chemistry | Capacity | Warranty | Round-Trip Eff. | Price (est.) |
|---|---|---|---|---|---|
| Tesla Powerwall 3 | LFP | 13.5 kWh | 10 yr / 2x degradation | 97% | €10,000–12,000 |
| BYD HVM/HVS | LFP | 5.1–22+ kWh | 10 yr | 96% | €5,000–15,000 |
| Sonnen eco | LFP | 5–22 kWh | 10 yr | 86% | €8,000–18,000 |
| SolarEdge Home Battery | LFP | 9.7 kWh | 10 yr | 94% | €5,500–7,000 |
| VARTA element backup | LFP | 3.3–26.4 kWh | 10 yr | 90% | €4,000–18,000 |
The BYD HVM/HVS modular system is the most flexible - you can add modules over time as needs grow. The Tesla Powerwall 3 has the highest round-trip efficiency at 97% and integrates cleanly with Tesla solar systems. SolarEdge Home Battery pairs directly with SolarEdge inverters with no additional gateway hardware.
On Pricing
Battery prices in Europe have fallen 40–50% since 2021. The current (2026) installed cost for a 10 kWh LFP system including installation labor runs €7,000–12,000 depending on product and installer margin. Prices continue to fall roughly 8–12% per year as manufacturing scales.
Is Solar Battery Storage Worth It? The Economics in 2026
The honest answer: batteries don't deliver the same ROI as solar panels alone. Panels pay back in 7–10 years in most European markets. Batteries currently pay back in 10–15 years. But the economics are improving, and the non-financial case is stronger than it's ever been.

The Numbers for Germany

Assumptions: 10 kWp solar array in Germany, 10 kWh LFP battery added at €8,000 installed cost, electricity price €0.32/kWh rising 3% annually (Fraunhofer ISE 2024 baseline).
- Without battery: self-consumption 30%, annual savings from solar ~€1,200/yr, payback ~8 years
- With battery: self-consumption rises to 70%, additional annual savings ~€700–900/yr from battery alone
- Battery-only payback: €8,000 ÷ €800/yr = 10 years
- If electricity prices rise 4%/yr instead of 3%: payback shortens to ~8.5 years
This assumes the battery runs one full cycle per day for 10 years - 3,650 cycles total, well within LFP rated life.
Where Batteries Make Clearer Sense
- High electricity prices - Spain (€0.35–0.45/kWh peak), Italy (€0.30–0.40/kWh), UK on time-of-use tariffs. Higher prices improve payback directly.
- Backup power requirements - If blackouts occur regularly in your area, the value of backup power is real and quantifiable (avoided spoiled food, medical equipment continuity, home office uptime).
- Rising grid prices - Every 1% increase above baseline in electricity price shaves roughly 0.5 years off payback.
- EV charging loads - If you charge an EV overnight, a battery sized to cover EV charging from solar production can have payback under 8 years.
Where Batteries Are Harder to Justify Financially
- Low electricity prices (under €0.20/kWh) - some northern European markets with high renewable mix
- High feed-in tariffs - older systems with guaranteed €0.12–0.20/kWh export rates; storing rather than exporting reduces income
- Short system horizon - if you plan to sell the property within 5 years, the battery likely won't pay back
The Core Trade-off
For pure financial return, panels beat batteries. Batteries are about energy independence, backup security, and electricity price protection. Those have real value - they just don't fit neatly into a payback table.
Model Your Battery Payback with SurgePV
The generation and financial tool models solar-only vs solar+battery scenarios - with monthly production curves and cash flow projections.
Book Free Demo20 minutes · Live walkthrough · No commitment
Battery Installation: What to Expect
A residential battery installation typically takes one full day for a new system, or half a day if adding to an existing solar install. Here's what the process involves:
Site Preparation
Most LFP batteries are wall-mounted indoors - in a garage, utility room, or basement. The battery needs a flat wall, adequate ventilation (not enclosed), and proximity to the inverter. Outdoor-rated units (some Sonnen models, VARTA) can be mounted outside if indoor space is limited. Temperature range matters: most LFP batteries should not be installed where temperatures regularly fall below -5°C or exceed 45°C.
Electrical Work
The battery connects to the hybrid inverter via DC cables (for DC coupling) or to the main distribution board via AC cables (for AC coupling). A certified electrician must complete all connections. In most European countries, the battery installation must be notified to the grid operator - the same process as the original solar grid connection.
Commissioning and Setup
Hybrid inverter systems require software configuration: setting the battery's charge/discharge schedule, backup priority loads, and feed-in limits. Most manufacturer apps (Fronius Solar.web, Huawei FusionSolar, SolarEdge app) walk through this setup in under 30 minutes. Define your backup loads carefully - the backup circuit should cover essentials (refrigerator, lighting, router, critical sockets) but not high-draw appliances like electric showers or ovens, which would drain a 10 kWh battery in minutes.
Pro Tip
Set a minimum state of charge for backup purposes. Reserve 20–30% of battery capacity as an emergency buffer that the system won't use for self-consumption. This ensures you always have 2–3 kWh available for a blackout event.
Frequently Asked Questions
How many kWh battery do I need for a house?
A 3-bedroom home typically needs 8–15 kWh. Size for your daily consumption in winter, not summer - solar production drops 30–50% in winter, so the battery must work harder to cover evening and night loads. A 10 kWh battery covers most European households well.
Does solar work without a battery?
Yes. Most grid-tied solar systems don't have batteries. You export surplus electricity to the grid and import when panels don't produce enough. A battery improves self-consumption from around 30% to 60–80%, but it's not required for the system to function. The solar software can model both scenarios to show you the financial difference.
How long do solar batteries last?
LFP batteries typically last 10–15 years, with 3,000–6,000 charge cycles at 80% depth of discharge. Most manufacturers offer a 10-year warranty with a minimum capacity retention guarantee (usually 60–70% of original capacity).
