Answer
The DC/AC ratio is the solar array's DC size divided by the inverter's AC size. A 7.5 kWp array on a 6 kWac inverter has a ratio of 1.25. US utility-scale plants have averaged about 1.3 since 2017 (LBNL). A higher ratio clips more power at midday, so model your own site.
Last updated: November 2026
SurgePV publishes this post and sells solar design software. It names inverter makers only to quote their own datasheets.
Sizing an array bigger than its inverter is normal practice, and the question is how much bigger. The answer is a trade between cheap extra modules and the midday energy the inverter throws away. This guide shows the formula, what datasheets allow and how to find a ratio you can defend.
Design Rules by Market Segment: What the Sources Say
No source we found publishes one “typical” ratio for each segment. The table shows what primary documents do say. The ratios in the last column are our arithmetic from each document’s own figures.
| Segment or product | What the source says | Ratio | Source |
|---|---|---|---|
| US utility-scale plants | Average ratio held steady around 1.3 since 2017. Fixed-tilt and tracker plants did not differ meaningfully in 2025 | About 1.3 | LBNL, US Utility-Scale Solar, 2026 Edition |
| String inverter, Fronius Symo Advanced 20.0-3-M | 20 kW AC. Max PV generator power 30 kWpeak | 1.50 | Fronius technical data |
| String inverter, SMA STP 110-60 | 110 kW AC. Max PV array power 165,000 Wp (STC) | 1.50 | SMA datasheet, status 11/2023 |
| String inverter, Sungrow SG110CX Premium | 110 kVA AC. Recommended max PV input 147 kW | About 1.34 | Sungrow datasheet V11 |
| Hybrid inverter, Sungrow SH10RT | 9,999 W AC. Recommended max PV input 15,000 W | 1.50 | Sungrow datasheet V15 |
| Microinverter, Enphase IQ8M | 325 VA maximum continuous output (330 VA peak). Commonly used module pairings 260 to 460 W | About 1.42 | Enphase datasheet, 10 Dec 2024 |
Sources: LBNL slides, October 2026 (sample of 1,981 projects, 138 GWac). Fronius: Symo Advanced 20.0-3-M. SMA: STP 110-60 datasheet. Sungrow: SG110CX Premium and SH10RT. Enphase: IQ8M and IQ8A data sheet (DSH-00243-3.0-EN-2024-12-10).
How the ratios were worked out: 30 ÷ 20 = 1.50. 165 ÷ 110 = 1.50. 147 ÷ 110 = 1.34 (kW over kVA). 15,000 ÷ 9,999 = 1.50. 460 ÷ 325 = 1.42 (the continuous rating, not the 330 VA peak). The Sungrow figures are “recommended” maximums. SMA and Fronius call theirs a maximum. Enphase gives module pairings, not a hard DC limit.
These ratios are hardware limits, not design targets. Your best ratio is usually lower than the limit. Find it with a model (see the steps below).
- US utility-scale average (LBNL)1.3
- Sungrow SG110CX Premium1.34
- Enphase IQ8M (continuous rating)1.42
- Fronius Symo Advanced 20.0-3-M1.5
- SMA STP 110-601.5
- Sungrow SH10RT1.5
Source: LBNL Utility-Scale Solar 2026 Edition; Fronius, SMA, Sungrow and Enphase datasheets; ratios calculated in this post, checked November 2026.
Key Takeaway
Divide DC size by AC size. Datasheet limits sit far above the 1.3 utility-scale average, so the limit is not the target. Model clipping with your own weather and prices before you pick a ratio.
In this guide:
- How to calculate the DC/AC ratio
- Why the ratio is a cost and yield trade
- What clipping is and why hourly models miss it
- Hardware and warranty limits
- A worked sizing example
- Common mistakes
- A step-by-step way to model and check your ratio
Compare Inverter Sizes on a Real Roof
Run roof modeling and energy-yield modeling in SurgePV, then check how much each inverter size costs you in lost midday energy.
Book a DemoChecking cost first? See the SurgePV pricing page
What Is the Solar DC/AC Ratio?
The DC/AC ratio is also called the inverter loading ratio (ILR). It compares the array’s total DC size to the inverter’s AC output rating.
Formula:
DC/AC ratio = Array DC size (kWp) ÷ Inverter AC rating (kWac)
kWp is the array’s size at standard test conditions (STC). kWac is the inverter’s continuous AC output. Some examples:
- A 7.5 kWp array on a 6 kWac inverter: 7.5 ÷ 6 = 1.25.
- A 12 kWp array on a 10 kWac inverter: 12 ÷ 10 = 1.20.
- A 100 MWp array with 75 MWac of inverters: 100 ÷ 75 = 1.33.
Use the inverter’s continuous AC rating. Do not use a peak or short-term overload figure.
The array rarely makes its full label power. Heat, dirt, wiring loss and module mismatch all cut output. So a ratio above 1.0 does not mean the inverter is overloaded all day. It means the array is sized to keep the inverter busy for more hours.
Our glossary has more on the inverter loading ratio, inverter clipping and inverter sizing. For the mechanics of clipping, see our guide to solar inverter clipping and DC oversizing.
Why the DC/AC Ratio Is a Cost-Yield Trade
Inverters and modules are priced separately. If extra modules cost less than the energy they add, the project gains. The extra energy is the energy added in the morning, the evening and the cloudy hours, minus the energy clipped at midday.
LBNL says developers oversize the DC array because module prices have fallen faster than inverter prices. It says this raises revenue and cuts output swings. LBNL also says a higher ratio should raise capacity factor measured in AC terms.
The right answer changes with each project. It depends on module and inverter prices, the weather file, the tariff or power price, and any export limit. A homeowner cares about bill savings. A utility owner cares about the cost of each kWh. Run the numbers for the customer you have.
The Clipping Trade Explained
Clipping is the energy an inverter drops because it is already at its AC limit. Think of a ramp meter on a freeway on-ramp. It limits how many cars enter. Cars turned away are the clipped energy.
Clipping needs three things at once:
- Sunlight strong enough to push array DC power above the inverter’s AC rating.
- Cool enough modules that the array makes close to its label power.
- A ratio above 1.0, so the inverter is the bottleneck.

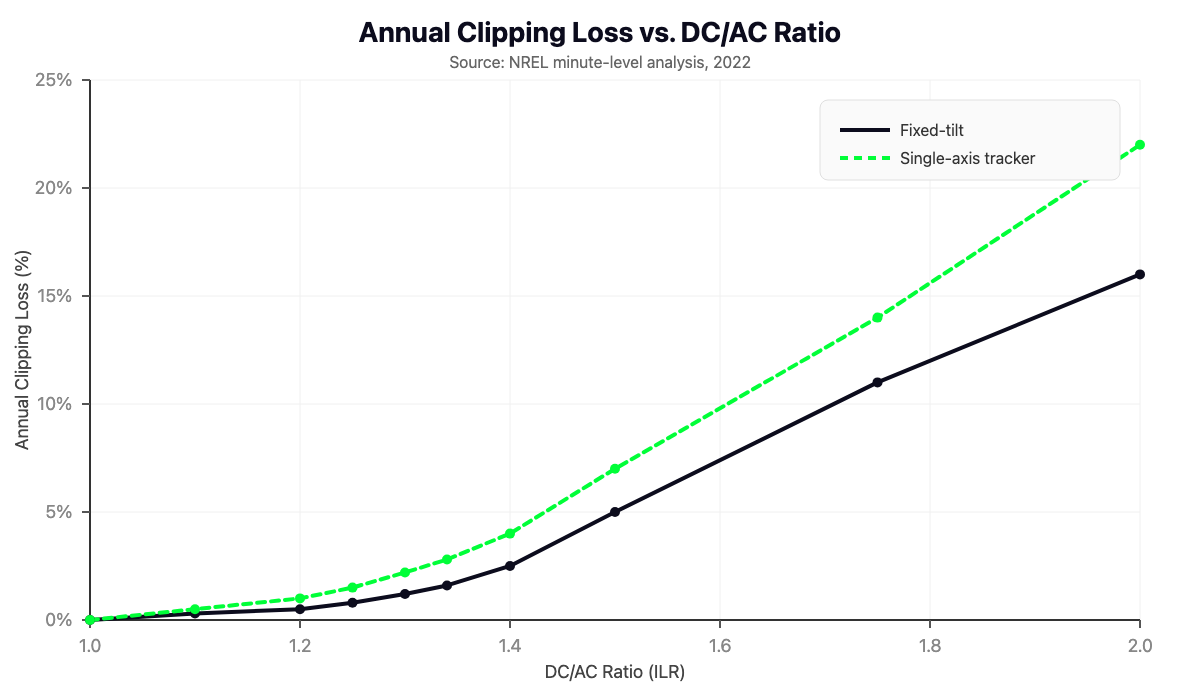

Most clipping lasts only a short time around midday on clear days. Hourly simulations can hide it. NREL researchers (Anderson and others, 2022) found that energy estimates from typical industry models have a bias that grows with the inverter loading ratio. Short spikes in sunlight clip power inside an hour, but an hourly average hides them. LBNL’s 2026 edition says the same: hourly modeling underestimates sub-hourly clipping in projects with high DC/AC ratios.
The lesson is practical. For high ratios, use sub-hourly data in your model or add a clipping correction. Read the NREL paper, The Effect of Inverter Loading Ratio on Energy Estimate Bias, for the method.
Sandia’s inverter model shows how an inverter turns DC input into AC output and where the maximum AC power (PAC0) limits it.
How Climate and Technology Shift the Best Ratio
We found no primary source that gives a ratio for each climate or technology. The direction of each effect is simple physics. Use your model for the size of the effect.
- Hot sites. Hot modules make less power than their label. They clip less than a datasheet suggests.
- Cool, clear sites. Modules run closer to their label power. The same ratio clips more.
- Cloudy sites. The array rarely reaches full output, so the inverter is the limit on fewer days.
- Bifacial modules. They add power from the rear side. The real DC power can be higher than the front-side label. Include the rear gain in your model, or you may clip away the bifacial gain. See our bifacial solar panel design guide.
- Trackers. They widen the daily production curve. They also raise the peak, so they can clip more at the same ratio. LBNL found no meaningful ratio gap between fixed-tilt and tracker plants in 2025.
- Microinverters. Each module has its own small inverter, so clipping happens at each module. Enphase publishes module pairings. See the table above.
Warranty and Code Limits
The DC/AC ratio is a design choice. The inverter datasheet and local rules set the box you work in.
Manufacturer Limits
Every inverter datasheet gives a PV power limit or a recommended limit, plus a current limit for each MPPT input. An MPPT (maximum power point tracker) is the part that finds the best operating point for a group of strings. The datasheets in the table above give these limits. SMA’s STP 110-60 sheet lists “Max. PV array power” as 165,000 Wp (STC). Sungrow’s sheets list a “recommended max. PV input power”.
None of the datasheets we read states a warranty penalty for going over. Read the warranty document for your exact model. Check the current limit of each MPPT input as well as the total PV power. Two strings in parallel on one input can pass the current limit while total power looks fine.
Enphase’s data sheet says pairing modules above the stated wattage “may result in additional clipping losses”.
Rules in India
The Ministry of New and Renewable Energy (MNRE) issued an advisory on 5 November 2019. The PIB release of 6 November 2019 says installed DC capacity above the contracted AC capacity is not a violation of the PPA or PSA. Two conditions apply. The AC capacity must match the contract, and scheduled power must never exceed the contracted AC capacity. A specific clause in the PPA can still restrict DC capacity.
For the PM Surya Ghar rooftop scheme, the guidelines base the subsidy on the rated DC capacity of the modules. They do not use the inverter size. They also say the inverter shall have overloading capacity of at least 20%. This is a feature the inverter needs. It is not a recommended ratio.
Local Grid Rules and Export Caps
Your utility may set its own limit on inverter size, DC size or export. Ask the utility before you finalize the design. We did not find a published ratio cap in the Hawaii, California or New Jersey documents we checked, so we state none.
Where the grid limits AC export, a high ratio can waste energy twice. It is lost once to clipping and again to curtailment (the grid operator’s command to cut output). In an export-capped system, model clipping and curtailment as one combined limit. If the grid will not take the inverter’s full AC output, the inverter never reaches its clipping point.
Worked Example: Sizing the Inverter for a 10 kWp Array
This example shows the sizing arithmetic only. It uses no energy or price data, because those come from your own model and quotes. The inverter AC size is the array size divided by the ratio.
| Ratio | Array DC | Inverter AC (DC ÷ ratio) |
|---|---|---|
| 1.00 | 10.0 kWp | 10.0 kWac |
| 1.25 | 10.0 kWp | 8.0 kWac |
| 1.40 | 10.0 kWp | 7.1 kWac (10 ÷ 1.40 = 7.14) |
Next, for each row, take the annual energy and the clipped energy from your model. Then take the price of the inverter size from your supplier’s quote. Compare the energy value you gain against the inverter cost you save. Pick the ratio with the best net result for your customer. Check that the inverter’s PV limits in the datasheet allow it.
Pro Tip
Run the ratio sweep at 1.10, 1.25, 1.40 and your datasheet limit. Plot net value, not kWh, and pick the ratio where the curve flattens.
Common Mistakes
Copying the last project’s ratio. Weather, tariff and export rules change from site to site. Model each project.
Maximizing kWh instead of value. The goal is usually the best net present value, payback or bill saving. If the PPA pays less at noon, a higher ratio that shifts output to other hours can be worth more even if total kWh is flat.
Confusing clipping with curtailment. Clipping is the inverter’s limit. Curtailment is a grid command. They look alike on a production chart but have different causes and fixes.
Ignoring ageing. Modules lose output over time, so the ratio of real output to inverter size falls year by year. Add module degradation to your model.
Forgetting the bifacial gain. Rear-side power raises the real DC power. Model it, or you can clip it away.
Overlooking MPPT current. Total DC power can be inside the limit while one MPPT input is over its current limit. Check both.
How to Model and Verify the DC/AC Ratio
A ratio you can defend comes from a time-series simulation, not from a table. Free and paid tools include PVsyst, NLR SAM and NLR PVWatts. (NLR is the new name of the National Renewable Energy Laboratory, NREL.)
Step 1: Build the base design. Enter the site, array size, tilt, azimuth, module and inverter model.
Step 2: Run a ratio sweep. Test at least four ratios. Include one near the inverter’s limit.
Step 3: Record annual energy and clipping. Use sub-hourly data for high ratios. Hourly models underestimate clipping at high ratios (NREL, 2022; LBNL, 2026).
Step 4: Feed the energy into a financial model. Use the real tariff or PPA shape. A flat price values every kWh the same. A time-of-use tariff values some hours more. Under net billing, exported energy may be worth little.
Step 5: Check hardware limits. Confirm maximum PV power, current per MPPT, the voltage window at temperature extremes, and any local ratio cap. For string layout, see our solar string design guide.
Step 6: Check it after commissioning. On a clear day, compare the inverter’s AC output with the sunlight. A flat line at the AC limit while the sunlight is still rising is clipping. If the flat line sits below the AC limit, look for curtailment or a settings problem.
For batteries, read our guide to DC vs AC coupling with storage and our commercial battery storage sizing guide.
SurgePV’s shadow analysis shows shading hours on a roof. Shading cuts the DC power the array makes, which changes how much clipping you get.
Test an Inverter Limit on Your Own Project
See roof modeling, shading, energy-yield and financial modeling in a guided demo. Bring a real roof and the inverter you are considering.
Book a Free DemoWant prices first? Read the SurgePV pricing page
Conclusion
The DC/AC ratio is a high-leverage design choice. Pick it well and you lower cost and raise yield. Pick it blindly and you overpay for AC hardware or clip away the value of extra modules.
Three actions:
- Do not use one default ratio. Model at least three ratios with site weather and your own price data.
- Check the inverter datasheet twice: total PV power and current per MPPT.
- Treat clipping as a cost line. If the model shows the extra modules pay for themselves after clipping, the ratio is working.
SurgePV’s solar design software covers roof modeling, shading, energy-yield and financial modeling. Book a SurgePV demo and ask how it handles your inverter limits.
Frequently Asked Questions
What is a good DC/AC ratio for solar?
There is no single number. LBNL says the average ratio of US utility-scale plants has held steady around 1.3 since 2017. The inverter datasheet sets a hard upper limit for your design. The best ratio for your site comes from a model that uses your weather data, your module and inverter prices, and your tariff.
How do you calculate the DC/AC ratio?
Divide the array’s DC size in kWp by the inverter’s AC rating in kWac. For example, a 7.8 kWp array on a 6 kWac inverter gives 7.8 ÷ 6 = 1.30. The same number is also called the inverter loading ratio (ILR). Use the continuous AC rating from the datasheet, not a peak or surge rating.
What is inverter clipping and why does it happen?
Clipping happens when the array makes more DC power than the inverter can turn into AC. The inverter holds its output at its AC limit and the extra power is lost. It mostly happens around midday on clear days. A small amount of clipping can be a good trade if the extra modules cost less than the energy they add.
Does a higher DC/AC ratio always produce more energy?
No. A higher ratio adds energy in the morning, evening and cloudy hours. It also adds clipping at midday. At some point the extra clipping is larger than the extra energy. Where that point sits depends on your weather, module and inverter prices, and tariff. Run a model at several ratios to find it.
How much clipping loss is acceptable?
No source we read sets a standard limit. Decide from the financial model. Accept the clipping if the value of the extra energy is more than the cost of the extra modules, after the clipped energy is taken off. Check the model with sub-hourly data, because hourly models underestimate clipping at high ratios (NREL, 2022).
Can a high DC/AC ratio void the inverter warranty?
The datasheets we read do not state a warranty penalty for oversizing. They do give a limit on PV power or current. SMA lists a maximum PV array power, and Sungrow lists a recommended maximum. Read the warranty terms for your exact model, and keep each string within the current limit of its MPPT input.
How do batteries change the DC/AC ratio decision?
A DC-coupled battery can store power that would be clipped, so it allows a higher ratio. An AC-coupled battery cannot, because the solar inverter has already limited the AC output. Size the battery charge power to match the clipped peak that your model predicts.
