Quick answer
Solar heat collected and moved using powered pumps, fans or controls; distinguish this heating pathway from photovoltaic electricity.
Key Takeaways
- In solar heating, active systems use powered circulation; passive systems rely on natural heat movement for that function.
- A thermal collector, a photovoltaic array and a concentrating solar plant follow different conversion pathways.
- Collected heat, delivered heat and electrical energy need separate measurement boundaries.
- A kWh of heat and a kWh of electricity are energy quantities, but they do not necessarily serve the same load.
- Storage changes delivery timing; it does not guarantee useful output through every outage or cloudy period.
What Is Active Solar Energy?
Active solar energy usually means collecting solar heat and moving it with powered pumps, fans or controls. The heating definition distinguishes mechanical circulation from passive heat movement. If a document uses “active solar” more broadly, identify whether it means solar heating, photovoltaic electricity or concentrating solar power before comparing output or costs.
The U.S. Energy Information Administration glossary defines active solar through mechanical circulation of heated fluid or air. This is a useful starting point for interpreting “active versus passive” specifications. It prevents a pump-based heating system from being confused with the photovoltaic conversion process.
Define the useful output first. A solar hot-water project and a PV electricity project can use the same roof while solving different energy needs.
PV cells convert incident light directly into electricity. An inverter, tracker, pump or battery has a separate function; adding one does not explain how the photovoltaic effect works. Not every array tracks the sun, and not every PV installation includes storage.
How an Active Solar Heating System Works
A collector absorbs solar energy and transfers heat into a suitable medium. Powered circulation carries that heat toward a storage vessel or thermal load. The released design may use a heat exchanger to separate circuits, and controls manage operation according to the equipment and system arrangement.
The DOE distributed-energy guide distinguishes pumped solar hot-water systems from passive arrangements. Treat that distinction as a mechanism description, not evidence that every active design has the same efficiency or maintenance cost.

This qualitative diagram shows the boundaries to identify in an active solar heating assessment. It does not represent a specific plumbing design.
- Collect solar heat
Record collector type, location and the thermal output being assessed.
- Circulate the medium
Identify pumps, fans, controls and their electrical consumption.
- Store or transfer heat
Record the tank, heat exchanger and distribution boundaries that apply.
- Serve the load
Check required temperature, demand timing and auxiliary heat provision.
DOE solar hot-water overview and editorial boundary checklist
The steps explain energy accounting. Freeze protection, overheat protection, pressure limits and commissioning require the specific design and manufacturer instructions.
Air-based heating uses air rather than a liquid circuit as the heat-transfer medium. That changes the equipment and distribution questions. It does not remove the need to account for fan electricity, heat delivery and when the receiving building needs heat.
For either arrangement, specify which output the estimate describes. Energy collected at the roof, energy entering a tank and energy delivered at the load are not interchangeable results. Losses between those boundaries may change how much conventional heating the installation can displace.
Active Solar Versus Passive Solar
Passive solar heating uses building design and natural heat movement for the specified function. A passive water-heating arrangement can circulate through a thermosiphon rather than a powered pump. The EIA glossary identifies thermosiphon circulation with temperature and density differences between fluids.
Classification belongs to the function, not merely the presence of equipment. A building can use passive shading, pumped solar water heating and PV electricity together. Calling the entire building active or passive can conceal those separate pathways.
| Question | Active heating | Passive heating |
|---|---|---|
| How is heat moved? | Powered circulation for the stated function | Natural movement and building/system arrangement |
| What input needs accounting? | Solar input plus relevant auxiliary electricity | Solar input and the specified passive heat pathway |
| What must the designer identify? | Controls, distribution and useful output boundary | Geometry, materials and natural circulation/transfer conditions |
| Does the label prove financial value? | No; assess the actual loads and installation | No; assess the actual loads and building constraints |
Neither category supplies useful heat on demand regardless of solar resource. Storage and auxiliary heating may help bridge a mismatch between collection and demand, but their capacity and operating arrangements must be defined.
Keep Solar Technology Pathways Separate
“Solar” names an energy source, not one equipment architecture. The DOE concentrating solar-thermal overview explains how mirrors direct sunlight to a receiver and the resulting heat can serve a power cycle or thermal application. That differs from both rooftop water heating and direct photovoltaic conversion.
| Technology | Conversion pathway | Output to declare |
|---|---|---|
| Pumped solar thermal | Sunlight → collected heat → circulated medium → load | Useful thermal energy at a stated temperature and boundary |
| Photovoltaics | Sunlight → DC electricity → supported electrical conversion | DC or AC energy at the declared meter/model boundary |
| Concentrating solar thermal | Concentrated sunlight → receiver heat → power cycle or thermal load | Electrical or thermal output, with the pathway identified |
| Combined PV-thermal collector | Electricity plus recovered heat | Electrical and thermal outputs reported separately |

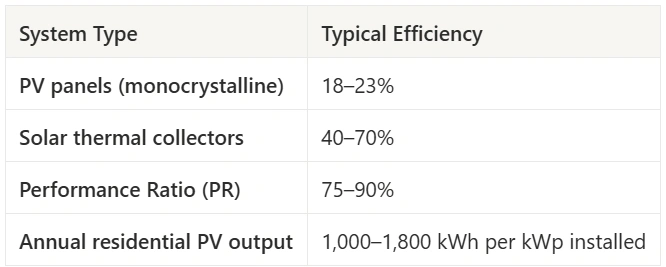

A thermal efficiency percentage and an electrical efficiency percentage do not establish which option serves a customer better. First identify the load, useful temperature, timing and alternative supply. Keep pump electricity and auxiliary heating visible rather than treating all collected heat as a net benefit.
Read solar thermal, solar water heaters and solar energy for the related definitions. Their purposes differ even when the equipment shares a site.
Bounded Calculations: State the Assumptions and Boundary
The following examples are hypothetical. They preserve useful calculation methods without implying a measured installation, equipment approval or guaranteed saving.
Illustrative PV Energy Estimate
Assume a 5 kWp DC array, annual plane-of-array irradiation of 1,500 kWh/m², reference irradiance of 1 kW/m² and an AC performance ratio of 0.80. These are teaching inputs, not a location’s verified resource or a recommended universal ratio.
Reference yield = 1,500 kWh/m² ÷ 1 kW/m² = 1,500 hours.
Estimated AC energy = 5 kWp × 1,500 hours × 0.80 = 6,000 kWh/year.
The units cancel to energy. Irradiation is accumulated energy per area; irradiance is power per area. If the assumed performance ratio already accounts for a loss, deducting that same loss again would double-count it. Actual production needs site-specific weather, geometry, shade and equipment modeling.
Illustrative Collector Energy Estimate
Assume 10 m² of collector area receives 4 kWh/m² over one day and has an assumed collection efficiency of 0.50. Collected heat is 10 m² × 4 kWh/m² × 0.50 = 20 kWh during that day.
The result is collected heat, not necessarily useful heat delivered to a tap or process. It excludes downstream losses, pump electricity and auxiliary supply. The assumed collection fraction is not a benchmark for a particular collector; its suitability depends on conditions and the required temperature.
Common Mistakes When Describing Active Solar
Calling all equipment-dependent solar systems the same technology. Specify the collection, conversion and delivery path. A PV array supplying a water-heating appliance is not automatically a solar-thermal collector.
Comparing efficiency without comparing useful output. A high collection fraction at a temperature below the load requirement does not establish usable process heat. An electrical kWh can serve a different set of devices from a thermal kWh at a particular temperature.
Treating stored energy as continuous availability. A tank or battery has limited capacity and losses. Demand, weather, control settings and available backup supply determine whether the load can be served.
Converting annual production directly into savings. Savings depend on the conventional energy displaced, coincidence with demand, tariffs, operating costs and eligibility conditions. Do not assign a payback period from the term “active solar.”
Practical Guidance
For Designers
Record the thermal and electrical loads separately. Identify the required output temperature, demand schedule and measurement boundary before sizing equipment. Compare the modeled or documented delivered output with the load rather than comparing collector area alone.
Specify which uncertainties need site evidence. Collector access, roof condition, shading, pipe routes and equipment locations may affect feasibility. Follow the appropriate professional design process for thermal, structural and electrical work.
For Installers
Use the issued design and model-specific instructions. Freeze protection, stagnation/overheat behavior, fluid compatibility and pressure limits depend on the equipment and climate. A generic internet mixture, roof load or test setting is not a commissioning specification.
Confirm where each component sits in the energy pathway. Record substitutions and obtain the required review before changing a pump, collector, inverter or storage arrangement. Preserve the as-built documents needed for maintenance.
For Sales Teams
Ask whether the customer wants electricity, hot water, space heating or a combined service. Explain the appropriate output unit and boundary. Present modeled values as estimates and keep installation, maintenance, auxiliary energy and financial assumptions visible.
When evaluating a PV design workflow, confirm the required inputs and outputs. Ask which technologies and models are supported before treating a platform as a solar-thermal or CSP simulator.
How SurgePV Fits This Decision
SurgePV’s solar designing workflow is relevant to the PV geometry and layout part of a project. Bring the actual module data, site constraints and required outputs to the evaluation. This entry does not assert that SurgePV designs or simulates a complete pumped solar-thermal circuit or concentrating solar power plant.
Request a demonstration to check the supported workflow against the project’s scope. Thermal engineering and component approval remain separate questions where they are outside that scope.
Frequently Asked Questions
What is the difference between active and passive solar?
In heating, active solar uses powered circulation for the stated heat-transfer function. Passive approaches rely on natural movement and building or system design. Identify the function before classifying a whole installation: one building can combine passive shading, pumped solar heating and photovoltaic electricity without those becoming the same pathway.
Does active solar always need outside electricity?
Powered pumps, fans or controls need an energy supply, but its source depends on the arrangement. A PV cell’s light-to-electricity conversion does not itself need an external electrical input. Distinguish the collection or conversion mechanism from the electricity used by the system’s circulation, controls and other auxiliary equipment.
Which solar technology is most efficient?
Compare the same useful output, operating conditions and measurement boundary. A thermal collector and a PV module do not deliver interchangeable services merely because both report percentages. Required temperature, demand timing, conversion losses and auxiliary energy all affect the practical comparison; no universal efficiency ranking answers every project.
Can active solar provide energy whenever it is needed?
Solar collection depends on the available resource. Storage and auxiliary supply can change when useful output reaches a load, but they have defined capacities and operating limits. Assess demand timing and the complete configuration before promising service during an outage, overnight period or sequence of cloudy days.
Is active solar worthwhile for a home or business?
Assess the actual electrical and thermal loads, resource, space, installed scope and operating costs. Compare useful delivered output with the conventional energy it would displace. Tariffs, maintenance and verified incentives belong in that analysis; the active-solar label alone does not establish savings, payback or a suitable technology choice.
Related Glossary Terms
About the Contributors

Co-Founder · SurgePV
Akash Hirpara is identified by SurgePV as a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; education, certifications, project totals, financial results, speaking engagements, and media appearances are not asserted without retained evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
