Quick answer
PV array DC nameplate capacity divided by the associated nominal AC inverter capacity, also called DC/AC ratio; a sizing descriptor, not a loss or approval threshold.
Answer: Inverter loading ratio (ILR) is the PV array’s DC nameplate capacity divided by its associated nominal AC inverter capacity. A 10 kW DC array with an 8 kW AC inverter has an ILR of 1.25. The ratio describes installed ratings; it does not independently establish clipping, annual energy, equipment compatibility, warranty coverage or an optimal economic design.
Calculate using matching system boundaries
ILR = array DC nameplate power / nominal inverter AC power
Use consistent units and include the inverter capacity associated with the array being described. A plant-wide average can conceal different loading on individual inverters. Record the module count and rating, inverter count and nominal AC rating, and whether any equipment is excluded.
PVsyst’s PNom-ratio definition uses STC array power and nominal inverter AC power. It distinguishes that nominal rating from conditional higher AC output described by a PMax parameter. Do not silently substitute a temporary maximum-output figure for the denominator.

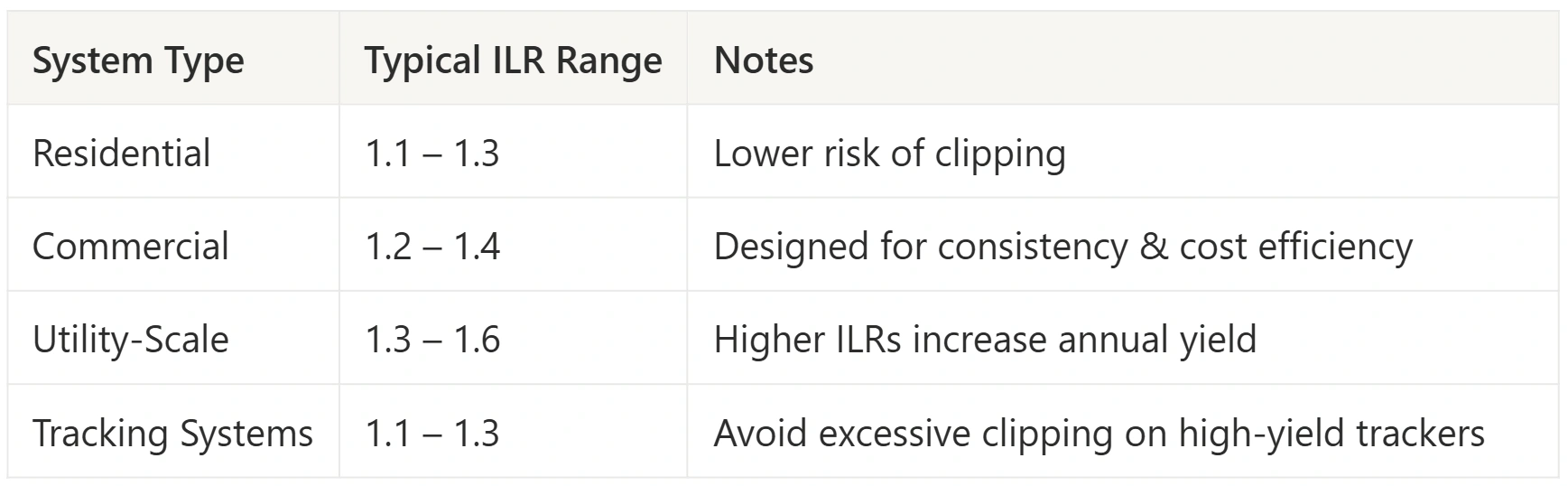

Two ways to increase the ratio have different consequences
Consider these hypothetical equipment-rating alternatives:
| Option | DC nameplate | Nominal AC rating | ILR | What changed? |
|---|---|---|---|---|
| A | 100 kW | 100 kW | 1.00 | Starting arrangement |
| B | 100 kW | 80 kW | 1.25 | Smaller AC inverter rating; array unchanged |
| C | 125 kW | 100 kW | 1.25 | Larger DC array; inverter rating unchanged |
B and C share the same ratio, but they do not contain the same equipment or promise the same annual energy. The previous assertion that a higher ratio always increases total production overlooked this distinction.
Changing equipment cost and energy output requires actual quotations and simulations. The table contains ratings only; it is not an Austin project result or evidence of savings. An ILR of 1.25 also does not mean that 25% of annual energy will be clipped.
Clipping depends on time-series operation
Inverter clipping occurs when available PV power cannot be taken through a limiting inverter operating condition. Its energy impact depends on the time profile and equipment model. Orientations, irradiance, cell temperature, inverter conversion and operating limits affect the result.
PVsyst’s array-sizing documentation distinguishes a preliminary power-distribution estimate from detailed simulation. A single ratio or a sizing histogram should not be treated as a complete annual loss forecast. The same source describes balancing modeled overload loss against inverter cost; it does not supply a universal economic optimum for every site.
Grid export curtailment and inverter temperature derating are separate effects to identify. A DC-coupled battery may change dispatch, but its power limit, capacity, state of charge and topology determine whether it can accept otherwise constrained energy. A battery does not guarantee recovery of every clipped unit.
The ratio does not replace equipment checks
Review the exact current module and inverter instructions and applicable project requirements:
- Cold-condition string open-circuit voltage against the inverter’s absolute maximum input voltage.
- Operating voltage over the relevant conditions against the applicable MPPT operating window.
- Operating and short-circuit current limits for the actual input and tracker allocation.
- Manufacturer PV-power recommendations or contractual restrictions where applicable.
- Output conditions, thermal behavior, grid requirements and documented warranty terms.
Maximum open-circuit voltage is not simply an MPPT-window check; the previous guidance conflated them. Dividing nameplate powers cannot verify these separate quantities.
PVsyst’s inverter parameter documentation distinguishes recommended or contractual PV-power parameters from voltage, current and AC output parameters. Read the supplied equipment’s wording. Neither “every inverter has the same maximum ratio” nor “anything above 1.5 voids the warranty” is justified universally.
Compare candidate designs with an explicit objective
Hold the weather, geometry, shading, component definitions and output boundary consistent where possible. Declare whether the study fixes DC array capacity, AC inverter capacity, export capacity or available roof area. Without that constraint, a comparison can confuse array expansion with inverter replacement.
For each candidate retain:
| Result | Why it belongs in the comparison |
|---|---|
| Equipment ratings and compatibility record | Separates a ratio from an acceptable design |
| Annual and seasonal delivered energy | Shows the complete modeled outcome |
| Clipping and other constrained-energy categories | Makes boundaries and exclusions visible |
| Capital and maintenance quotations | Provides actual cost inputs |
| Tariff or PPA time profile | Establishes the value of delivered energy |
| Lifetime assumptions and uncertainty | Makes the economic comparison reproducible |
Choose the project’s objective explicitly, such as lifecycle cost or net present value. One objective does not automatically optimize another. Use the NPV definition for the discounted-value calculation rather than claiming a ratio guarantees a faster payback.
When evaluating solar design software, request representative candidate outputs and verify their assumptions. This guide does not establish any product’s automatic clipping or string-validation capability.
Questions about ILR
Is ILR the same as DC/AC ratio?
For the stated PV array DC-nameplate-to-nominal-inverter-AC definition, yes. Check the document’s system boundary and ratings. The existing DC/AC definition uses the same basic concept.
Does degradation reduce the installed ILR each year?
Not when ILR is defined from original installed nameplate ratings. Actual available power and clipping can change with degradation and other conditions, but that does not silently change the equipment-rating ratio. Label a different aged-power ratio separately.
Is there a universal recommended ILR?
No value independently validates every equipment combination or economic objective. Use the project constraints, equipment requirements and time-series comparison.
Does the utility export limit equal the inverter rating?
Not necessarily. A controlled export limit at the connection point may differ from installed inverter capacity. Record both rather than substituting one for the other without explanation.
Source review: September 30, 2026. Rating examples are hypothetical; qualified project design and actual supplier terms remain necessary.
