★ Bonus Chapter 6 free resources print ready

Free Solar Installation Checklists, Worksheets & Templates

Six practical tools that put the Solar Installation Hub into action. Print them, fill them in, and use them on every job.

Keyur Rakholiya

Keyur Rakholiya

Founder & CEO · Updated Mar 13, 2026

The best installers don't rely on memory. They use the same structured checklists on every job — whether it's a 4 kWp residential system or a 200 kWp commercial roof. Consistency catches the faults that experience misses. These six resources distill the full Solar Installation Hub into formats you can print, fill in, and take to site.

All resources are free. No email required. Click any "Print / Save as PDF" button to open your browser's print dialog and save as a PDF.

What's in this resource pack

  • Resource 1: Pre-Installation Checklist — 50 items across 9 categories
  • Resource 2: Roof Assessment Scorecard — 5-category scoring system, 100 points
  • Resource 3: System Sizing Worksheet — 7-step calculation template with peak sun hours table
  • Resource 4: IEC 62446 Commissioning Checklist — all required pre-handover tests
  • Resource 5: Client Handover Pack — fill-in template for system documentation
  • Resource 6: Annual Maintenance Schedule — 12-month calendar template

How to Use These Resources

Each resource maps to a specific phase of the installation workflow. Use them in sequence — the pre-installation checklist before any work begins, the roof scorecard during site assessment, the sizing worksheet during system design, the commissioning checklist before handover, and the handover pack and maintenance schedule at the customer handover meeting.

Phase Resource Who uses it
Site assessment Roof Assessment Scorecard Installer, surveyor
System design System Sizing Worksheet Designer, installer
Pre-installation Pre-Installation Checklist Project manager, installer
Commissioning IEC 62446 Commissioning Checklist Qualified installer / electrician
Handover Client Handover Pack Installer, customer
Ongoing (customer) Annual Maintenance Schedule System owner

For solar design software that automates the design stage — including system sizing, shading analysis, and proposal generation — SurgePV handles the digital workflow. These printable resources cover the on-site stages that software can't do for you.

Resource 1 — Solar Installation Pre-Start Checklist

50 items across 9 categories. Work through every category in order before any installation begins. A missed permit or an unverified string configuration can cost days of rework. This checklist exists so nothing gets skipped under time pressure.

Solar Installation Pre-Start Checklist 50 items · 9 categories · SurgePV 2026
A · Site Documentation 6 items
B · System Design Sign-Off 7 items
C · Permits & Approvals 6 items
D · Equipment Procurement 8 items
E · Safety Preparation 6 items
F · Installation Day Morning 5 items
G · Electrical & DC Work 6 items
H · Commissioning Tests 6 items
I · Client Handover 5 items

Resource 2 — Roof Assessment Scorecard

Use this before any system design work. A roof that scores below 55 should not proceed to design until the problem is resolved — whether that's unexpected shading from a new extension, a structurally compromised roof section, or an orientation that makes the project uneconomic. This scorecard gives you a defensible, documented basis for your recommendation.

Pro Tip

Run this scorecard during the site visit, not at the desk. Orientation and shading data change with surrounding trees, new construction, and rooftop obstructions that don't appear on satellite imagery.

Roof Assessment Scorecard Max 100 points · SurgePV 2026
Category Max pts Scoring criteria Your score
Orientation 25 South ±15° = 25 · SE/SW ±30° = 20 · E/W facing = 12 · North ±45° = 5 _____ / 25
Pitch / Tilt 20 30–35° = 20 · 20–45° = 15 · 10–55° = 10 · Flat (0–10°) = 7 _____ / 20
Shading (annual energy loss) 25 Under 2% = 25 · 2–5% = 20 · 5–15% = 12 · 15–30% = 5 · Over 30% = 0 _____ / 25
Structural condition 20 New or reroofed within 5 yrs = 20 · Good condition = 15 · Fair = 10 · Poor / unknown = 3 _____ / 20
Access & working space 10 Easy access all sides = 10 · One side restricted = 7 · Significantly restricted = 3 _____ / 10
Total Score 100 _____ / 100
85 – 100ExcellentProceed — ideal solar site
70 – 84GoodProceed — review any category below 14 pts
55 – 69FairDetailed review required before design begins
40 – 54MarginalSpecialist assessment recommended
Under 40Not recommendedDo not proceed without resolving root cause

Notes:

Site address: _______________________________________________
Assessor: _____________________ Date: _____________________
Key findings: _______________________________________________
Recommendation: _______________________________________________

Resource 3 — System Sizing Worksheet

This is the same calculation solar software runs automatically — written out step by step so you can explain it to customers, cross-check software output, or size a system without a computer when needed. Chapter 3 of this hub covers the full theory behind each step.

System Sizing Worksheet 7 steps · SurgePV 2026
1
Annual energy consumption
Find on electricity bills — 12-month total. Typical European home: 3,000–5,000 kWh/year.
Annual consumption = ____________ kWh/year
2
Set self-consumption target & calculate system production target
To cover 70% of consumption, multiply by 1.4 (system produces more than you use so surplus covers inefficiencies). To cover 100%, multiply by 1.5–1.7.
Production target = Step 1 × _______ = ____________ kWh/year
3
Peak sun hours for your location
Use the table below. For unlisted locations, use EU PVGIS.
Peak sun hours = ____________ h/year
City Peak sun hours/year City Peak sun hours/year
Munich, DE1,080Madrid, ES1,720
Berlin, DE1,000Barcelona, ES1,640
Hamburg, DE960Paris, FR1,060
Rome, IT1,480Marseille, FR1,400
Milan, IT1,200London, UK980
Naples, IT1,580Manchester, UK900
Amsterdam, NL950Warsaw, PL1,020
Brussels, BE980Lisbon, PT1,760
4
Performance ratio (system losses)
PR accounts for real-world losses: temperature, wiring resistance, inverter efficiency, soiling, and mismatch. Standard residential = 0.75. Well-optimised with microinverters or optimisers = 0.80.
Performance ratio = ____________ (typically 0.75)
5
Required system size (kWp)
This is the key formula. Divide the production target by the product of peak sun hours and performance ratio.
kWp = Production target ÷ (Peak sun hours × PR)
kWp = _______ ÷ (_______ × _______) = ____________ kWp
6
Panel count
Standard residential panels are 400–450 W. Divide system kWp by panel wattage (in kW).
Panel count = (kWp × 1000) ÷ panel watts = (_______ × 1000) ÷ _______ W = ______ panels
7
Roof area check
Standard panel footprint: 1.7 m × 1.0 m = 1.7 m². Compare available roof area against required. Allow 20–30% additional area for row spacing and access margins.
Required area = panels × 1.7 m² = ______ × 1.7 = ____________
Available roof area = ____________ m² → __________ (fits / does not fit)

Resource 4 — IEC 62446 Commissioning Checklist

IEC 62446-1:2022 specifies the minimum documentation and testing required before a PV system is handed to the end customer. Skipping any of these tests is not only a compliance failure — it's how undetected wiring faults, insulation breakdown, and reverse-polarity connections cause fires years later. This checklist covers all seven required test categories.

Important

This checklist is a reference guide, not a substitute for a full commissioning test report. All measured values must be recorded in a formal IEC 62446-compliant test report and signed by a qualified installer. In the UK, this must be an MCS-registered company. In Germany, a registered Elektrofachkraft.

IEC 62446-1 Commissioning Checklist 7 categories · SurgePV 2026
1 · Visual Inspection
2 · String Open Circuit Voltage (Voc) Tests

Formula: Expected Voc = Panel Voc(STC) × number of panels in string × temperature correction factor. Test at open circuit (before connecting to inverter).

String No. of panels Expected Voc Measured Voc Within 5%? Pass / Fail
String 1______ V___ VYes / No___
String 2______ V___ VYes / No___
String 3______ V___ VYes / No___
String 4______ V___ VYes / No___
3 · Insulation Resistance Test (IEC 62446 minimum: ≥1 MΩ)

Test voltage: 500 V DC. Short +ve and -ve before testing (test entire array positive conductors to earth, then negative conductors to earth). BIPV systems: ≥200 MΩ.

Measurement Test voltage Minimum threshold Measured value Pass / Fail
+ve conductors to earth500 V DC≥1 MΩ___ MΩ___
-ve conductors to earth500 V DC≥1 MΩ___ MΩ___
4 · Earth Continuity Test (maximum resistance: ≤1 Ω)
Test point Measured resistance Pass (≤1 Ω)?
Mounting rail section A to main earth bus___ Ω___
Mounting rail section B to main earth bus___ Ω___
Mounting rail section C to main earth bus___ Ω___
Sample module frame to main earth bus___ Ω___
5 · Polarity Check

Perform BEFORE connecting strings to inverter. A reverse-polarity string will immediately damage many inverter models.

6 · Functional Test (System Start-Up)
7 · Documentation Sign-Off

Resource 5 — Client Handover Pack

A professional handover document serves two purposes: it protects the customer (they have everything they need to maintain the system over 25 years) and it protects you (a signed document recording system condition at commissioning is your primary defence against future warranty disputes). Fill this in, print two copies, and have the customer sign both — one for them, one for your project file.

📋 Solar PV System — Client Handover Document 6 sections · SurgePV 2026
Section 1 · System Details
Installation address:
Installation date:System size: kWp
Installer company:
Installer cert. no.:MCS / local cert:
Section 2 · Equipment Register
Item Manufacturer Model Serial Number(s) Qty
Solar panels____________________________________
Inverter____________________________________
Battery (if fitted)____________________________________
Mounting system______________________N/A___
Monitoring device_________________________________1
Section 3 · Warranty Summary
Component Warranty type Duration Expires Claim contact
Solar panelsProduct warranty___ years______________
Solar panelsPerformance warranty___ years______________
InverterParts & labour___ years______________
Battery (if fitted)Capacity warranty___ years______________
WorkmanshipInstaller warranty___ years______________
Section 4 · Monitoring Setup
Platform / app name:
Login URL / app store:
Account email:

What to monitor: Check your dashboard once a month. Your system should produce roughly these amounts (kWh) on sunny days depending on season. If monthly production drops more than 15% vs the same month last year, contact your installer.

JanFebMarAprMayJunJulAugSepOctNovDec
____________________________________
Section 5 · What NOT To Do
Repair, modify, or open any electrical components — always use a qualified electrician
Pressure-wash panels — use a soft brush and purified water only, no detergent
Place ladders against panel frames — lean against mounting rails or use scaffold only
Ignore inverter fault codes or monitoring alerts for more than 48 hours
Connect additional loads or batteries to the system without consulting your installer
Plant trees or build extensions that will create new shading on the panels
Section 6 · Emergency Contacts
ContactNamePhoneEmail / Hours
Your installer (primary)_________________________________
Inverter support line_________________________________
DNO / Grid operator______________________24 hours
Emergency electrician_________________________________
Installer signature & date
Customer signature & date

Resource 6 — Annual Maintenance Schedule

Hand this to your customer at the commissioning meeting. A system owner who knows what to look for every month will catch problems early — and call you rather than a competitor when something needs attention. See Chapter 10 of this hub for the full maintenance guide with detailed explanations of each task.

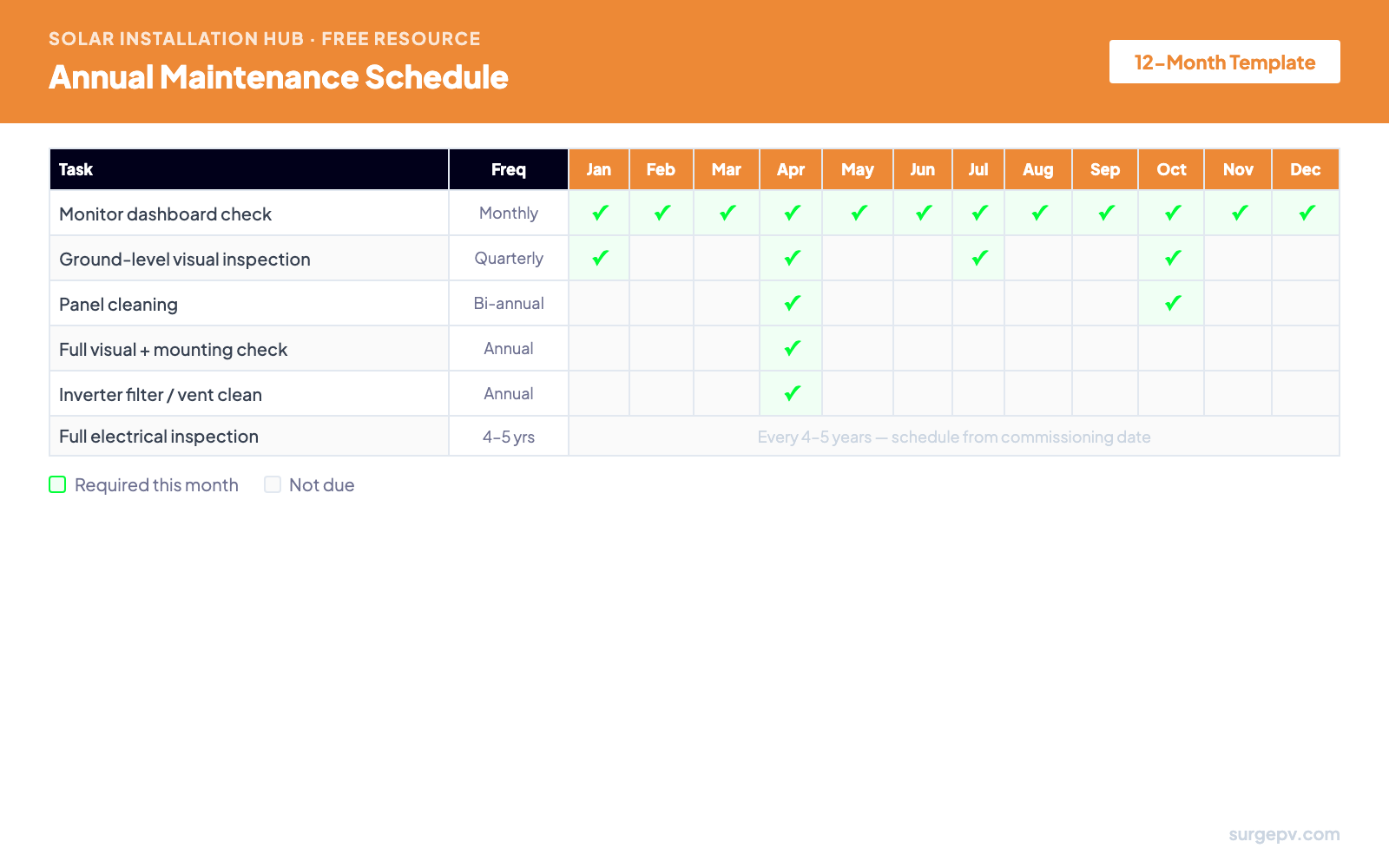

📅 Annual Maintenance Schedule 12-month template · SurgePV 2026
Task Frequency JanFebMarAprMayJun JulAugSepOctNovDec
Check monitoring dashboard — compare to same period last year Monthly
Ground-level visual inspection — panels, wiring, no debris or bird nests Quarterly
Panel cleaning — soft brush, purified water, no detergent Bi-annual
Inspect visible DC cable runs for damage, UV degradation, or chafing Bi-annual
Full visual inspection — mounting hardware, bolts, corrosion, sealants Annual
Inverter cooling vents / air filter — clean if dusty or blocked Annual
Export annual monitoring data — archive as CSV for warranty reference Annual
Full electrical inspection by qualified electrician — Voc, IR, earthing tests Every 4–5 yrs Schedule from commissioning date — Year 4–5, Year 9–10, Year 14–15, Year 19–20
After Extreme Weather Events — Inspect Immediately
Storm / high winds: Ground-level visual inspection for shifted panels, displaced mounting brackets, or loose cable clips
Hailstorm: Visual inspection for cracked glass — check monitoring data for any sudden output drop
Lightning strike (nearby): Do not restart system until a full electrical inspection has been completed
Heavy snow load: Wait for natural melt — do not attempt to remove snow from the roof. Once clear, check for any frame deformation

System commissioned: _______________    Next electrical inspection due: _______________

Installer contact for service: _____________________________________________

Design the System Before the Installation Begins

Every checklist above starts with a completed system design. SurgePV handles the full design workflow — roof modeling, panel layout, shading analysis, string configuration, energy simulation, and professional proposals — in one platform used by solar installers across Europe.

Book a Free Demo

No commitment required · 20 minutes · Live project walkthrough

Key Takeaways

  • A pre-installation checklist is the most effective way to prevent costly mid-installation problems — skipped permits and unverified string configurations are the most common causes of delays
  • The roof scorecard gives you a defensible, documented basis for recommending or not recommending solar on a specific roof
  • IEC 62446-1 commissioning tests are not optional — they are the legal minimum before handover in most European jurisdictions
  • A signed client handover document is your primary defence against future warranty disputes
  • Customers who receive the maintenance schedule are more likely to report problems early — and call you first

Frequently Asked Questions

Can I use these solar installation checklists on commercial projects?

Yes. All six resources work for both residential and commercial projects. Commercial projects may require additional steps — larger systems often need a DNO pre-application, structural load calculations, and extended permit timelines — but the core checklist categories apply to every installation. For commercial systems above 50 kWp, add categories for protection relay settings, AC busbar design, and earth fault monitoring.

Is the commissioning checklist compliant with IEC 62446?

The checklist covers the tests required by IEC 62446-1:2022 — visual inspection, string Voc verification, insulation resistance, earth continuity, polarity check, and functional testing. Cross-reference with the current published standard and your local certification body's requirements, as additional tests may be required in specific jurisdictions. In the UK, MCS requirements add further documentation obligations.

How do I print these resources as a PDF?

Click the "Print / Save as PDF" button under any resource. Your browser's print dialog opens. Select "Save as PDF" (Chrome) or "Microsoft Print to PDF" (Edge) as the destination. Set margins to "Minimum" or "None" for best results. The page is formatted to print cleanly on A4 or US Letter paper.

What score means a roof is not suitable for solar?

On the Roof Assessment Scorecard, a score below 55 means a specialist assessment is required before any design work begins. Scores below 40 indicate the project should not proceed without resolving the root cause — typically severe shading that cannot be mitigated, a structurally compromised roof, or an orientation so poor that the system would never generate a positive return.

Where can I find peak sun hours data for my location?

The sizing worksheet includes a reference table for 16 European cities. For any unlisted location, use the EU PVGIS tool — enter your coordinates and it returns annual irradiance data for any location in Europe, Africa, and Asia. The "H(i)" figure in the results (in kWh/m²/year) is your peak sun hours figure for this worksheet.
