Answer
Size a shopping mall solar system to the daytime common-area and tenant load, not to the roof area. Rooftop and carport arrays both work, but the tenant billing model, structural review, fire-code access and shading decide the design. Start with at least 12 months of interval data for every utility account, then choose the interconnection model.
Last updated: November 2026. SurgePV publishes this post and sells solar design software.
Retail buildings account for roughly 14 percent of all electricity used in U.S. commercial buildings, according to the U.S. Energy Information Administration (2023). An enclosed mall averages a site energy use intensity of 65.7 kBtu per square foot per year, and a strip mall averages 103.5 kBtu per square foot per year, according to ENERGY STAR (2024). At 65.7 kBtu per square foot, a 500,000 square foot enclosed mall uses about 32.9 million kBtu a year, or roughly 9.6 million kWh of total site energy. Electricity is only part of that total.
The solar opportunity is straightforward. Malls operate mostly during daylight hours, so solar production overlaps with load. Rooftop space is plentiful, and parking lots offer carport potential. The design problem is that a mall is not a single warehouse. It has anchor tenants with their own meters, common-area loads, rooftop HVAC units that cast shade, and a flat roof that may be 30 years old. Get any of those wrong and the project dies in interconnection review or in the property manager’s inbox.
SurgePV’s solar design software covers 3D roof modeling, array layout, shading analysis, energy-yield and financial modeling, and proposal generation. Its generation and financial tool can model tariffs and incentive assumptions that you supply. Results depend on source data and engineering review.
In this guide:
- Why shopping malls are strong solar candidates in 2026
- How enclosed malls differ from strip malls in design
- Step 1: site data and roof readiness
- Step 2: roof layout, setbacks, and mounting
- Step 3: shading, stringing, and inverter topology
- Step 4: interconnection and tenant billing models
- Step 5: financial model and incentive stack
- Common shopping mall solar design mistakes
- Where design software fits in mall solar work
- FAQ with 7 shopping mall solar questions
Why Shopping Malls Are Strong Solar Sites in 2026
Commercial solar had a record third quarter in 2024. The segment installed 535 MWdc, up 44 percent year-over-year and 17 percent quarter-over-quarter, according to the SEIA / Wood Mackenzie U.S. Solar Market Insight Q4 2024. Malls are a large, underutilized slice of that market. Their roofs are flat, their loads are daytime, and their owners are under pressure to cut operating expenses.
Costs have also moved in the owner’s favor. U.S. commercial PV system costs fell 77 percent between 2010 and 2024. They dropped from $6.83 per watt to $1.55 per watt, according to the NREL / DOE cost benchmark report (2025). The NREL / DOE Q1-2024 Solar Cost Benchmarks dataset puts the modeled market price for a 3 MWdc commercial system at $1.51 per watt. Those numbers help the economics of a mall project even before any federal credit.
- 2010 average$6.83
- 2024 average$1.55
- Q1 2024, 3 MWdc modeled price$1.51
Source: NREL and DOE cost benchmark report (2025), as cited in this guide, checked November 2026.
Electricity prices give the project its margin. U.S. commercial electricity prices averaged about $0.13 per kWh in 2024, according to the EIA Electric Power Monthly. Every kWh produced and consumed on-site avoids the full retail rate, plus demand-charge relief at the margin. Exported kWh are usually worth far less, which is why mall solar design starts with self-consumption, not annual offset.
| Mall subtype | Typical size | Site EUI (kBtu/ft²/yr) | Calculated annual site energy | Design driver |
|---|---|---|---|---|
| Enclosed regional mall | 500,000 to 1,000,000 ft² | 65.7 (ENERGY STAR) | about 9.6 to 19.3 million kWh | Common-area plus anchor tenant allocation |
| Strip mall | 20,000 to 150,000 ft² | 103.5 (ENERGY STAR) | about 0.6 to 4.6 million kWh | Multiple tenant meters and leases |
Site energy is calculated as size times EUI, converted at 3.412 kBtu per kWh. It includes all fuels, so electricity use will be lower, and climate, hours and tenant mix change it. Use your own meter data for design. Outlet centers and power centers vary too widely to give a single published figure here.
The Engineering Difference: Enclosed Malls vs. Strip Malls
Not all malls behave the same way. The two dominant forms, enclosed malls and strip malls, create different design constraints.
An enclosed mall is usually a single large building with a common owner or management company. The roof is continuous, the HVAC is centralized or semi-centralized, and the electrical service is often split between common areas and anchor tenants. The design task is to allocate solar benefits across those accounts. The roof is typically clear of tenant equipment, but it is crowded with RTUs, exhaust fans, and skylights that cast shade.
A strip mall is a row of separate retail suites under one roof plane. Each suite may have its own meter, its own lease, and its own operating hours. The property owner often pays only the common-area meter for parking, signage, and hallway lighting. The design task is to decide whether the solar serves the common-area meter, individual tenants, or the whole building through a virtual net metering tariff.
| Factor | Enclosed mall | Strip mall |
|---|---|---|
| Ownership | Single owner / management | Multiple tenants + landlord |
| Meters | Common + anchors | Many individual tenant meters |
| Roof complexity | High RTU density, fewer parapet issues | Simpler roof, more varied hours |
| Best billing model | VNEM or master-meter allocation | Master-meter or direct tenant subscriptions |
| Carport value | High, large parking fields | Moderate, smaller lots |
| Anchor tenant risk | High, anchor leases drive allocation | Lower, individual suite turnover |
For a broader retail lens, see solar design for retail. The multi-tenant billing principles discussed below apply directly to mall projects.
Model your mall’s load against solar output
Book a SurgePV demo to run shading analysis and energy-yield modeling on a mall roof and test tariff assumptions.
Book a DemoChecking cost first? See the SurgePV pricing page · No commitment required · 20 minutes
Step 1: Site Data and Roof Readiness
The first step in solar design for shopping mall is not layout. It is data collection. Request at least 12 months of 15-minute or hourly interval data for every utility account. Monthly bills hide the daily peaks and the weekend lull that determine solar value. You also need:
- Gross and conditioned floor area by tenant
- Roof age, membrane type, and warranty status
- Structural as-builts and live-load capacity
- HVAC type, schedule, and planned replacements
- Electrical service size, switchgear layout, and spare breaker space
- Existing and planned EV chargers
- Lease terms for anchor tenants and common-area maintenance clauses
A roof near the end of its life should usually be re-roofed before solar is installed. Removing and reinstalling a PV array to replace a membrane adds cost and loses production during the work. Carports become the better path when the roof is old but the parking lot has many years of life.
Structural load is the next gate. Ballasted systems add more dead load than attached systems, and the exact figure depends on the racking and layout. A structural engineer should verify capacity against the original design loads and any degradation. If the building predates modern seismic or snow-load standards, the answer may be no without reinforcement. In those cases, a solar design and engineering consultancy can support feasibility studies and structural calculations.
Electrical capacity matters just as much. A 1 MWac system on a 480 V service draws roughly 1,200 amps. The existing switchgear, transformers, and feeders must handle that current without overloading. Early engagement with the utility prevents redesign later.
Step 2: Roof Layout, Setbacks, and Mounting

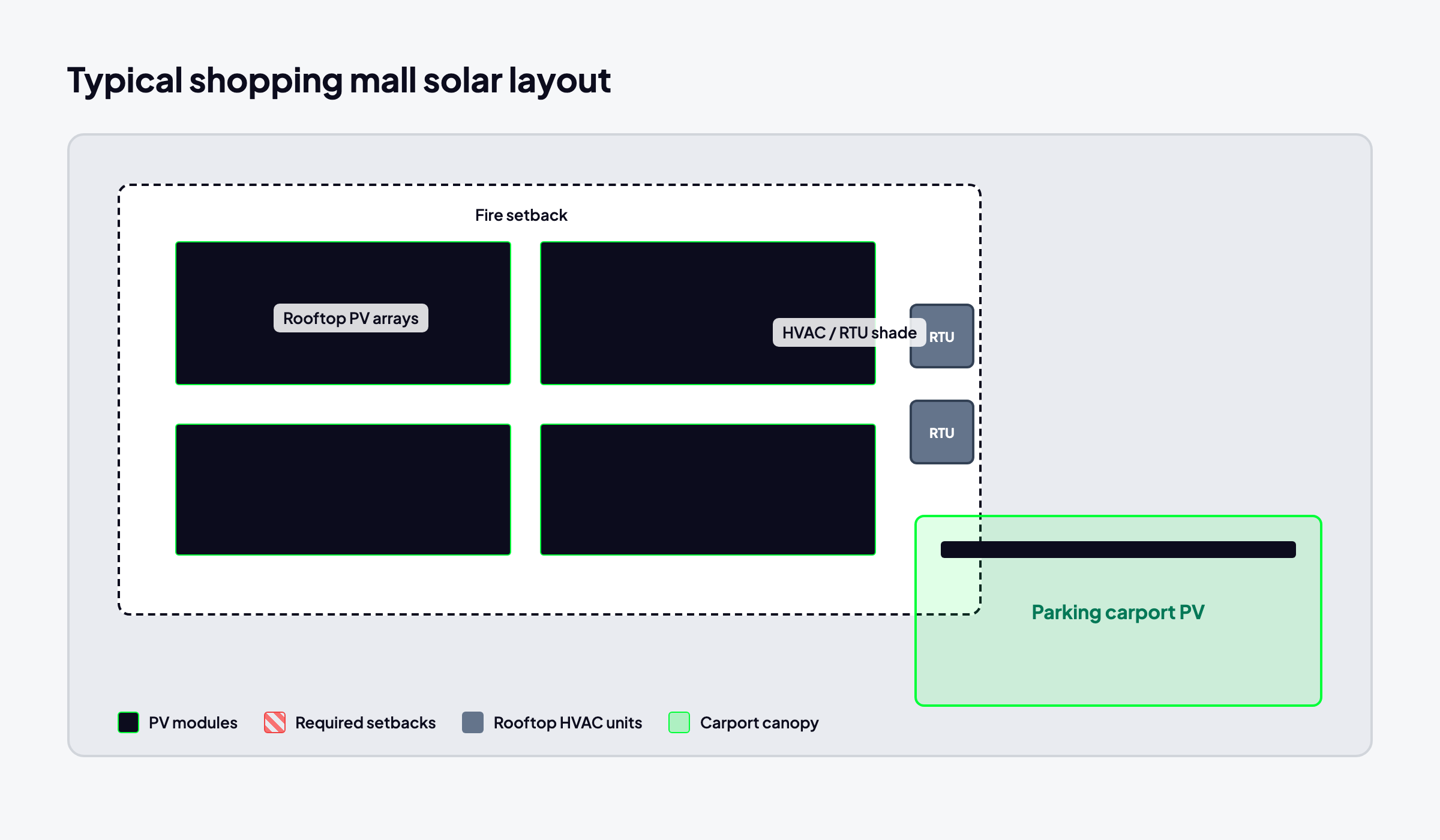

Once the roof is cleared structurally, the layout phase begins. The goal is to maximize usable module area while leaving the access paths that firefighters, HVAC technicians, and roofers need.
The International Fire Code and local amendments govern rooftop PV access. Check the edition your AHJ has adopted for the exact pathway, setback and clearance dimensions, which vary by edition and jurisdiction. Rules in this area usually cover:
- Perimeter pathways around the roof
- Setbacks from ridges and hips on pitched roofs
- Clear access to rooftop equipment and vents
- Access paths between module rows on large arrays
These rules are not suggestions. An AHJ can reject a permit that blocks access. A good layout tool models setbacks as exclusion zones before any panels are placed.
Mounting choice depends on the roof. Ballasted racking works on flat TPO, EPDM, or modified bitumen roofs with adequate load capacity and no penetration concerns. Attached rail systems anchor to structural decking and are preferred in high-wind or seismic zones. Tilted racking increases winter production but adds wind load and row spacing. South-facing 10-degree tilt is common for flat roofs in the U.S.
East-west layouts are often better for malls than pure south. A mall’s load is flat across business hours. An east-west array produces a broader, flatter generation curve that matches that load and reduces clipping losses. It also packs more watts onto the roof because row spacing is smaller.
Carport design is a parallel exercise. Column spacing must match parking bay widths. Clearance height must allow delivery trucks and emergency vehicles under local rules. Double-cantilever canopies cover two rows of parking with a single row of columns. Carports usually cost more per watt than rooftop, but they add shade, EV charging space and tenant goodwill.

Step 3: Shading, Stringing, and Inverter Topology
Shading is the silent killer of mall production. Rooftop HVAC units, exhaust fans, parapet walls, and nearby buildings cast moving shadows across the array. A single shaded module on a long string can drag down the whole string if the system uses only string inverters. The fix is to model shade early and design around it.
Use a shadow analysis tool that imports LiDAR, satellite imagery, and drone data. SurgePV’s product scope includes 3D roof modeling and shading analysis, which feed the energy-yield estimate. Check shade loss by string against your inverter topology.
Inverter topology should match the shade risk:
- String inverters with power optimizers: best for large, mostly unshaded roofs where some equipment shade exists. Optimizers keep each module at its maximum power point.
- Microinverters: best for complex roofs with multiple orientations and heavy partial shade. Higher cost per watt, but the lowest string-loss risk.
- Central string inverters: best for wide, open roof areas with uniform tilt and minimal shade. Lowest cost per watt, but highest sensitivity to mismatch.
For a 1 MW mall roof, a common approach groups unshaded south-facing sections under central string inverters. It uses optimizers or microinverters around RTUs and parapets. This hybrid design balances cost and resilience.
String voltage and inverter input windows must be checked against local temperature extremes. Cold mornings raise module open-circuit voltage. Hot afternoons lower current. The string design must stay within the inverter’s maximum input voltage at the coldest expected temperature and above the minimum start voltage at the hottest.
Step 4: Interconnection and Tenant Billing Models
A mall solar array is physically connected to one meter, but the building may have a dozen accounts. The interconnection model decides who gets the financial benefit. The three main options are master-meter pass-through, virtual net metering (VNEM), and direct submetering.
Master-meter pass-through is simplest when the property owner holds the single utility account. Solar offsets that bill, and the owner passes savings to tenants through a Ratio Utility Billing System (RUBS) or a fixed green-lease addendum. The owner keeps the tax credits and depreciation. The risk is lease turnover: a new tenant may refuse the solar charge.
Virtual net metering lets one solar system feed the grid through a production meter while the utility splits kWh credits across multiple accounts. VNEM availability varies by state and utility, so check the tariff. It is the cleanest path when the mall has multiple meters behind one service delivery point. The allocation table is filed with the utility, and credits appear on each tenant’s bill.
Direct submetering installs private revenue-grade meters and bills tenants directly for solar energy. It offers the highest precision but adds hardware, software, and ongoing billing overhead. It works well where VNEM is not available and the owner wants full control.
Read more about net metering and virtual net metering in our glossary. For VNEM-specific design, see multi-tenant commercial solar design.
Pro Tip: Get Anchor Tenants to Sign Early
Share the allocation table based on interval consumption with each anchor tenant before design is final. A tenant that agrees to the method early rarely stalls the project at the lease stage.
Anchor tenants are the wild card. A department store with its own meter and a 20-year lease may want its own allocation. A food court with high evening load may benefit less from daytime solar. The allocation table should reflect actual interval consumption, not only square footage. An unfair allocation is the most common reason mall solar projects fail at the lease stage.
Step 5: Financial Model and Incentive Stack
The financial case for mall solar rests on three numbers: installed cost, production, and value of avoided electricity. Here is a worked example for a 1 MWdc rooftop system on an enclosed mall. Inputs are illustrative assumptions from the sources noted, not a real project.
| Input | Value | Notes |
|---|---|---|
| System size | 1,000 kWdc | Rooftop, south-facing 10° tilt |
| Installed cost | $1.55/Wdc | NREL / DOE Q1-2024 commercial benchmark |
| Gross cost | $1,550,000 | Before incentives |
| Federal ITC | 30% (assumed) | Section 48E, if the project qualifies under current rules |
| Net cost after ITC | $1,085,000 | Depreciation may add value; confirm with a tax advisor |
| Annual production | 1,300 to 1,600 MWh | Assumed range; model with PVWatts or a yield tool |
| Electricity value | $0.13/kWh | EIA commercial average |
| Annual savings | $169,000 to $208,000 | Self-consumed kWh at retail rate |
| Simple payback | 5.2 to 6.4 years | Before depreciation and demand-charge benefit |
Demand charges add upside. Check your tariff for the demand charge per kW. For example, at an assumed $15 per kW per month, 100 kW of summer peak reduction saves $18,000 a year beyond the energy savings. Battery storage can increase demand-charge reduction, but it also extends payback unless the tariff rewards the peaks it can shave.
The IRS clean electricity investment credit page describes the credit as a 6 percent base, up to 30 percent for facilities that meet wage and apprenticeship rules, with 10-point adders for domestic content and energy-community siting. Federal legislation passed in 2025 changed solar eligibility timing, so check current IRS guidance and talk to a tax advisor before assuming the credit or a depreciation schedule. State and local incentives vary. DSIRE is the standard tracker.
Export value is the biggest sensitivity. On a net metering tariff, exports may be credited at retail. On net billing, exports are usually worth much less. Right-size the array so annual exports stay low. Oversizing to cover annual load is usually a mistake on a net billing tariff.
Key Takeaway: Right-Size Before You Maximize
Self-consumed kWh earn the retail rate and exports often earn less, so a smaller array with high self-consumption can beat a roof-filling one.
For more on commercial solar finance, read commercial solar monitoring ROI metrics and solar installation cost breakdown.
Run mall tariff assumptions before committing
Use SurgePV’s financial modeling to compare net metering and net billing assumptions on a mall-sized system.
Book a DemoChecking cost first? See the SurgePV pricing page · No commitment required · 20 minutes
Common Shopping Mall Solar Design Mistakes
The most expensive mistake is designing a mall project the same way you design a warehouse. Malls have people on the roof, tenants in the building, and complex utility bills. Here are common errors.
Mistake 1: sizing to annual load instead of daytime load. A mall’s annual load includes many hours when solar is not producing. An array sized to offset most of the annual load can export a large share of its output if the midday load is low. Always model interval data hour by hour.
Mistake 2: ignoring the roof replacement cycle. Installing solar on a 22-year-old TPO roof is a bet that the membrane will outlast the panels. It rarely does. Either re-roof first or move to carports.
Mistake 3: assuming one inverter per meter. The meter is a billing device. The inverter is an electrical device. A single inverter can serve multiple meters through VNEM, and multiple inverters can serve one meter. Do not let billing topology drive inverter placement.
Mistake 4: treating anchor tenants as passive participants. Anchor tenants can control a large share of the load. If they do not agree to the allocation method, the project stalls. Get their signature early.
Mistake 5: skipping the structural review. A flat roof does not mean it can carry ballast. Older malls may have been designed for lower live loads than current codes require. A structural letter is cheap insurance against a roof collapse or permit rejection.
One counterintuitive point is that mall solar can be more profitable when the array is smaller. A right-sized system with high self-consumption, no export losses, and low interconnection cost can deliver a better NPV than a maxed-out roof.
Where Design Software Fits in Mall Solar Work
Commercial mall projects move slowly enough without software friction. SurgePV’s product scope covers the design, simulation and proposal workflow in one cloud platform:
- Site modeling: 3D roof modeling and solar array layout.
- Shade analysis: shadow analysis of obstructions such as RTUs and parapets.
- Yield and tariff modeling: energy-yield and financial modeling with the net metering, net billing and incentive assumptions you enter.
- Proposals: branded solar proposals with production and financial summaries.
Tenant allocation tables, interconnection filings and engineering sign-off stay with the project team and the utility.
Design your next mall solar project
Import the site, model shade, size the array to the load and build a proposal in one workflow.
Book a DemoChecking cost first? See the SurgePV pricing page · No commitment required · 20 minutes
For teams that also need detailed engineering deliverables, an engineering consultancy can extend the workflow. To see the design workflow on your own mall roof, book a demo or see SurgePV pricing.
Frequently Asked Questions
How do you size a solar system for a shopping mall?
Size the array to the mall’s daytime load, not to the available roof. Start with at least 12 months of interval meter data for every account, then match midday production to common-area HVAC, lighting and tenant load. Check export value under the local net metering or net billing rules before fixing the kWp number.
How much does solar cost for a shopping mall?
Cost depends on system size, roof or carport structure, and market, so get current quotes. The NREL and DOE cost benchmark report, as cited in this guide, puts the 2024 US commercial PV system price at $1.55 per watt and the modeled price for a 3 MWdc commercial system at $1.51 per watt for Q1 2024. Carports usually cost more than rooftop because of the structure.
What is the best mounting option for shopping mall solar?
Rooftop is usually cheapest when the roof has plenty of life left and the structure can carry the load. Carports use parking-lot space, add customer shade and pair with EV charging. Many malls use both, with rooftop covering base load and carports adding visible capacity.
How do you handle multi-tenant billing for mall solar?
The three main models are master-meter pass-through, virtual net metering (VNEM) and direct submetering. VNEM is cleanest where the utility allows it, because one production meter feeds credits to several accounts. Master-meter needs lease language that lets the owner allocate savings, and submetering is precise but adds hardware and billing work.
Do shopping malls still save money with net billing instead of net metering?
Yes, if the array is sized for self-consumption. Malls consume most electricity during business hours, so solar output lines up with load. Net metering at retail rates is the best case, while net billing pays a lower export rate, so oversizing the array reduces savings.
What incentives are available for shopping mall solar?
The IRS describes the Section 48E clean electricity investment credit as a 6 percent base credit, up to 30 percent with wage and apprenticeship compliance, plus adders. Federal law passed in 2025 changed solar eligibility timing, so check current IRS guidance. State and local options include net metering, renewable energy credits and utility rebates, and DSIRE tracks them by state.
What roof condition and structural loading are needed for mall solar?
A structural engineer must confirm the roof can carry the array against the original design loads. A roof near replacement should usually be re-roofed first, or the project should move to carports. Use fire-code setbacks and access paths from the edition and local amendments your AHJ enforces.
Where this fits
