Answer
A solar continuity test checks that a PV system's earth and bonding conductors form an unbroken, low-resistance path. Test with the system off, use a low-resistance ohmmeter with zeroed leads, and record each value. Fluke's PV analyzer manual lists it with the IEC 62446-1 Category 1 tests. Check string wiring with polarity and voltage tests instead.
Continuity testing is one of the first electrical checks on a new PV system, done before anyone switches it on. A bond that looks bolted but is blocked by paint can leave a fault with no safe path to earth.
Last updated: November 2026.
This guide gives the test steps, explains which meter to use, and shows how to record results. It also covers how to check the DC string wiring, which needs a different method.
Show every earth point in the design
Plan strings, earthing hardware and the bill of materials in one design, so the crew and the tester work from the same drawing.
Book a DemoChecking cost first? See the SurgePV pricing page · No commitment required · 20 minutes
How to Do a Solar Continuity Test: 6 Steps
Protective earthing continuity is a dead test. The system must be off.
- Isolate. Open the inverter AC breaker. Open the DC isolators and disconnect the strings.
- Zero the leads. Short the two test leads together and zero the meter. This removes lead resistance from the reading.

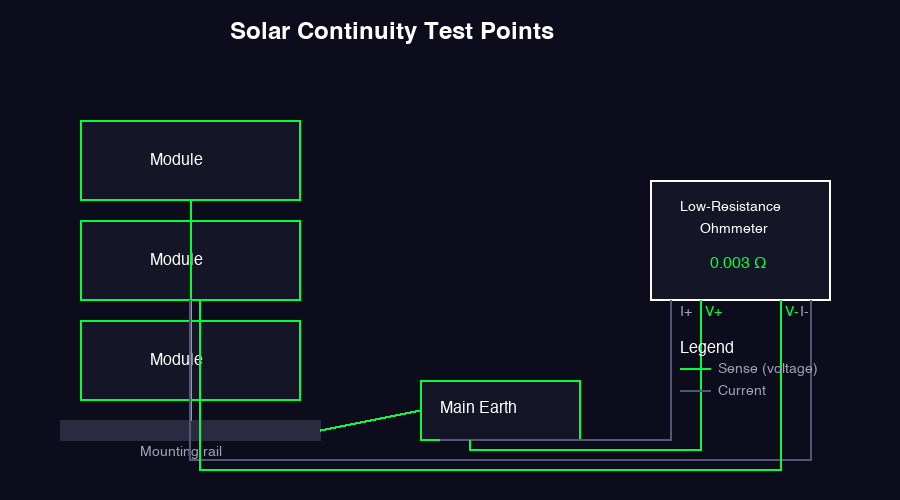

- Pick the reference point. Use the main earthing terminal (MET), the point where the earth conductors meet. It is usually at the distribution board or inverter.
- Measure each bond. Connect one lead to the MET. Connect the other to the part you test, such as a module frame, a mounting rail, the inverter case or a combiner box. Clean the contact spot first.
- Compare with the limit. Use the limit from your code, utility rules or project spec.
- Record it. Write down the spot, the value, the instrument and the date.
The Fluke SMFT-1000 manual describes this method. It connects one lead to the central protective earth point and the other to the module frame or rail. It measures with a test current of 200 mA or more, then repeats with the polarity reversed and shows the higher (worse) value.

What a Solar Continuity Test Measures
A continuity test checks that an electrical path is unbroken between two points. In a PV system, there are two different checks:
Protective earthing and bonding continuity. This checks that module frames, mounting rails, the inverter case and other exposed metal parts are connected to the main earthing terminal. If a live wire touches a frame, fault current needs a low-resistance path to earth so the protective device can trip.
String wiring. A PV string makes voltage in light. So you check it with polarity and voltage tests, not with an ohmmeter. See the string section below.
Fluke’s manual lists the IEC 62446-1 Category 1 tests as including visual inspection, protective conductor resistance, polarity, open-circuit voltage, short-circuit current and insulation resistance. It lists I-V curve tracing as the Category 2 test.
Why a Beep Is Not Enough
A frame can look bolted to a rail while paint or a coating blocks the bond. A reading shows what your eyes cannot.
Here is simple math. Take a 240 V circuit and a bond of 28 Ω: 240 ÷ 28 = about 8.6 A. A 20 A breaker will not trip at that current. Now take a bond of 0.1 Ω: 240 ÷ 0.1 = 2,400 A. This is a simplified check, because a real fault loop has other resistance. But it shows why the bond value matters.
Records also help you. A sheet with measured values, the instrument and the date is more useful for warranty or insurance questions than a sheet of ticks.
Which Meter to Use
Multimeter in Continuity Mode
A multimeter beeps when resistance falls below a set level. Fluke says that at a 400 Ω range, a multimeter typically beeps at about 40 Ω or less. That works for a blown fuse or a broken cable. It does not tell you if a bond is low enough to carry fault current.
A multimeter also uses two wires. Tektronix says typical lead resistance is 10 mΩ to 1 Ω. Lead resistance adds to a two-wire reading, so it can hide a small bond resistance.
The Seaward PV commissioning guide says a multimeter can show pass or fail on a de-energized circuit. It also says to zero the leads, keep the contact surface clean and test only de-energized circuits.
Low-Resistance Ohmmeter
A low-resistance ohmmeter uses four wires, called a Kelvin connection. One pair of leads sends a current. The other pair reads the voltage at the part under test. Tektronix says this removes the voltage drop in the test leads from the reading. Some PV testers, such as the Fluke SMFT-1000, use a test current of 200 mA or more.
| Feature | Multimeter, continuity mode | Low-resistance ohmmeter |
|---|---|---|
| Typical beep level | About 40 Ω on a 400 Ω range | Set by you |
| Lead resistance in reading | Yes, with two wires | No, with four-wire leads |
| Best use | Quick check on a dead circuit | Bonds you must record |
These figures come from the Fluke and Tektronix pages linked in this section and the table below. They are instrument facts, not pass limits for your site.
Key Takeaway
A two-wire beep tells you a path exists. It does not tell you the path is low enough to carry fault current. Use a four-wire low-resistance ohmmeter for any bond you must record.
What to Test and Where the Limit Comes From
IEC 62446-1:2016 sets out the information and documents to hand over after a grid-connected PV install. It also describes commissioning tests and inspection (IEC webstore). We could not read the standard’s text, which is sold by IEC. So this page gives no fixed pass number for earth bonds. Use the limit in your code, utility rules or contract.
| Check | Instrument | How the result is judged |
|---|---|---|
| Earthing and bonding continuity (Clause 6.1) | Low-resistance ohmmeter | Limit from your code, utility or project spec. Fluke’s tool sets it from cable length, cross-section and material |
| Polarity (Clause 6.2) | Voltmeter or PV tester | Positive reading is correct. For readings above 5 V, Fluke’s tool passes a positive reading and fails a negative one |
| String combiner check (Clause 6.3) | Voltmeter or PV tester | Fluke’s manual says each string should be within ±15 V of the strings measured before it |
| Open-circuit voltage (Clause 6.4) | PV tester | Should match the sum of the module voltages in the string |
| Short-circuit current (Clause 6.5.2) | PV tester | Compare with the module datasheet |
Source: Fluke SMFT-1000 Multifunction PV Analyzer Users Manual (11/2022). The manual describes the clause numbers and checks.
For the insulation test, see our insulation resistance test guide. For polarity, see the polarity test guide.
Plan strings and earthing before the crew arrives
SurgePV supports string and electrical design workflow and bill-of-materials output. Ask in a demo how it fits your commissioning records.
Book a DemoWant pricing first? Visit the SurgePV pricing page · Live project walkthrough
How to Read Your Readings
Compare each bond with the others on the same rail. If one bond is far higher than its neighbors, find the cause, even if it is under the limit.
Some common reasons for a high reading:
- Coated metal. Seaward’s guide says test leads may need a filed or ground spot on coated metal parts.
- A dirty or poor lead connection.
- Leads that were not zeroed.
- A loose lug or clamp.
- A path that was never measured. A frame may be bonded to a rail, but the rail may not be bonded to the next rail or to the main earth. Test each part of the path.
Never test a live circuit. Seaward’s guide says to do continuity and resistance tests only on de-energized circuits.
Pro Tip
Measure every bond on one rail in a single pass, then compare the values side by side. A reading that sits far above its neighbours is the one to open up, even if it is under the limit.
How to Check String Wiring
Modules make voltage whenever light hits them. So you cannot put a meter in ohmmeter mode across an exposed string. Use the polarity and voltage checks instead.
- Polarity. Check that the positive and negative wires go to the right place at the combiner box and inverter.
- Open-circuit voltage (Voc). Fluke’s manual says this checks that strings are wired correctly and that the expected number of modules are in series.
- Short-circuit current (Isc). Compare the result with the module datasheet. Fluke’s manual says this test is not a measure of module performance.
You can work out the expected Voc like this:
Expected Voc = module Voc × number of modules × [1 + (T_module − 25) × temperature coefficient of Voc]
Use the temperature coefficient from the module datasheet. It is a negative number, so the result goes up when the module is cold. For the full test order, see our solar system commissioning protocol.
If a cable run is fully disconnected from every module and from the inverter, you can check it with an ohmmeter. Do not do this on a string connected to modules.
Code and Standards Notes
- IEC 62446-1:2016. The IEC webstore describes it as the information and documents to hand over to a customer after a grid-connected PV install, plus commissioning tests and inspection criteria. It replaced IEC 62446:2009.
- US. Seaward’s guide says NEC Article 690 covers special requirements for PV systems, with grounding in Part V, and Article 250 covers general grounding and bonding. That guide cites older NEC editions. NFPA lists 2026 as the current edition and 2023 as the one before it. Check the edition your AHJ enforces. For other rules, see our NEC 690.8 circuit sizing guide and our guide to India CEA technical standards.
- Maintenance. IEC 62446-2 covers maintenance of grid-connected PV systems.
Design and Documentation
Good commissioning starts in design. The single line diagram (a simple drawing of how the system is wired) should show every earth point and bond jumper. If a point is not on the drawing, the crew may not install it, and the tester may not check it.
Design software can output a bill of materials (BOM) that includes grounding hardware. SurgePV supports electrical workflow and BOM output. For a wider look at tools, read our guide to software for solar systems.
Keep a record with each project. Include:
- A marked-up single line diagram that shows test points
- A table of measured values, with the spot, value, instrument and date
- Instrument calibration certificates, if the instrument has them
- Ambient temperature and weather
- Photos of any defects you fixed
Conclusion and Next Steps
A solar continuity test proves that the earth and bonding paths in a PV system are complete before you switch it on. It also gives you a record.
Key points:
- Use a low-resistance ohmmeter with zeroed, four-wire leads for bonds you must record.
- Record the measured value, not only a pass or fail tick.
- Check string wiring with polarity, Voc and Isc, not an ohmmeter on a live string.
- Clean contact points before you measure.
- Show test points and grounding details on the design drawings.
Three actions for your next project:
- Update your checklist. Add the steps above: isolate, zero, measure, compare, record.
- Review your drawings. Make sure the single line diagram shows each earth point and bond path.
- Write down your limit. Name the code or contract clause behind it, so every tester uses the same number.
For a full walkthrough, see our solar panel installation guide and solar commissioning checklist. To see how SurgePV handles electrical design and bill-of-materials output, book a demo.
Further Reading
The continuity test is one item on a longer list. See the solar commissioning checklist for the full handover order.
Frequently Asked Questions
What is a solar continuity test?
A solar continuity test checks that the protective earthing and equipotential bonding conductors of a PV system form complete, low-resistance paths. Fluke’s manual lists this test, to IEC 62446-1 Clause 6.1, with the Category 1 tests. String wiring is checked with polarity and voltage tests.
What instrument should I use for a solar continuity test?
Use a low-resistance ohmmeter with four-wire leads when you need an exact reading of a bond. Zero the leads first. A multimeter in continuity mode is fine for a quick check of a de-energized circuit, but its beep only means the reading is below the meter’s threshold.
What is the acceptable continuity reading for a solar installation?
There is no single number for every project. The limit comes from your code, standard, utility or project spec. Fluke’s PV analyzer manual says its limit depends on the length of the cable used in the test, and lets you set cross-section and material.
How do you test string continuity on a solar PV system?
Do not use an ohmmeter on a string connected to modules, because modules make voltage in light. Check polarity, then measure open-circuit voltage (Voc) and short-circuit current (Isc) and compare them with the expected values.
Can you use a multimeter for solar continuity testing?
Yes, on a de-energized circuit for a quick check. At a 400 Ω range, a typical multimeter beeps at about 40 Ω or less, according to Fluke. A beep does not prove a bond is good enough to carry fault current.
What standards cover solar continuity testing?
IEC 62446-1:2016 covers documentation, commissioning tests and inspection for grid-connected PV systems. In the US, NEC Article 250 covers grounding and bonding and Article 690 Part V covers PV grounding, per Seaward’s guide, which cites an older NEC edition. Check the edition your AHJ enforces.
How often should solar continuity tests be repeated?
The first test is done at commissioning. IEC 62446-2 covers maintenance of grid-connected PV systems. Check the schedule in your contract, your operations and maintenance plan, and local rules.
