Quick answer
A solar-storage topology in which PV and battery power-conversion systems exchange power through an AC connection; compatibility, metering and backup operation require a supported design.
What Is an AC-Coupled System?
Answer: In AC-coupled solar storage, the PV system and battery system exchange power through an AC connection. The PV inverter converts solar DC to AC, while the storage power-conversion system charges and discharges its battery through that AC network. This can support a retrofit, but equipment compatibility, metering, protection and outage operation must be verified for the specific design.
Coupling describes the connection topology. It does not mean any solar inverter works with any battery inverter, or that the devices operate without coordination. An AC inverter may be integrated into a storage product rather than supplied as a separate external box.
Trace the Energy Path
For solar energy routed through storage, the conceptual path is:
PV DC → PV inverter → AC network → storage charging conversion → battery → storage discharge conversion → AC load.
Solar consumed directly by a load does not pass through the battery pathway. Dispatch settings determine charging, discharge and export; loads are not always physically served “first” by a universal rule.
An AC-to-AC battery round-trip efficiency normally uses an AC charging boundary. A PV-DC-to-eventual-AC-load pathway additionally includes the PV inverter. Label those scopes rather than presenting their percentages as interchangeable.
For a hypothetical complete stored-energy sequence, assume 10 kWh PV DC input, 97% PV conversion, 90% AC-to-AC storage efficiency, no additional losses and matching initial/final stored energy:
Eventual AC output = 10 × 0.97 × 0.90 = 8.73 kWh.
The PV-to-stored-load pathway is 87.3% in this illustration; the assumed AC-to-AC storage figure remains 90%. Neither figure describes every AC-coupled system or its annual performance.
Retrofitting Existing PV
AC coupling can retain an existing PV inverter because storage joins on the AC side. This can be useful where preserving the array and its working conversion equipment matters. It does not guarantee no rewiring, downtime, panel modification, permit changes or new calculations.

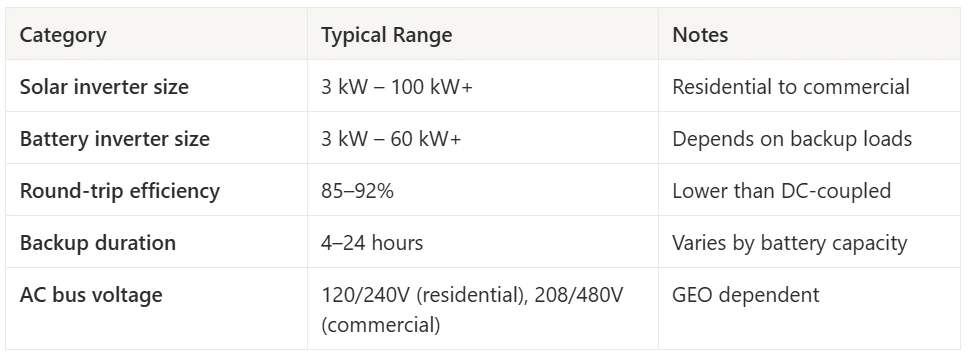

Review the existing inverter, service/panel arrangement, connection point, export permissions, metering and supported battery system. Separate power-conversion paths can allow different PV and battery power ratings, but expansion still faces equipment and interconnection limits.
Compare it with DC coupling using the actual installed scope. No architecture is universally cheaper for every retrofit or new project.
Grid Operation and Backup Are Different Checks
On a live grid, the PV inverter follows the grid. During an outage, ordinary grid-following equipment cannot simply continue energizing the disconnected utility connection. A supported backup system needs isolation/transfer arrangements, a local voltage/frequency source, protection and coordinated sources and loads.
Backup-capable storage does not automatically mean the existing PV will operate in the island. The PV may be outside the backed-up network or unable to follow its control requirements. Full batteries and sudden load changes also require supported generation curtailment or disconnection.
As an exact vendor example, Victron’s Fronius AC-coupling guide specifies supported models, settings and size constraints. The Inverter RS Smart manual separately requires the external PV inverter to respond to its frequency adjustment and observes model-specific PV/battery sizing limits. These are not universal frequency settings or instructions for arbitrary brands.
Frequency shifting is one coordination method. Use the actual manufacturer’s supported method rather than assuming every system requires or supports the same implementation. Islanding-capable inverter and grid-forming inverter describe related functions, not automatic whole-building backup.
Practical Handoff and Incentives
Designers should retain the one-line topology, permitted equipment/firmware combination, AC ratings, supported control modes, energy boundaries and backup load requirements. A nominal battery kWh value does not establish AC output power or runtime.
Installers should follow the documented metering, protection, transfer and commissioning procedure. Do not use a generic “open the main breaker” instruction as an outage test. Transfer time and critical-load arrangements are product-specific; medical or interruption-sensitive equipment needs its own requirements assessed.
Sales teams should quote the actual equipment and installation scope, explain which loads and PV sources can operate during an outage, and state any runtime assumptions. Avoid universal cost ranges, guaranteed tariff savings or a fixed efficiency penalty.
For U.S. residential incentives, the IRS August 2025 termination guidance states that section 25D expenditures after December 31, 2025 are ineligible, using the installation-completion rule. Do not assume a new 2026 battery receives an automatic 30% residential credit. Commercial and other programs require their own current eligibility review; coupling topology does not establish qualification.
When evaluating SurgePV, ask which topology, equipment, dispatch and financial assumptions the workflow supports.
Common Questions
Can I add storage without replacing my PV inverter?
It may be possible through a supported AC-coupled design. Verify the connection, equipment and operational requirements rather than assuming every existing installation qualifies.
Is AC coupling always less efficient?
Compare the actual energy path and measurement boundary. Extra conversion can introduce loss, but no universal percentage difference follows from the topology alone.
Does AC coupling provide backup automatically?
No. Backup and islanded PV operation depend on the supported equipment, isolation, controls and design.
