Back to Blog
solar policy12 min read

Solar Incentives Oklahoma 2026: Net Metering and Costs

Oklahoma solar incentives in 2026: OCC net metering, the end of the federal residential credit, no state tax credit, and a sourced payback example.

Akash Hirpara

Written by

Akash Hirpara

Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Published ·Updated

Answer

Oklahoma solar incentives in 2026 come down to net metering for distributed generation up to 300 kW, avoided-cost export credits, voluntary RECs and USDA REAP for rural businesses. The federal residential tax credit ended for property placed in service after December 31, 2025, and no state tax credit turned up. Payback depends on your usage.

Last updated: November 2026

Oklahoma has strong sunshine, but the incentive stack for rooftop solar in 2026 is thin. The state has no income tax credit and, as far as the state sources opened for this update show, no statewide property or sales tax exemption for residential solar. The federal Residential Clean Energy Credit ended for property placed in service after December 31, 2025, per the IRS.

What Oklahoma does have is net metering for distributed generation of 300 kW or less, voluntary REC sales, occasional group-buy campaigns, and USDA REAP funding for eligible rural businesses and farms. Retail electricity is cheaper than in most states, which stretches payback. This guide covers each program, the federal change, and a worked cost and payback example built from sourced inputs.

For the national picture, see solar incentives in the USA and the state-by-state incentive overview. Installers modeling net metering, avoided-cost exports and utility rates in one proposal can use SurgePV’s solar design software and its generation and financial tool.

Model an Oklahoma project with no federal credit

Run yield, export credits and payback side by side before you quote a homeowner.

Book a Demo

Checking cost first? See the SurgePV pricing page · 20 minutes · Live project walkthrough

In this guide:

  • Oklahoma solar incentives at a glance
  • How Oklahoma net metering works and why exports earn less than retail
  • The federal credit change that reshapes 2026 economics
  • What Oklahoma does not offer, including the status of Senate Bill 237
  • RECs, community purchasing and USDA REAP
  • A worked cost and payback example
  • Financing options, sizing mistakes and how to apply

Oklahoma Solar Incentives at a Glance in 2026

Oklahoma is not an incentive-rich state. Solar pays here because of good sun and net metering, not because of rebates. The table summarizes what matters in 2026.

Incentive Type 2026 status What is published
Federal Section 25D residential credit Tax credit Ended IRS: not available for property placed in service after Dec 31, 2025
Federal Section 48E Commercial tax credit Active, deadlines apply Terminates for applicable solar facilities placed in service after Dec 31, 2027 unless construction began by July 4, 2026 (IRS Notice 2025-42)
Oklahoma net metering Bill credit Active Retail energy rate up to your consumption; excess at avoided energy cost (OCC)
Oklahoma state income tax credit Tax credit Not available None found
Statewide property or sales tax exemption for residential solar Tax exemption None found Standard 4.5% state sales tax applies (Oklahoma Tax Commission)
Voluntary RECs Performance credit Available Value depends on the buyer; treat as zero in a base case
Solarize OKC Group purchasing Past campaign (2022 to 2023) More than 150 contracts, up to 40% off retail (City of Oklahoma City)
USDA REAP Federal grant and loan Competitive Terms change by funding cycle; check USDA Rural Development

Oklahoma had 1,282 MWdc of installed solar and 16,453 installations, ranking 36th nationally, per SEIA’s Oklahoma state page (opened 4 November 2026). Solar supplied 1.69% of the state’s electricity on SEIA’s figure.

1,282 MWdc
installed solar in Oklahoma (SEIA)
16,453
installations in the state (SEIA)
36th
national ranking by installed capacity (SEIA)
1.69%
of state electricity from solar (SEIA)

Key Takeaway

Oklahoma solar works on sunshine and on-site use, not on incentives. With the federal credit gone and exports credited below retail, accurate modeling matters more than any rebate.

How Does Oklahoma Net Metering Work?

Net metering lets your solar output offset your own consumption on the bill. The Oklahoma Corporation Commission (OCC) net metering page says it is governed by 17 O.S. § 156 and OAC 165:40:9 and covers consumer-owned distributed generation of “300kW or less.” The page does not list which utilities participate, so check your own utility’s tariff, especially if you are served by a cooperative or municipal utility.

The structure has three parts:

  1. On-site offset: Your solar generation first serves your load, so every kilowatt-hour used on site avoids a purchase.
  2. Netting within the billing period: The OCC page says customers receive “full retail energy rates” up to their consumption in the period. Consumption beyond that is billed at the utility’s tariff.
  3. Export credit: Excess production is bought at the utility’s “avoided energy cost,” and the OCC says such purchases must be paid or credited during the next billing cycle. The purchase-rate rule does not define a dollar figure, so ask your utility for its current avoided-cost rate.

There is also a sizing limit. The OCC page states “The current peak load limit is 125%,” and the rule says a system above 125% of the customer’s peak load may be excluded from net metering and paid under a different tariff. See the net metering glossary entry for the general concept.

Pro Tip

Ask the utility for three things in writing before you size the array: the current avoided-cost rate, any enrollment fee, and whether the 125% peak-load test uses the last 12 months of demand data.

The Federal Credit for Homeowners Is Gone

The 30% Residential Clean Energy Credit (Section 25D) covered property installed from 2022 through December 31, 2025. The IRS credit page says it is “not available for any property placed in service after December 31, 2025.” That also means a battery added in 2026 does not get it. Property placed in service in 2025 is claimed for tax year 2025 on Form 5695, and the IRS says you claim the credit for the year the property is installed, not just purchased.

The change came from Public Law 119-21, the One, Big, Beautiful Bill Act, enacted July 4, 2025. For commercial, leased and power-purchase-agreement systems, IRS Notice 2025-42 explains that the Section 48E credit terminates for applicable solar facilities placed in service after December 31, 2027. The notice says that date applies to facilities whose construction begins after July 4, 2026. A third-party owner that qualifies may pass part of that value to the homeowner through a lower payment, but terms vary by provider.

For cash and loan buyers, every Oklahoma proposal should lead with bill savings, net metering terms and financing, not with a federal credit that no longer applies.

What Oklahoma Does Not Offer

Some national guides list Oklahoma as having property and sales tax breaks for residential solar. No such statewide residential exemption turned up in the state sources opened for this update. Check with a tax professional and your county assessor before promising one.

Property Tax

17 O.S. § 156 governs net metering, not property tax, so it is not a basis for a property tax exemption. The one related program is the manufacturer ad valorem exemption aimed at large solar generation and battery storage facilities. Senate Bill 237 would have ended it for solar and battery projects with a January 5, 2028 sunset. The Oklahoma Legislature’s bill record shows it was sent to the Governor on May 14, 2026 and then “Pocket veto 06/01/2026.” Check the record for any later action, since press coverage in May described the bill as heading to the Governor.

Sales Tax

The Oklahoma Tax Commission states that sales tax is levied at 4.5% of gross receipts from the sale of tangible personal property, and local sales taxes are added where they apply. Budget for the state rate plus local tax unless a tax professional confirms an exemption for your project.

State Tax Credit or Rebate

No Oklahoma state income tax credit or cash rebate for residential solar turned up in the sources opened for this update. Net metering and voluntary RECs are the main state-level support.

RECs, Community Purchasing and Rural Grants

A few smaller programs can help project economics.

Voluntary Renewable Energy Certificates

Oklahoma has no renewable portfolio standard that creates an active SREC market, so any REC income comes from voluntary buyers. Prices depend on the buyer and the contract, and no published benchmark is cited here. Leave REC income out of the base-case payback and treat it as a possible bonus. Read the REC glossary entry for how certificates work.

Solarize Oklahoma City

Solarize OKC was a community group-purchasing campaign. The City of Oklahoma City lists it as running 2022 to 2023, with more than 150 contracts and the highest available discount of 40% off regular retail prices. Check with the city and local sustainability offices to see whether a similar campaign is open.

USDA REAP for Rural Properties

The USDA Rural Energy for America Program supports renewable energy systems and efficiency improvements for agricultural producers and rural small businesses. Grant percentages, award caps and funding windows change by cycle, and USDA Rural Development’s REAP page is the place to check the current terms. REAP is competitive, so verify eligibility with the local USDA state office before counting it in a proposal. For farm projects, see solar ROI for agriculture.

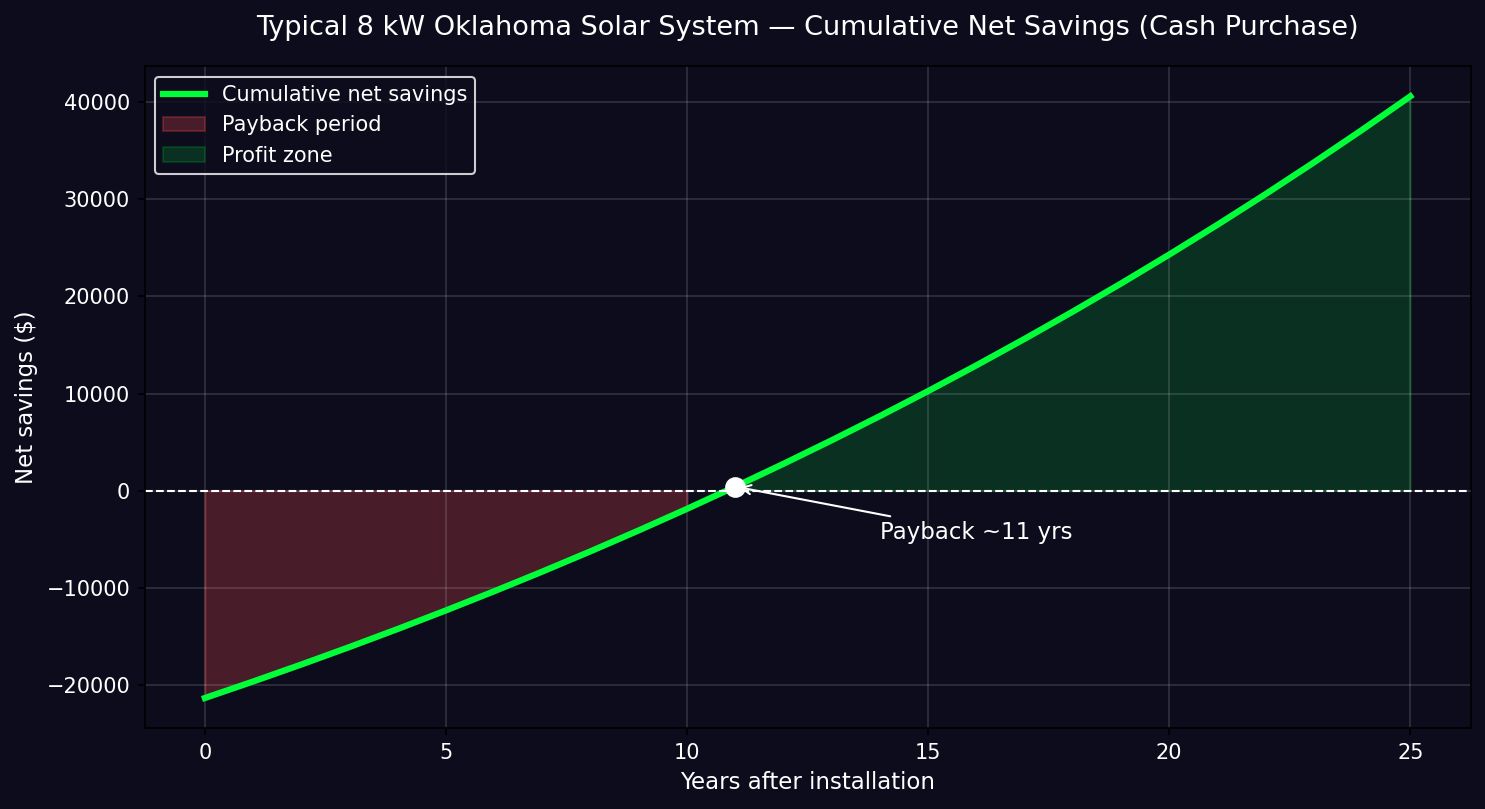

Cost, Payback and ROI: A Worked Example

The numbers below form an illustrative example built from published inputs. They are not a quote or a forecast.

Input Value Source or basis
System size 7.0 kW SolarReviews Oklahoma average system size
Gross cost $19,618 ($2.64 per W) SolarReviews Oklahoma average, November 2026
Federal residential credit $0 IRS: ended after 2025
Annual production 10,691 kWh NLR PVWatts v8 API, Oklahoma City, 180 degree azimuth, 20 degree tilt, 14% losses, run 4 Nov 2026
Residential price offset 14.82 cents per kWh EIA Table 5.6.A, Oklahoma, August 2026 (preliminary)
Share used on site 85% (assumption) Your load profile will differ
Export credit $0.03 per kWh (placeholder) Ask your utility for its avoided-cost rate

On those inputs, 85% of production is 9,087 kWh, worth about $1,347 a year at 14.82 cents. The remaining 1,604 kWh exported at the placeholder $0.03 adds about $48. Annual value is roughly $1,395, so simple payback is about 14.1 years before degradation, rate changes and financing costs.

Two things move that number most: how much you use on site, and the export rate. Price per watt is a market average, so your quote will differ. The PVWatts figure is for one location and tilt. Change any input and the payback moves, which is why the generation and financial tool runs this arithmetic per site.

Average residential electricity price, Oklahoma vs U.S. (cents per kWh, residential)
  • Oklahoma, Aug 202514.42
  • Oklahoma, Aug 202614.82
  • U.S., Aug 202517.57
  • U.S., Aug 202618.16

Source: EIA Electric Power Monthly Table 5.6.A (released 23 October 2026; 2026 values preliminary), checked 4 November 2026.

Oklahoma’s price rose about 2.8% year over year in that table and sits below the national average. Lower rates mean each kilowatt-hour offset saves less, which lengthens payback compared with higher-rate states. The EIA table is updated monthly.

Key Takeaway

In this example the payback is about 14 years with no federal credit. Cheaper power and below-retail exports are the reason, so size for your own use rather than for export.

Test your own Oklahoma payback

Swap in your quote, tariff and export rate and see how simple payback changes before the customer asks.

Book a Demo

Want plan details? See the SurgePV pricing page · No commitment required

Financing Options in Oklahoma

With no federal credit for cash and loan buyers, financing structure matters more.

Cash purchase: Keeps all bill savings and any REC income. Lifetime savings are highest, but so is the upfront cost.

Solar loan: Spreads the cost over a set term, and the monthly payment may be lower than the electric bill. Interest raises total cost and lengthens payback.

Lease or PPA: No upfront cost. The third-party owner may claim the commercial credit while it lasts and sells power back at a fixed or escalating rate. Compare the escalator and term length carefully.

HELOC or home equity loan: May carry a lower rate than an unsecured solar loan. The homeowner owns the system and keeps the savings.

USDA REAP: For eligible agricultural producers and rural small businesses, a REAP grant can reduce project cost. Terms vary by cycle, so verify before you rely on it.

Common Mistakes to Avoid

  • Oversizing for export. Exports earn the avoided-cost rate, not retail. Size for your own use and treat exports as a small bonus.
  • Promising the federal credit. The residential credit ended for property placed in service after 2025. Promising it in 2026 is a consumer-protection risk.
  • Assuming retail credit on exports. Only consumption up to your usage is netted at the retail energy rate.
  • Ignoring co-op and municipal rules. The OCC page does not list participating utilities, so verify the tariff.
  • Skipping the utility application. Interconnection determines how exports are metered. Start early.

How to Apply for Oklahoma Net Metering

For most homeowners the installer handles the paperwork. The usual steps are:

  1. Check utility eligibility. Ask your utility for its net metering tariff, size limits and any fee.
  2. Size the system. Use 12 months of usage and a site-specific estimate from NLR’s PVWatts calculator.
  3. Submit the interconnection application. The installer files it with the utility before installation.
  4. Install and inspect. After permitting and inspection, the utility sets a bidirectional meter if needed.
  5. Receive Permission to Operate. After PTO, the system can export and credits begin.

Installers can add value by giving homeowners a one-page summary of their net metering terms, expected export share and how credits appear on the bill. The same approach carries over to neighboring markets such as Texas solar incentives.

Frequently Asked Questions

What solar incentives are available in Oklahoma in 2026?

Oklahoma’s 2026 solar support is limited to net metering, voluntary REC sales, occasional group-purchase campaigns and USDA REAP for eligible rural businesses and farms. The federal residential credit ended for property placed in service after 2025. No state tax credit turned up in the sources opened for this update.

Does Oklahoma have net metering?

Yes. The Oklahoma Corporation Commission says net metering covers distributed generation of 300 kW or less under 17 O.S. § 156 and OAC 165:40:9. Consumption is netted at the full retail energy rate, and excess is bought at the utility’s avoided energy cost. Check your utility’s tariff, because the OCC page does not list participating utilities.

Is there a state solar tax credit in Oklahoma?

No state income tax credit, rebate or grant for residential solar turned up in the sources opened for this update. The main state-level support is the net metering framework. Some rural businesses and farms may qualify for federal USDA REAP funding.

Is the federal solar tax credit still available in Oklahoma in 2026?

No for homeowners who buy with cash or a loan. The IRS says the Residential Clean Energy Credit is not available for property placed in service after December 31, 2025. Commercial and third-party-owned systems may still use the Section 48E credit, subject to the deadlines in IRS Notice 2025-42.

Does Oklahoma have a property or sales tax exemption for residential solar?

No statewide exemption for residential solar turned up in the state sources opened for this update. The Oklahoma Tax Commission states a 4.5% state sales tax rate plus any local tax. Check with your county assessor and a tax professional before relying on any exemption.

What is the typical solar payback period in Oklahoma in 2026?

It depends on system cost, electricity price and how much you use on site, so there is no single figure. In the worked example in this guide, simple payback is about 14 years with no federal credit. Run your own inputs, since Oklahoma’s residential price of 14.82 cents per kWh in August 2026 is below the 18.16 cent U.S. average.

What is the most common mistake when sizing solar in Oklahoma?

Oversizing for export. Excess production is bought at the utility’s avoided energy cost rather than the retail rate, so it is worth less than energy used on site. Size the system around your own consumption and treat export credits as a small bonus.

Conclusion

Oklahoma solar in 2026 depends on sunshine and on-site use, not on rebates. The federal residential credit has ended, the state offers no tax credit, and exports are credited at avoided cost.

  • Get your utility’s net metering terms and avoided-cost rate in writing before you design.
  • Model payback with zero federal credit and below-retail exports.
  • Build the proposal with SurgePV’s solar proposal software, or book a demo to walk through an Oklahoma project.
