Solar ROI for Cold Storage: Payback and Costs

Solar ROI for cold storage: why refrigerated warehouses suit behind-the-meter solar, how demand charges change payback, and a worked example.

Akash Hirpara

Written by

Akash Hirpara

Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Published ·Updated

Answer

Cold storage suits behind-the-meter solar because the load runs around the clock: EIA's 2012 survey shows refrigerated warehouses using 28.8 kWh of electricity per square foot versus 5.8 for non-refrigerated ones. Payback depends on your tariff and demand charges. In this guide's hypothetical example, simple payback is about 5 years if a 30% federal credit applies.

Solar ROI for cold storage is unusually strong because refrigerated warehouses are among the most energy-intensive commercial buildings. In the U.S. Energy Information Administration’s Commercial Buildings Energy Consumption Survey (2012, Table PBA4), refrigerated warehouses used 28.8 kWh of electricity per square foot, against 5.8 kWh for non-refrigerated warehouses. That is a continuous baseload that lines up well with daytime solar generation.

Last updated: November 2026

Cold storage operators also face rising utility rates, interconnection delays and pressure from customers to cut emissions. Solar is one of the few capital projects that addresses cost, rate exposure and emissions together, but only if the model is built on the facility’s own tariff and load.

This guide is for cold storage operators, facility managers, energy procurement teams and EPCs preparing commercial solar tenders. It explains how to calculate solar ROI for a refrigerated warehouse, why the numbers differ from generic commercial solar, how demand charges change the math, and how financing structure changes returns. SurgePV publishes this post and sells solar design software.

What this guide covers:

  • Why cold storage solar ROI differs from ordinary commercial solar
  • How refrigerated warehouses use energy and why load profile matters
  • The cost lines in a cold storage solar plus storage project
  • A worked ROI example for a hypothetical 200,000 square foot facility
  • Ownership, PPA and lease trade-offs
  • How demand charges and battery storage change returns
  • Federal credit status and depreciation questions for 2026
  • When cold storage solar ROI does not clear hurdle rates
  • Common modeling mistakes that cut ROI

Is your cold storage load a good solar fit?

Model your facility’s roof, shading and financials in one workspace, then compare ownership and PPA scenarios.

Book a Demo

20 minutes · Live project walkthrough · Checking cost first? See the SurgePV pricing page.

Why Cold Storage Solar ROI Is Different

Most commercial buildings use electricity during business hours and shut down at night, so a larger share of their solar output may be exported. Cold storage inverts that profile. Compressors, condensers and evaporators run continuously, which means most of the electricity produced by an onsite array can be used immediately at the retail rate.

High self-consumption is the first reason cold storage solar ROI can be stronger. The second is the bill structure. Industrial tariffs for refrigerated warehouses usually include three large components:

  • Energy charges: the per-kWh rate for electricity consumed
  • Demand charges: a monthly fee based on the highest short-interval kW
  • Transmission and distribution charges: fees for moving power across the grid

Envigilance reports that demand charges alone can make up 30% to 50% of a cold storage utility bill, citing Inertia Resources. Behind-the-meter solar avoids energy and delivery charges on the kilowatt-hours it produces, and a battery can shave the peaks that drive demand charges. A remote PPA or virtual PPA typically offsets only the energy charge, so the tariff structure matters when you compare options.

The third difference is scale. A large refrigerated warehouse often has a big, flat roof, which can support a commercial-scale array and, in some cases, a battery. Scale helps with installer economics, but structure, roof age and interconnection capacity decide what is possible, so each site needs its own assessment.

The fourth difference is resilience. A power outage at a cold storage facility can spoil inventory. Solar paired with storage can help keep refrigeration running during grid outages. That value is hard to model precisely, but it is often a deciding factor for operators with unreliable grids.

How Cold Storage Facilities Use Energy

A refrigerated warehouse is not a dry warehouse with extra air conditioning. It is a thermal system that works continuously. Understanding how it uses energy is the foundation of a credible ROI model.

Electricity use per square foot, warehouses (2012 survey) (kWh per square foot per year)
  • Refrigerated warehouse28.8
  • Non-refrigerated warehouse5.8

Source: U.S. EIA Commercial Buildings Energy Consumption Survey 2012, Table PBA4, checked November 2026.

Building type Electricity per square foot (kWh) Source
Refrigerated warehouse 28.8 EIA CBECS 2012, Table PBA4
Non-refrigerated warehouse 5.8 EIA CBECS 2012, Table PBA4

Key Takeaway

A refrigerated warehouse used about five times the electricity per square foot of a non-refrigerated one in the 2012 survey. The survey is dated, so use it for the ratio and use your own interval data for the model.

Chilled vs. Frozen Storage

Energy intensity rises as the storage temperature falls. Frozen rooms and blast freezers typically use more energy than chilled rooms, and the coldest rooms set the peak demand because compressors work hardest in summer. A mixed-temperature facility has a blended profile. A design that sizes the solar array only for the average load will miss the value of shaving those peaks. Our cold storage facility solar design guide covers the load side in more detail.

The Demand-Charge Problem

Cold storage loads are spiky. Compressors cycle, defrost cycles restart multiple units at once, and dock doors let in warm, humid air. A single short interval can set the billed demand for the whole month. Some tariffs include ratchet clauses that carry a high peak into later months, so read the tariff.

Envigilance quotes typical commercial demand rates of about $5 to $35 per kW per month, citing NREL. At an assumed $18 per kW, a 500 kW peak costs $108,000 per year before a single kilowatt-hour is billed. Solar reduces daytime peaks, and a battery can discharge during the highest peaks. Our guide to solar demand charge reduction and peak shaving explains the design logic.

Load Factor and Solar Fit

Cold storage facilities have high load factors, so solar generation coincides with consumption for much of the day. High self-consumption maximizes the value of each solar kilowatt-hour because onsite use avoids the retail rate plus delivery charges, while export at avoided-cost or wholesale rates is worth less. Check the facility’s interval data to see how much midday surplus you would really have.

The Cost Stack for Cold Storage Solar

A credible ROI model starts with an accurate cost stack. This guide does not publish market price ranges because no single sourced benchmark fits every site. Use quotes for the actual roof, and compare them with the quarterly PV system cost benchmarks on the National Laboratory of the Rockies (formerly NREL) solar installed system cost page.

Cost line What to get in writing
Modules and racking Module model, mounting system and roof attachment details
Inverters and switchgear Inverter model, monitoring and warranty terms
Installation and balance of system Structural, electrical and commissioning scope
Engineering and permitting Stamped drawings, interconnection studies and fees
Battery storage, if included Capacity, duration, warranty and replacement terms
Contingency and EPC margin Allowance and what it covers
Carport premium, if used Extra structure versus avoided roof work

Operating costs are lower but persistent: operations and maintenance, insurance, property tax treatment, inverter replacement and, with storage, battery replacement. Ask each bidder to state these assumptions. Under a PPA, many of them sit with the investor, but the host pays an energy rate that embeds the same costs plus investor return.

How to Calculate Solar ROI for a Cold Storage Facility

The cleanest way to value a cold storage solar project is a discounted cash-flow model. Inputs include capital cost, annual production, energy savings, demand-charge savings, tax credits, depreciation, O&M, financing and a discount rate. Outputs include simple payback, net present value (NPV) and internal rate of return (IRR).

Here is a worked example for a hypothetical 200,000 square foot refrigerated warehouse. Every number below is an assumption for illustration, not market data, and every site needs its own load and production model.

Assumption Value
Floor area 200,000 sq ft
Energy intensity 25 kWh per sq ft per year (5,000 MWh)
Average blended rate $0.14 per kWh
Demand charge $18 per kW per month
System size 1,500 kW DC
Specific yield 1,600 kWh per kW per year (2,400 MWh)
Self-consumption 90% (2,160 MWh onsite, 240 MWh exported at $0.04 per kWh)
Peak demand reduction 300 kW
Solar cost $1.50 per watt ($2,250,000)
Battery 500 kWh at $280 per kWh ($140,000)
Soft costs and contingency 12% of hard cost ($286,800)
Total project cost $2,676,800
Hypothetical year-1 savings, 1.5 MW cold storage example (USD per year, illustrative example not market data)
  • Onsite solar energy$302,400
  • Demand charge reduction$64,800
  • Export revenue$9,600

Source: Worked example in this guide using the assumptions above, checked November 2026.

Year-1 savings add up as follows: onsite solar 2,160 MWh at $0.14 is $302,400, export 240 MWh at $0.04 is $9,600, and demand reduction of 300 kW at $18 for 12 months is $64,800. Total year-1 savings are $376,800.

Result (simplified) With a 30% credit Without a credit
Net cost $1,873,760 $2,676,800
Simple payback 5.0 years 7.1 years
25-year IRR About 19.9% About 13.5%
25-year NPV at 8% About $2.1 million About $1.3 million

These results are simplified. They hold savings flat for 25 years and ignore O&M, degradation, rate changes, depreciation, financing and the year-end tax effects, so a full model will differ. The point is the spread: the credit moves payback by about two years in this example. SurgePV’s generation and financial tool supports this kind of financial modeling with your own tariffs and assumptions.

Pro Tip

Run the model three ways: with the credit, without it, and with the demand-charge savings cut in half. If the project only clears your hurdle rate in the first case, treat it as fragile and ask your tax adviser about timing.

Run this payback on your own roof and tariff

Build the design, the energy-yield estimate and the financial model for a real facility in one session, then compare financing options.

Book a Demo

No commitment required · 20 minutes · Checking cost first? See the SurgePV pricing page.

Ownership, PPA, Lease and Financing Trade-offs

The financing structure changes the headline ROI more than most design choices. Cold storage operators should model each option against their balance sheet and lease situation.

Structure Upfront Cost Who Owns Asset Tax Benefits Best For
Cash purchase Full Host Host may capture credits and depreciation Owner-occupiers with tax appetite
Debt financing Partial Host Host may capture tax benefits; debt adds interest Owners who want to preserve capital
PPA None Investor Investor may capture credits and depreciation Leased buildings or capital-constrained owners
Operating lease Minimal Lessor Lessor may capture tax benefits Short-term occupancy or simple accounting

Direct ownership can capture the full economic value, if the company can use the tax benefits. A company with limited federal tax liability may need a different structure, such as a transfer or partnership arrangement, so ask a tax adviser.

A behind-the-meter PPA preserves capital and fixes a long-term energy rate. It is often considered for operators in leased buildings or for owners who want O&M off their books. The trade-off is lower lifetime savings because the investor keeps the tax benefits and prices in risk. See our solar PPA pricing models guide.

A solar lease is the simplest structure but can cost more over its term. It suits operators who want a single line item and no asset management. For owners with a long hold period, compare purchase, debt and PPA side by side. Our solar financing options explained post covers the structures in more detail.

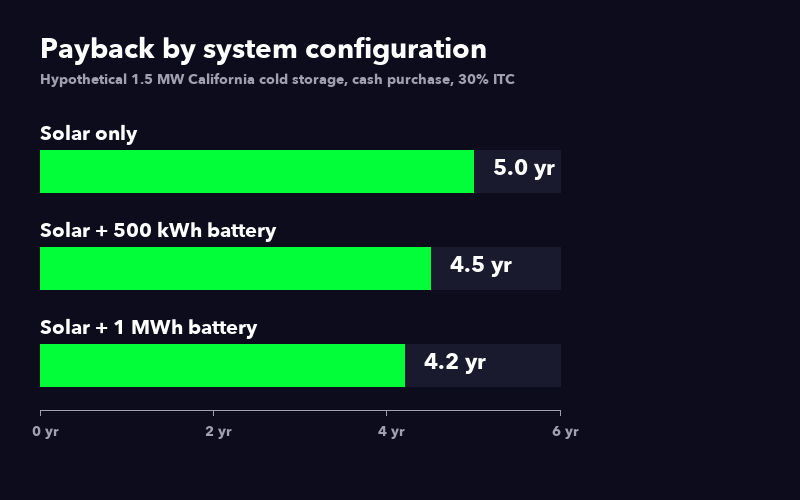

Battery Storage, Peak Shaving and Resilience

Cold storage operators often ask whether battery storage is worth the extra cost. The answer depends mostly on the demand-charge rate and the shape of the peaks.

A battery can discharge during the highest short-interval peaks. It can also store midday solar surplus and shift it into evening peak-rate periods. For cold storage there is a third benefit: backup power for critical refrigeration loads during an outage, which can matter more than the savings.

For a real-world data point, the Promise Energy website lists a Central Valley cold storage case study with a 1.5 MW rooftop solar system, an 800 kWh battery, $247,000 in annual savings, a 2.4-year payback and a 42% first-year ROI. The client is not named and the figures are the vendor’s own, so treat them as one reported result. Catalyze reports that businesses using solar plus storage save an average of $20,000 to $50,000 annually in energy costs, attributing the figure to a Wood Mackenzie study. That figure covers businesses generally, not cold storage specifically.

The exception is markets with low demand charges and strong net metering. In those, a battery may extend payback rather than shorten it. The right way to decide is to model the facility’s 8,760-hour load profile with and without storage.

Federal Incentives and Depreciation in 2026

Federal incentives for commercial solar changed in 2025, so check the current rules before quoting savings.

  • Investment credit (Section 48E): The IRS Clean Electricity Investment Credit page gives the base credit rules, including that the base amount is 6% of the qualified investment and can be increased for prevailing wage and apprenticeship compliance.
  • Deadlines: Per IRS Notice 2025-42, the credit terminates for applicable solar facilities placed in service after December 31, 2027, and this applies to facilities whose construction begins after July 4, 2026. A project either began construction by July 4, 2026 or must be placed in service by the end of 2027.
  • Bonus credits and depreciation: Domestic content and energy community adders, and the depreciation treatment of the system, depend on the project and current tax law. Have a tax adviser model them rather than relying on a rule of thumb.

State and utility programs vary. Check current options such as California’s Self-Generation Incentive Program, New York’s NY-Sun and Massachusetts’ SMART program, and confirm whether each is open to your project.

When Cold Storage Solar ROI Does Not Clear Hurdle Rates

Solar is not a universal winner. Several conditions can push payback beyond acceptable thresholds:

  • Low electricity rates and low demand charges: Behind-the-meter solar may not justify itself on savings alone.
  • Weak solar resource or heavy shading: Production can be well below sunnier markets, so run a shading analysis before pricing.
  • Short lease terms: A tenant with a short remaining lease cannot amortize a capital system. A PPA may still work if it is assignable.
  • Restrictive interconnection or export limits: Some utilities cap commercial solar size, impose standby charges or pay low export rates.
  • Roof condition: A roof that needs replacement soon adds cost to the project. Carports avoid the roof but cost more.
  • Credit deadlines: If neither the construction-start nor the in-service deadline can be met, the without-credit case is the one to underwrite.

The honest approach is to set a hurdle rate and run a sensitivity table. If the base case is marginal, do not force the project.

Common Mistakes That Cut Cold Storage Solar ROI

Even strong sites can produce disappointing returns if the model is wrong. Watch for these errors:

  1. Valuing solar at a flat avoided energy rate. Cold storage value includes energy, demand and delivery savings. Using only the energy rate understates the project.
  2. Ignoring ratchet clauses. One bad interval can lock a high demand charge for months. Model the worst-case peak, not the average.
  3. Overstating self-consumption. Summer solar surplus may exceed refrigeration load if the facility is partially empty. Use an 8,760-hour simulation.
  4. Undersizing the interconnection. An array that exceeds the service capacity will face export limits or costly upgrades.
  5. Forgetting load growth. Adding blast freezing, electric forklifts or EV charging can change the load profile and the best system size.
  6. Using residential design rules. Cold storage needs commercial-grade equipment, three-phase inverters and structural engineering for roof loads.

The best projects start with 12 to 24 months of interval data, a structural assessment and a production model that matches the facility’s actual load shape. SurgePV’s solar design software and shadow analysis tools support layout and shading work on the roof, and its public scope covers energy-yield and financial modeling. Results depend on your source data and review.

Frequently Asked Questions

What is a typical solar ROI for cold storage?

There is no single typical figure, because payback depends on the tariff, demand charges, solar resource, system cost and incentives. In this guide’s hypothetical 1.5 MW example, simple payback is about 5.0 years with a 30% federal credit and about 7.1 years without it. Model your own bills and quotes.

Why is solar ROI higher for cold storage than for ordinary commercial buildings?

Refrigerated warehouses run around the clock and use far more electricity per square foot than non-refrigerated ones: 28.8 versus 5.8 kWh per square foot in EIA’s 2012 survey. Because the load is continuous, most solar output is used onsite at the retail rate. Demand charges can add further savings.

How much does a cold storage solar system cost?

Cost depends on roof, structure, interconnection and equipment, so get quotes. This guide’s worked example assumes $1.50 per watt for solar and $280 per kWh for storage, which are assumptions, not market data. The National Laboratory of the Rockies publishes quarterly PV system cost benchmarks for comparison.

Is it better to buy, lease or sign a PPA for cold storage solar?

Ownership usually captures the most value if the company can use the tax benefits and has the capital. A PPA or lease preserves capital and can suit leased buildings, but the investor keeps the tax benefits and prices that in. Model each option against your balance sheet and lease term.

Can battery storage improve cold storage solar ROI?

It can, mainly where demand charges are high, and it can provide backup for refrigeration. Where demand charges are low and net metering is strong, a battery may lengthen payback. Model the facility’s hourly load with and without storage before deciding.

What federal incentives apply to cold storage solar in 2026?

The Section 48E investment credit can apply to commercial solar, but IRS Notice 2025-42 says it terminates for applicable solar facilities placed in service after 31 December 2027, and that this applies to those whose construction begins after 4 July 2026. Depreciation and bonus rules should be reviewed with a tax adviser.

How do demand charges affect cold storage solar economics?

Demand charges bill the highest short-interval kW in a month and can be a large part of a cold storage bill. Envigilance cites 30% to 50% of cold storage utility bills, and quotes typical rates of $5 to $35 per kW. At an assumed $18 per kW, a 500 kW peak costs $108,000 per year.

Next Steps

Cold storage solar is a finance project dressed up as an engineering project. The returns are real only if the model captures the full value stack.

  • Start with 12 to 24 months of interval data and a structural roof assessment.
  • Model energy, demand and delivery savings separately. Do not rely on a flat avoided rate.
  • Run ownership, PPA and lease scenarios side by side, with and without the federal credit.

To see the design and financial model built from your own bills, book a SurgePV demo. You can also read the commercial solar ROI calculator guide or explore our commercial solar page for refrigerated warehouses.
