Quick answer
The interconnected electricity network linking producers and users through lines, substations, transformers, protection, measurement and control equipment.
Answer: The electrical grid is the network of lines, substations, transformers, protection and control systems that connects electricity producers with users. Transmission moves power across larger areas; distribution delivers it locally and can also receive distributed generation. Solar connects through an approved interface at a defined point. Connection voltage, allowable exports, operating requirements and commercial terms depend on the actual network and project.

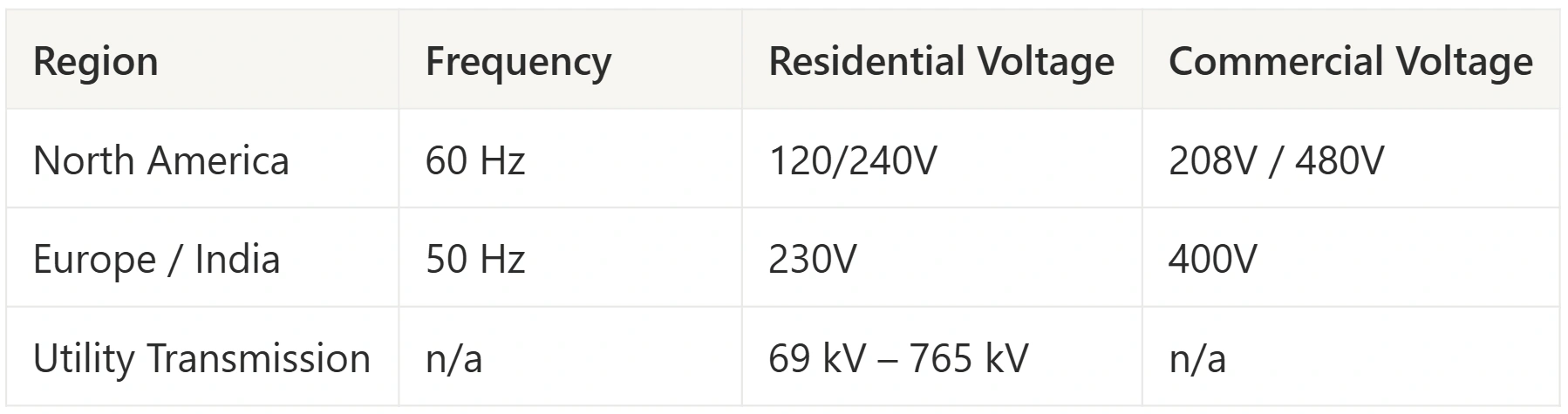

The main parts of the electricity grid
The U.S. Energy Information Administration’s delivery overview describes how power lines, substations and transformers connect generation with consumers. A useful project map distinguishes:
| Part | Role | Solar design implication |
|---|---|---|
| Generation and storage | Supply power or shift when stored energy is delivered | Identify resource capacity, controls and operating intentions |
| Transmission | Transfers bulk power between areas | Large projects may require transmission-level assessment and agreements |
| Substations and transformers | Connect network sections and change voltage levels | Connection equipment and limits must be established for the actual site |
| Distribution | Connects local consumers and distributed resources | Feeder, service and protection conditions can constrain a project |
| Protection, measurement and controls | Detect faults and support coordinated operation | Equipment, settings, metering and communications are part of the approved interface |
There is no worldwide voltage table or project-MW threshold assigning every solar installation to a network level. Operator terminology, existing facilities and the proposed connection determine the applicable arrangement. A project’s DC array rating is not the same as its AC connection capacity.
The network operator and electricity seller may differ
The company selling electricity may not be the organization operating the local wires. The connection authority, market or system operator, retailer and inspection authority can have different responsibilities. Identify who handles connection studies, supply contracts, metering and installation approval rather than assuming one “utility approval” covers everything.
Connection conditions authorize and constrain electrical operation. A tariff, purchase agreement or other commercial arrangement determines electricity value. Receiving permission to connect does not itself establish a net-metering credit or a guaranteed export price.
How distributed solar changes power flows
A grid-tied solar system operates in parallel with the network. Behind a customer’s meter, its generation may reduce imports or create net export. Other distributed resources include storage and controllable loads.
The DOE distributed-resource and microgrid overview distinguishes local resources from a microgrid that can operate intentionally separated from the larger network. A grid-connected battery or PV array does not automatically establish a functioning island.
At a feeder, simultaneous exports can affect voltage, thermal loading and protection. Hosting capacity is assessed using defined network conditions and criteria; a published map is screening information, not a reservation or final connection offer. Added storage or reactive-power controls are possible design options, not guaranteed substitutes for all network upgrades.
Net load and the duck curve
Net load is demand remaining after the variable generation included in the chosen accounting boundary. CAISO’s 2016 flexible-resources fact sheet explains its duck-curve scenarios: variable generation reduces midday net load and its decline can contribute to a steep later ramp. The historical scenarios are not current forecast values or a pattern that occurs identically on every grid.
For a simplified hypothetical network, assume demand of 100 MW and variable generation of 40 MW at noon. Net load is 60 MW. Later, demand is 110 MW and variable generation is 10 MW, leaving 100 MW. If those endpoints are two hours apart, average net-load increase is 40 MW, or 20 MW/hour.
These figures exclude storage, interchange and other accounting adjustments. They demonstrate an operating-balance calculation, not a frequency-stability result, an instantaneous ramp or a specific battery requirement. Operators can use appropriate combinations of flexible supply, storage, demand response and transfers; the suitable mix depends on the system.
A solar project’s connection workflow
- Define the interface. Record network operator, service voltage, phases, connection point, proposed capacity and intended export/storage operation.
- Obtain applicable requirements. Check current operator documents, connection process and relevant local installation rules. The grid code is part of this scope, not a universal preset.
- Submit controlled evidence. Keep equipment models, drawings and operating assumptions consistent. Coordinate technical studies and any requested revisions through the responsible parties.
- Review the connection conditions. Identify limits, upgrades, protection, metering and communications obligations. Keep price and compensation assumptions separate.
- Complete the approved handoff. Coordinate installation inspections, commissioning and operating authorization. Retain final configuration and operating limits for future changes.
Designers should review network inputs before committing to a connection or savings assumption. Installers should work from the approved interface and applicable procedures. Sales teams should explain remaining approvals, export conditions and backup scope rather than guaranteeing that a software model secures permission to operate.
Questions about the electrical grid
Is the grid a storage system?
The network transfers power; it does not store each customer’s exported solar for later return. Storage is a separate resource, and any later billing credit is defined by the commercial arrangement.
Does solar power keep a building running when the grid fails?
Not automatically. Outage operation requires an appropriate intentional-backup configuration and isolation from the public network. Ordinary grid-following PV operation does not supply through a lost grid reference.
Does more solar always require network upgrades?
No. Effects depend on location, operating conditions, existing resources and controls. The relevant network assessment determines constraints and possible solutions rather than a universal solar-percentage limit.
Can a smart grid guarantee solar connection or revenue?
No. Monitoring and controls can improve operation, but projects still need applicable approvals and agreements. Grid-service participation also depends on actual equipment capabilities and program or market terms.
