Quick answer
An electric current that periodically reverses direction, used as the standard form of electricity delivered by the grid and produced by solar inverters from DC panel output.
What Is AC (Alternating Current)?
Answer: Alternating current (AC) periodically changes direction. Solar cells produce DC, and an inverter converts it to AC for an AC-connected building or grid. Frequency describes complete cycles per second; RMS voltage and current describe effective waveform magnitudes. Inverter output must match the actual service and approved operating requirements, which vary by grid, equipment and jurisdiction.
Solar panels generate direct current (DC). An inverter is the electrical bridge to an AC network. This does not mean every appliance uses AC internally: electronic equipment may convert its AC supply back to DC.

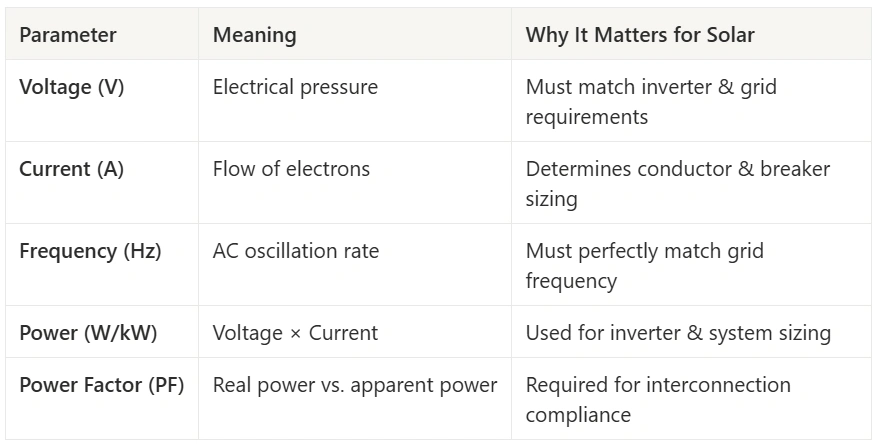

Frequency: Cycles Are Not Direction Changes
Frequency is measured in hertz (Hz), or complete cycles per second. A 50 Hz sine wave completes 50 cycles each second; a 60 Hz sine wave completes 60. A sinusoidal current changes sign twice in each full cycle. “60 reversals per second” therefore does not accurately describe a 60 Hz sine wave.
Fluke’s frequency explanation identifies 50 Hz and 60 Hz as common power-line frequencies. Verify the local nominal frequency and permitted operating range; do not infer them from a broad continent label. Frequency also differs from the much faster switching used inside power electronics.
Instantaneous, Peak and RMS Values
An instantaneous voltage is the value at a particular moment. Peak voltage is the waveform’s largest magnitude. Root mean square (RMS) expresses the equivalent heating effect for a resistive load; it is not the signed average of a sine wave over a complete cycle.
For a pure sine wave with no DC offset:
Vrms = Vpeak ÷ √2.
A hypothetical 230 Vrms sine wave therefore has a peak of 230 × √2 ≈ 325.3 V. This is a waveform example, not a statement that every service is 230 V. The same peak-to-RMS ratio cannot be assumed for arbitrary distorted waveforms.
Fluke’s true-RMS guidance explains why non-sinusoidal loads require suitable measurement tools. RMS measurement also needs the instrument’s specified bandwidth, range and measurement mode; a displayed number alone does not establish accurate power measurement.
AC Power Is Different from Energy
For a single-phase circuit:
Real power P = Vrms × Irms × true power factor.
Apparent power is S = Vrms × Irms, measured in VA. Power factor is the ratio of real to apparent power; it is not necessarily just the cosine of a phase angle when waveforms contain harmonics. See active and reactive power for that distinction.
In a hypothetical single-phase case with 230 Vrms, 10 Arms and true PF = 0.9:
- Apparent power: 230 × 10 = 2,300 VA.
- Real power: 2,300 × 0.9 = 2,070 W, or 2.07 kW.
- If real power remains constant for two hours: 2.07 × 2 = 4.14 kWh.
Power describes the rate of energy transfer; kilowatt-hours describe energy accumulated over time.
For a balanced sinusoidal three-phase system, P = √3 × Vline-to-line × Iline × cosφ. Do not substitute line-to-neutral voltage into that expression or apply the balanced formula blindly to an unbalanced or distorted system. Tektronix’s power-measurement guide explains RMS, real/apparent power and power factor measurement.
AC in a Solar Installation
The AC side begins at the inverter output and can include branch circuits, distribution equipment, transformers, metering and the grid connection. The U.S. Department of Energy’s inverter overview explains conversion and the distinction between grid-following and grid-forming operation.
Single-phase and three-phase equipment must suit the available service, approved connection arrangement and grid profile. Building type or a fixed solar-system kW cutoff cannot determine compatibility by itself.
For a declared point-of-connection boundary, assume solar AC production is 3 kW and concurrent load is 2 kW, with no storage or other sources and negligible intervening losses. Net export is 1 kW. If load instead rises to 4 kW, net import is 1 kW. These are instantaneous power balances, not billing rules. Export permission, metering and compensation depend on the connection agreement and tariff.
What Designers Should Verify
- Actual service voltage, phase arrangement and nominal frequency.
- Inverter continuous current, AC power/apparent-power limits and approved grid settings.
- Conductors, protection, connection capacity and voltage rise under applicable rules.
- Measurement boundaries for inverter output, building load, battery flow and import/export.
- Required isolation, disconnects, labels and manufacturer commissioning procedures.
A shorthand “120% rule” or a generic harmonic-distortion limit does not replace a jurisdiction-specific connection design. Have qualified personnel verify the applicable code edition, equipment instructions and utility conditions.
Common Questions
Does a normal solar system supply AC during an outage?
Do not assume it does. Backup requires a compatible system with isolation, controls and an available power source. An inverter or battery label alone does not guarantee backup capacity or whole-building operation.
How much energy is lost converting DC to AC?
Use the exact inverter’s documented efficiency behavior and the operating conditions. A peak efficiency value does not predict annual conversion losses; clipping, thermal derating and wiring losses also need separate treatment.
Does an AC module generate AC inside its solar cells?
No. An AC module includes inverter conversion alongside the DC-producing module. See microinverters for the conversion architecture and model-specific limits.
For a workflow review, request a SurgePV demo and ask which service configurations, equipment checks and reporting boundaries are supported.
