Quick answer
A solar PV system designed to operate in parallel with an electricity network under approved connection conditions; export compensation and outage backup are separate, configuration-specific matters.
Answer: A grid-tied solar system is a PV installation designed to operate in parallel with an electricity network. It can supply site loads and import electricity when needed; export depends on its approved connection conditions. Batteries are optional for ordinary grid-connected operation. Outage backup is a separate system capability requiring suitable equipment, controls and isolation, and exported energy is compensated only under the applicable tariff or contract.

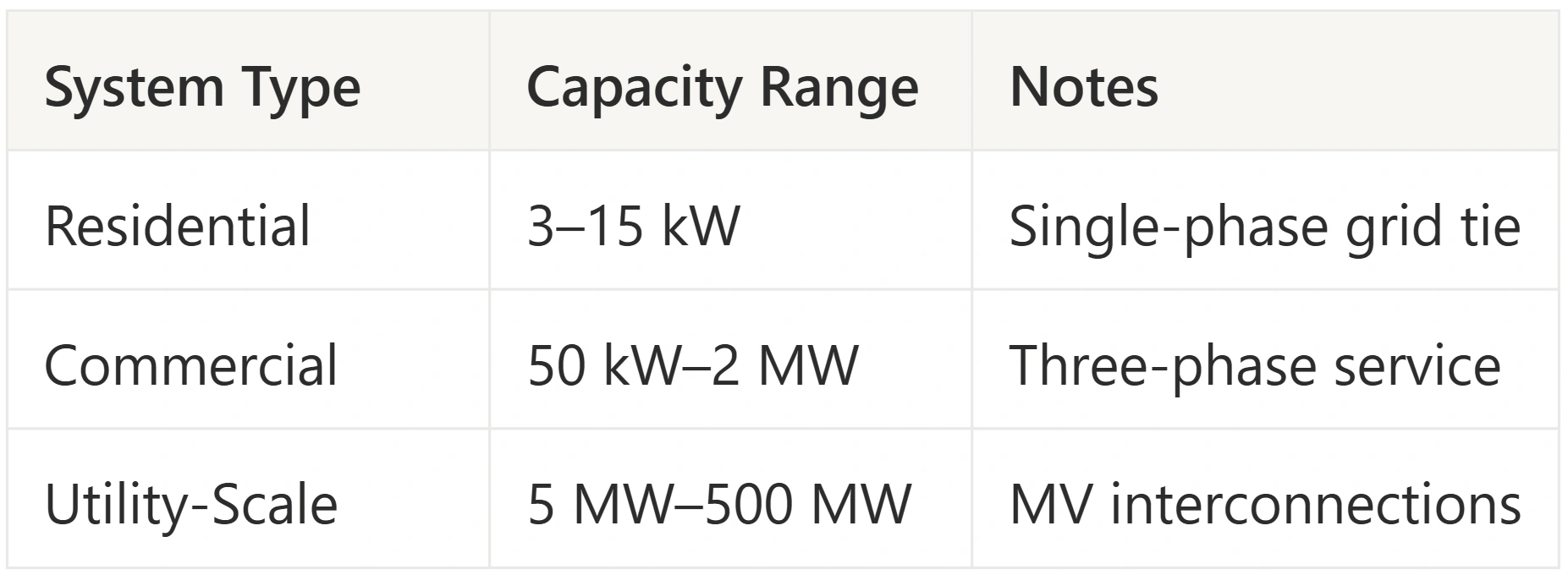

How a grid-tied solar system works
PV modules produce DC electricity. A grid-interactive inverter converts DC to AC and operates according to its approved network configuration. String inverters and microinverters perform this conversion; a power optimizer is a DC/DC device that normally works with an inverter, not a substitute for one.
For a simple behind-the-meter PV installation, site generation reduces the power drawn from the grid. When generation exceeds site demand, the surplus can flow outward if permitted. When demand exceeds generation, the operating network supplies the difference. This is an electrical power balance, not a controller routing a special stream of “solar electrons” to each appliance first.
DOE’s inverter overview explains grid-interactive conversion and the equipment-dependent controls used for grid services and backup. The site’s approved grid export limit may constrain surplus; being connected does not guarantee unrestricted exports.
Grid-tied, off-grid and hybrid are different choices
| Configuration | Connection and operation | Outage question |
|---|---|---|
| PV-only grid-tied | Operates in parallel with the utility under approved conditions | Ordinary grid-following operation does not supply loads through a lost grid reference |
| Grid-tied with storage | Adds charging/discharging functions defined by the system | Storage may be for bill management only; verify backup separately |
| Grid-tied with intentional backup | Separates an approved backed-up section from the utility and supports that section | Power, duration, loads and transfer behavior depend on the actual design |
| Off-grid | Operates independently of the utility supply | Generation, storage or other resources must meet the intended load and autonomy requirements |
“Hybrid” can describe different combinations of PV, storage or other sources. Ask what the system actually does rather than inferring backup or export behavior from the label.
The grid is not a physical battery storing a customer’s exported solar for later return. Billing credits are an accounting arrangement. They vary by tariff, can differ from purchase prices and do not make the grid an available backup source during an outage.
Check outage operation at the system level
Anti-islanding protection prevents inappropriate energization of an unintended island. Intentional backup requires a suitable separation and protection arrangement, a source that can support the isolated loads and compatible controls. A battery, a “hybrid inverter” label or a microinverter alone does not prove those functions.
There are configuration-specific solar-only backup exceptions. Enphase’s April 2023 IQ8 system-use-cases brief distinguishes Solar Only, which provides no backup, from Sunlight Backup, which supports selected essential loads while sunlight is available using the specified additional system equipment without IQ Batteries. This dated, specified configuration does not establish nighttime backup, whole-home support or current compatibility of every IQ8 product. Check the exact current regional design and manuals before procurement.
A hypothetical grid-exchange example
Consider two one-hour intervals at one AC boundary, without storage, other generation, export restrictions or additional unaccounted losses:
| Interval | PV energy | Site consumption | Import | Export |
|---|---|---|---|---|
| Sunny hour | 6 kWh | 2 kWh | 0 kWh | 4 kWh |
| Later hour | 0 kWh | 4 kWh | 4 kWh | 0 kWh |
| Total | 6 kWh | 6 kWh | 4 kWh | 4 kWh |
Total consumption minus production is zero, yet the site imports and exports 4 kWh each. Annual net energy alone cannot determine either flow or the bill. In these assumed intervals, self-consumed PV is 2/6 = 33.33% of generated energy; PV supplies 2/6 = 33.33% of site consumption. These denominators happen to match here but describe different metrics.
If the assumed avoidable purchase price is $0.20/kWh and export compensation is $0.05/kWh, the simplified energy value is 2 × $0.20 + 4 × $0.05 = $0.60. This excludes fixed charges, demand charges, other tariff rules and system costs; it is not a current rate quote or investment return.
Design and handoff checklist
- Designers: compare time-matched generation and demand, permitted export and actual price rules. Identify DC module capacity, inverter AC ratings and storage power/energy separately; do not use a universal annual-consumption sizing percentage.
- Installers: confirm exact equipment, approved configuration, installation requirements and commissioning responsibilities. A generic inverter listing is not whole-project approval. Use qualified, approved procedures for protection and backup testing.
- Sales teams: disclose whether backup is included, which loads it supports and the assumptions behind duration and savings. Compare complete alternatives rather than promising a fixed cost discount over off-grid systems.
Use the applicable grid interconnection application process and retain the approved design, operating conditions and release records. Installation codes, meter arrangements and authorization requirements depend on the authority and site.
Questions about grid-tied solar
Does a grid-tied system require batteries?
Not for ordinary grid-connected PV operation. Storage is a separate design choice; its economic or resilience value depends on the intended function and actual system.
Will it operate in a power outage?
Ordinary solar-only grid-following operation does not provide outage backup. Check the complete specified system for intentional isolation, compatible backup controls, supported loads and available energy.
Will every exported kWh earn a credit?
Not necessarily. Confirm export permission and compensation separately. A connection can be non-export or limited-export, and the tariff or contract determines whether and how delivered energy has value.
Is grid-tied always cheaper than off-grid?
No universal percentage applies. Compare complete designs with the same service requirements, including grid connection costs, backup needs, storage, operating costs and load expectations.
