Quick answer
Export limiting restricts net power sent to the grid under a defined connection arrangement; useful energy and self-consumption depend on time-aligned generation, loads and controls.
Answer: Solar export limiting restricts net active power flowing from a site to the grid under a defined connection agreement or operating requirement. It may use compatible measurement, inverter and controller equipment, with site loads and storage included in the balance. Limiting can reduce delivered generation, but losses and savings depend on timing. The limit’s units, phase treatment and approved response requirements must be explicit.
Export is net site power
Available PV generation and grid export are different quantities. Site consumption may use some generation before any surplus flows to the grid. A fixed inverter output cap is not necessarily equivalent to a site export cap. Other generators and storage also affect the net balance.
The detailed export-limit control workflow addresses metering, compatible devices and acceptance evidence. This page explains the energy and self-consumption implications when evaluating a proposed limit.

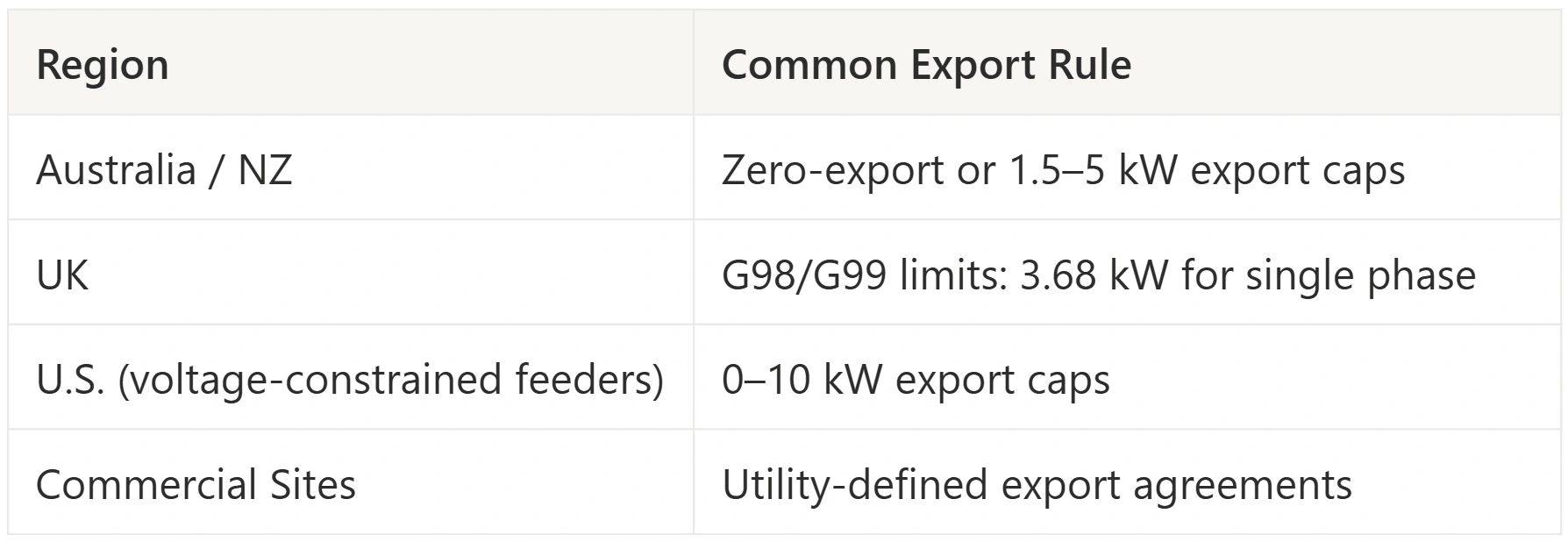

A utility may apply a fixed or varying limit or a zero-export constraint. Record the agreement, date, connection point, aggregate/per-phase basis and required operating conditions. Do not infer a local export allowance from an undated country-wide rule.
How an approved arrangement can limit export
A compatible meter/controller can use net-flow measurements to adjust participating generation or storage. CT and communicating-meter categories can overlap: a meter may itself use CTs. Their names do not establish response speed, accuracy or approval.
SMA’s Data Manager M zero-export documentation explicitly conditions its function on supported connected inverters and interfaces. A generic smart meter or inverter setting therefore does not prove that the entire site complies with a limit. Confirm exact equipment and failure behavior through the applicable qualified review.
Export limiting does not establish anti-islanding or outage backup. A zero-export label does not authorize an intentional island or replace grid protection requirements.
Self-consumption: define the denominator
For a simple PV-only site without storage and with matched measurements:
Self-consumption share = PV energy used on site / actual generated PV energy × 100%
Equivalently, when the boundary contains only on-site use and export, use (actual generated PV energy − exported PV energy) / actual generated PV energy. This relationship needs adjustment for storage, losses or other energy sources. It is not the same as the share of site demand supplied by PV.
Hypothetical interval-matched day: available PV would deliver 40 kWh, including 28 kWh coinciding with site load and 12 kWh surplus. Without limiting, on-site use is 28 kWh and export is 12 kWh: self-consumption is 70%. Under an ideal zero-export scenario with no storage, actual generated PV is 28 kWh and foregone generation is 12 kWh. The actual-generation self-consumption share is 100%, but only 70% of the available 40 kWh is delivered. A higher percentage does not prove more useful energy or greater self-sufficiency.
Daily aggregate consumption alone cannot establish this coincidence; the example explicitly assumes matching interval flows.
Compare constrained designs fairly
Use time-aligned resource, production and load inputs with interval durations. Coarse averages may obscure excursions; annual simulation does not certify real-time controller compliance. Keep the same design/weather basis when comparing limits.
| Option | What to check |
|---|---|
| Different array size/orientation | Production timing, site geometry and incremental cost |
| Load shifting | Whether load can move and the actual tariff effect |
| Storage | Charge/discharge power, state of charge, reserve, losses and compatible controls |
| Alternative permitted export setting | Whether the network actually offers it and its conditions |
A battery cannot recover every surplus kWh just because its nominal capacity matches a daily curtailed total. Nor does an east-west layout have a universal curtailment advantage in every location and load pattern.
Explain economic effects without a fixed loss percentage
Value foregone export at the applicable compensation or contract basis. Compare equipment costs, useful on-site delivery and constrained export cash flows. Do not use a universal payback range or assume storage is always the preferred option.
Show customers available, generated, used-on-site, exported and curtailed energy separately. Grid export limitation requirements and actual approved settings should remain visible in the design assumptions. Commissioning records need qualified equipment-specific procedures, not a generic instruction to modify meter-side wiring or bypass controls.
Common questions
Does zero export mean no grid imports?
No. The site can still import when its generation or stored energy cannot meet demand.
Does 100% self-consumption prove all available PV was used?
No. Curtailment can shrink actual generation and raise that percentage.
Are CTs always faster than smart meters?
No universal ranking follows from these categories; assess the complete approved measurement/control arrangement.
Can a battery eliminate all curtailment?
Not necessarily. Available capacity, power, timing, reserve and operating constraints matter.
