Export Limit Control

Export-limit control manages net power sent to the grid at an agreed connection point using a compatible metering and control configuration with project-specific response and failure requirements.

4 min read
Rainer Neumann

Written by

Rainer Neumann

Editorial contributor · SurgePV

Keyur Rakholiya

Edited by

Keyur Rakholiya

CEO & Co-Founder · SurgePV

Quick answer

Export-limit control manages net power sent to the grid at an agreed connection point using a compatible metering and control configuration with project-specific response and failure requirements.

Answer: Export-limit control manages net power sent from a site to the grid against an agreed limit at a defined connection point. It can reduce generation or coordinate compatible storage and loads using metering and control equipment. The permitted configuration, response requirements, phase treatment and failure behavior are project-specific. An energy-model setting or zero-export label does not by itself prove compliant real-time operation.

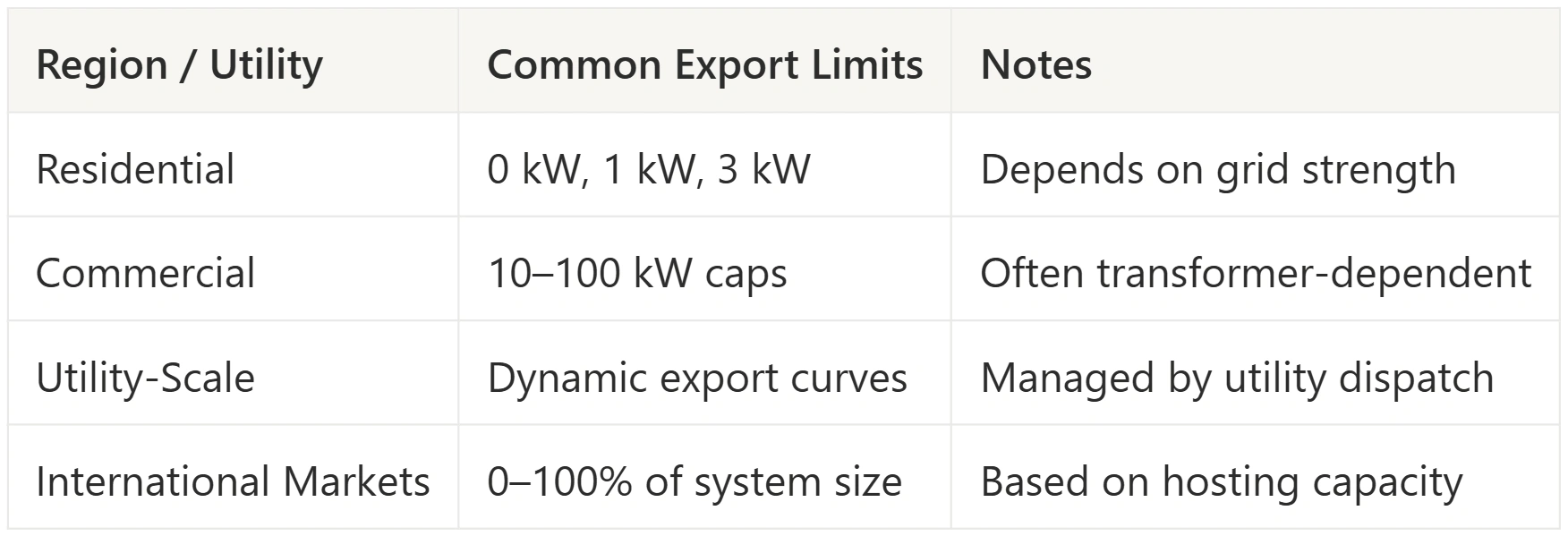

Specify what is limited

An export cap in kW limits active power flowing toward the grid. It differs from a generation cap, an import limit, an apparent-power limit in kVA or an energy allowance in kWh. Confirm whether the agreement uses site aggregate values or per-phase limits and what metering boundary applies.

Fixed, scheduled and externally adjusted limits describe different setpoint arrangements. A dynamic limit requires supported communication and agreed fallback behavior; it is not automatically equivalent to voltage-responsive inverter operation. A zero-export target does not prove that every equipment combination prevents every transient export.

Control implementation is equipment-specific

The system may use a compatible connection-point meter, controller and inverter interfaces. CT location, polarity, phase association and source/load coverage affect the observed net flow. A PV-circuit measurement alone need not represent whole-site export.

SMA’s Data Manager M zero-export documentation describes supported connected inverters and SunSpec Modbus conditions. Those conditions demonstrate why control capability must be verified for the exact product/configuration rather than assumed for every inverter or third-party device.

Record compatible devices and firmware, meter arrangement, setpoints, response/failure requirements and responsibility for changes. Utility acceptance and equipment compliance need their own evidence. No universal one-second response or setting is asserted here.

Checked steady-state example

Assume 8 kW available AC PV power, 2 kW site load, a 5 kW export cap, no battery and no other generator. Unconstrained export would be 6 kW. In an ideal steady-state balance, delivered PV is reduced to 7 kW, comprising 2 kW site use and 5 kW export. Foregone generation is 1 kW, or 0.25 kWh if those conditions persist for 15 minutes.

This is a power-balance illustration, not a controller certification or transient-response test. Curtailment is foregone electrical production; PV does not necessarily generate the same DC electrical power and then dump it somewhere when its operating point is changed.

Calculate energy with interval duration

For a simplified no-storage model at a common AC boundary:

Foregone power_i = max(0, available PV_i − site load_i − allowed export_i)

Foregone energy = sum(foregone power_i × interval hours_i)

Using hypothetical interval-average powers: available PV [7.5, 9.8, 5.0] kW, load [1.0, 1.5, 2.0] kW and a 5 kW cap produce [1.5, 3.3, 0] kW foregone. For three quarter-hour intervals, energy is 1.20 kWh; for three complete hours it would be 4.80 kWh. Do not label a sum of kW as annual kWh without durations.

Time alignment matters. Coarse averages can hide within-interval excursions and underestimate curtailment; an annual energy calculation cannot establish real-time compliance. Other generation and storage require an expanded balance and dispatch model.

Storage and financial decisions

A battery may absorb otherwise curtailed energy if charge power, state of charge, reserve and operating rules permit it. Recovery is not unlimited, and later delivery incurs losses. A larger array or battery is not automatically financially preferable.

Compare constrained and unconstrained delivered energy with the same design/weather basis. Value lost export at its applicable marginal compensation, rather than assuming every foregone kWh was worth the retail import rate. Distinguish capacity-driven inverter clipping from export-driven limiting.

Release and commissioning evidence

Qualified personnel should use approved manufacturer and utility procedures to verify metering, setpoints, load/source changes, relevant communication failures and the required acceptance conditions. Do not turn off all site loads as a generic customer test or infer every failure is a CT error.

Document the approved configuration and change restrictions. Review grid export limitation requirements and the exact smart inverter functions. Software model constraints do not establish hardware capability, grid approval or protection adequacy.

Common questions

Is an export cap the same as an inverter output cap?

No. Site consumption and other connected sources affect net export.

Does zero export guarantee no transient flow?

The approved system and agreement define response and acceptance requirements; a label is insufficient.

Does a battery recover every curtailed kWh?

No. Charge limits, state of charge, timing and losses constrain recovery.

Can hourly modeling certify export compliance?

No. It estimates energy; real-time equipment and commissioning requirements need separate verification.

About the Contributors

Author
Rainer Neumann
Rainer Neumann

Editorial contributor · SurgePV

Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.

Editor
Keyur Rakholiya
Keyur Rakholiya

CEO & Co-Founder · SurgePV

Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.

Explore More Solar Terms

Browse 300+ terms in our complete solar glossary - or see how SurgePV puts these concepts into practice.

No credit card required · Full access · Cancel anytime

Choose which optional technologies SurgePV may use. Essential storage remains active for security and requested features.
