DefinitionD

Due Diligence (Solar)

Solar due diligence investigates a defined project or transaction scope through technical, financial, legal, environmental and contractual evidence; findings inform decisions without guaranteeing approvals or investment returns.

5 min read
Keyur Rakholiya

Written by

Keyur Rakholiya

CEO & Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Quick answer

Solar due diligence investigates a defined project or transaction scope through technical, financial, legal, environmental and contractual evidence; findings inform decisions without guaranteeing approvals or investment returns.

Answer: Solar due diligence is a scoped investigation of a project’s technical, financial, legal, environmental and contractual risks before investment, financing or acquisition. Reviewers check supporting evidence, assumptions and unresolved conditions rather than accepting a proposal at face value. The output informs a specific decision; it does not guarantee production, investment returns, regulatory approval or lender acceptance, and its scope changes with project stage and transaction requirements.

What the review is trying to establish

A solar project combines physical equipment, land or roof rights, construction obligations, an electricity-revenue arrangement and long-term operating responsibilities. Due diligence checks whether these pieces are supported by consistent documents and whether material gaps affect the transaction.

Due diligence does not eliminate risk or necessarily assign a reliable probability to every uncertainty. Some issues need quantitative scenarios; others need legal resolution, additional investigation or a condition before closing. Define the recipient, reliance arrangements, scope and exclusions at engagement.

DNV’s solar due-diligence service description identifies production estimates, equipment, civil/electrical designs, contracting, schedules, budgets and operating costs among technical review topics. This is a provider’s stated scope, not proof that every lender requires the same report or accepts every reviewed project.

Main workstreams and evidence

Workstream Documents and questions to review
Technical Resource/yield model, equipment specifications, electrical and structural design, losses, construction status and operating evidence
Financial Revenue contract or tariff, operating costs, replacements, financing, taxes, degradation and downside scenarios
Legal/regulatory Land/roof rights, permits, interconnection, contractual obligations, assignment and termination provisions
Environmental Applicable site investigations, contamination, habitat, flood/stormwater and land-use constraints
Insurance/counterparties Coverage scope/exclusions, supplier and contractor obligations, warranties, remedies and claim history

The necessary specialists and investigations depend on location, project type and transaction. DOE’s federal project-validation guidance illustrates how feasibility, site/resource checks, utility policies, economics and legal authority interact for federal projects. Its federal procedures are not universal requirements for private projects elsewhere.

Review energy and equipment claims

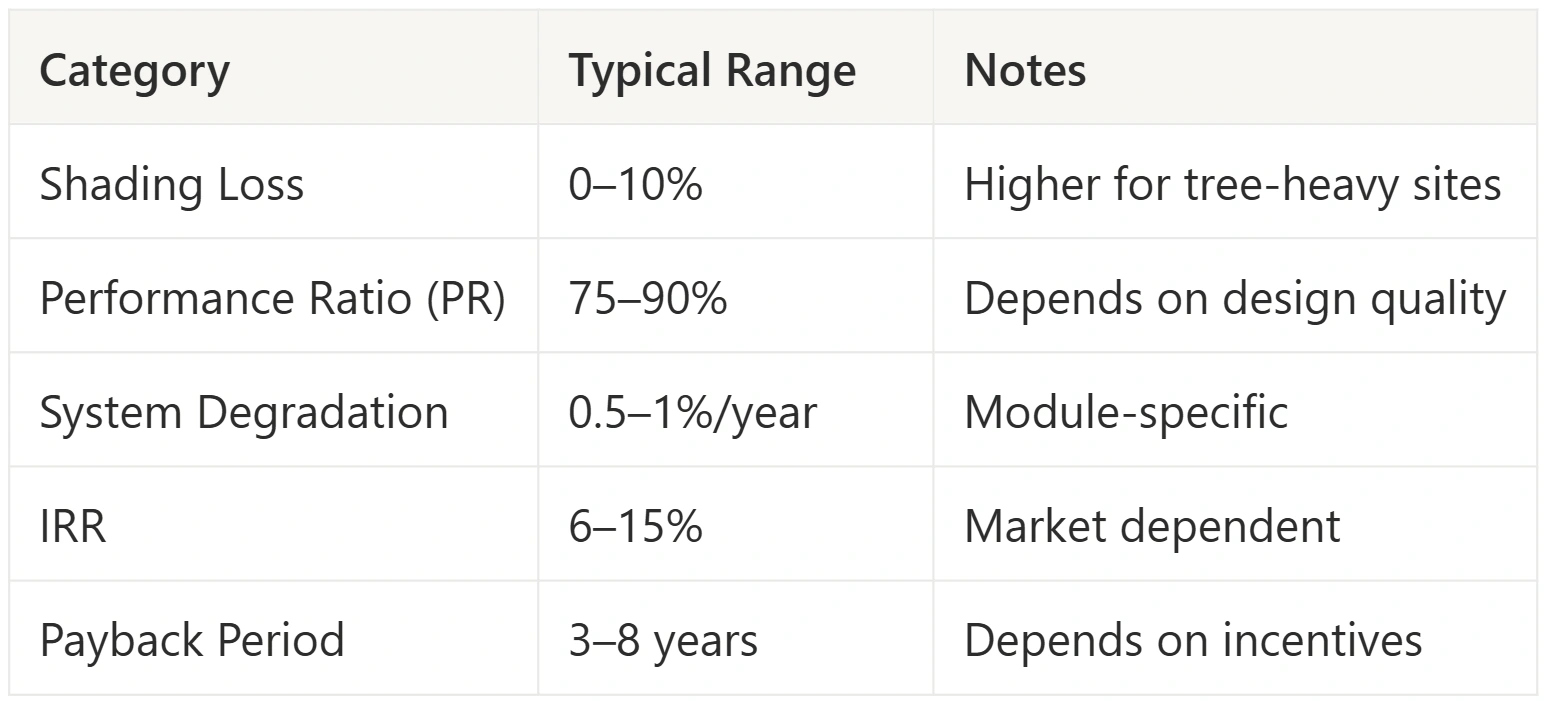

For a yield assessment, retain the weather source, model/version, configuration, shading evidence, loss definitions, output boundary and period assumptions. Reconcile those inputs with the financial model and revenue contract. A grid-export forecast is not interchangeable with an inverter-output forecast.

P50 and P90 describe modeled exceedance outcomes under stated uncertainty assumptions. Record the time horizon, distribution/method and included uncertainties. They are not interchangeable confidence stamps, and P90 energy does not cover every financial or legal downside.

Supplier review should identify the exact model, manufacturing entity, certifications applicable to the product/market, delivery obligations, warranty terms, exclusions, remedy and enforcement arrangements. A vendor ranking or reputation does not replace product-specific technical review or counterparty assessment. For an operating acquisition, reconcile serial numbers, replacements, commissioning evidence, performance data and corrective-action history with the installed asset.

Connect findings to cash flows

Do not treat base IRR × (1 − risk discount) as a general risk-adjusted investment-return method. Change the relevant cash-flow inputs, preserve scenario assumptions and recompute the financial metrics. Avoid double counting a risk through both a cash-flow reduction and an unexplained additional haircut.

Hypothetical revenue sensitivity: annual contracted export of 1,000,000 kWh at $0.08/kWh gives $80,000 before other revenues and costs. A scenario with 5% less export gives 950,000 kWh and $76,000, a $4,000 revenue reduction. It does not imply IRR falls by exactly 5%; costs, debt, taxes, timing and other cash flows still matter. These are illustrative inputs, not current market prices.

A risk register makes the result actionable:

Finding Evidence gap Next action Decision status
Proposed equipment differs from model Updated specifications and simulation absent Resolve model/configuration and quantify change Open
Land-right term shorter than modeled operation Counsel review required Confirm rights/remedies before relying on revenue period Open
Historical energy and model use different boundaries Meter definition unclear Reconcile site consumption/export before comparison Open

An unresolved finding should identify its owner, deadline, materiality and treatment: resolve, investigate, amend terms, accept explicitly or exclude from reliance. Do not mark a missing document as verified.

Build a useful data room

Use an indexed document register with dates, versions, issuer, project identity and review status. Provide model inputs and assumptions alongside presentation reports. Keep permits and utility permissions distinguishable, record contract amendments and reconcile drawings with the as-built configuration. Identify access restrictions for commercially sensitive documents.

Designers can make assumptions reproducible; installers can preserve commissioning and change records; commercial teams can explain open conditions without promising acceptance. The reviewer decides which additional inspections or specialist reports are necessary. Bankability describes financing suitability in context, not a feature automatically conferred by design software.

Common questions

How long does solar due diligence take?

Scope, document availability, specialist work and closing conditions determine the schedule. Obtain a project-specific work plan rather than relying on a fixed number of days.

What does it cost?

Request quotes for the defined workstreams and reliance requirements. A universal percentage of project value is not a reliable budget for every transaction.

Does an independent engineering report guarantee financing?

No. Its conclusions support review within its scope; the lender’s technical, commercial and legal acceptance requirements remain separate.

What is a useful red flag?

A material inconsistency or unsupported assumption—such as unmatched equipment, uncertain land rights or incompatible model/revenue boundaries—needs an assigned action, not an arbitrary universal percentage threshold.

About the Contributors

Author
Keyur Rakholiya
Keyur Rakholiya

CEO & Co-Founder · SurgePV

Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.

Editor
Rainer Neumann
Rainer Neumann

Editorial contributor · SurgePV

Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
