Quick answer
The process of addressing a solar project’s applicable authority requirements through design, documentation, installation and required acceptance, with utility authorization tracked separately.
What Is AHJ Compliance?
Answer: AHJ compliance means addressing the requirements applicable to a solar project within each authority’s scope, then documenting the design, installation and required acceptance. It involves more than obtaining a permit. Verify the local requirements, reconcile changes, respond to corrections and retain inspection records. Utility interconnection approval and permission to operate must be tracked separately from local permit decisions.
The Authority Having Jurisdiction is the party responsible for requirements or acceptance within a defined scope. Start with an AHJ lookup to identify the actual authorities and current requirements. This page explains how to carry those requirements through the project, rather than how to locate the offices.
DOE’s rooftop permitting guidance distinguishes local permitting and inspection from utility grid connection. Details vary by jurisdiction; a local approval should not be represented as the utility’s authorization.
Identify the Applicable Requirements
For a US project, the National Electrical Code may be part of the adopted electrical requirements. It is not a universally applicable federal solar installation law. Confirm the adopted edition, effective date, local amendments and project-specific applicability with the responsible authority. Other countries use their own applicable requirements.
Preserve a dated requirement record. Do not simply assume that the newest published code, a neighboring city’s checklist or a previous project’s acceptance applies to this site. When requirements appear inconsistent, have the responsible professionals and authorities resolve scope and applicability before release.
A Practical Compliance Matrix

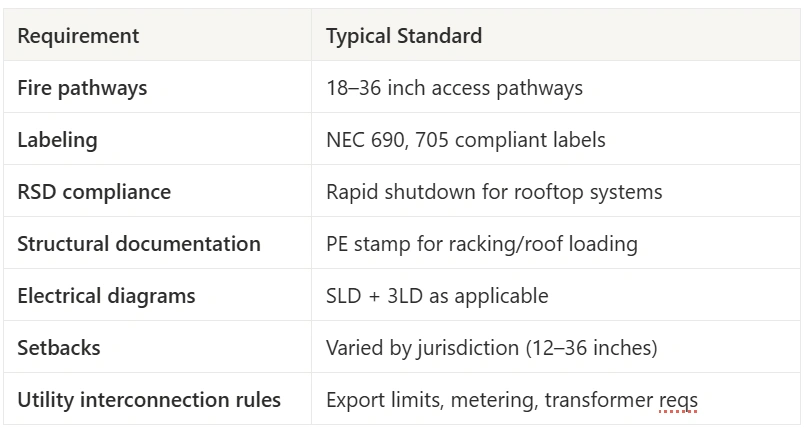

Map each applicable requirement to the relevant design evidence and acceptance record. The following categories are review prompts, not a substitute for the adopted requirements or a professional design:
| Review area | Design and installation evidence | Acceptance or follow-up to track |
|---|---|---|
| Electrical circuits | Conductors, applicable ampacity corrections, protection, ratings and diagrams | Responsible design review and required electrical inspection |
| Equipment | Exact models, compatible configuration and applicable listing or certification documentation | Local and utility equipment requirements within their respective scopes |
| Grounding and bonding | Installed paths, connections and specified equipment | Drawing/installation reconciliation and required inspection |
| Fire safety and access | Applicable pathways, clearances, shutdown and labeling provisions | Actual adopted requirements, not a universal setback template |
| Structural | Roof/site conditions, mounting details and applicable load calculations | Required professional review and permitting evidence |
| Planning or zoning | Applicable location, height, land-use or heritage conditions | Relevant consent or permit outcome |
| Utility interconnection | Exact connection arrangement, metering and operating conditions | Separate utility application, releases and authorization |
A shadow or production analysis does not verify a fire-access rule or structural capacity. First establish the applicable layout constraints, then use the resulting layout for production modeling. Likewise, a model-specific equipment certificate does not establish approval of every possible system using that equipment.
Carry Compliance Through the Project
- Design from verified requirements. Assign a responsible reviewer and identify assumptions requiring field verification. Use exact equipment instructions and applicable calculations.
- Prepare the required documentation. Build the permit package from the current checklist. Confirm required plan views, signatures, forms and submission format.
- Respond to plan corrections. Record each correction, its source, the affected drawing or calculation, the response and the authority’s disposition. Do not close an item solely because someone uploaded a new file.
- Control installation changes. Keep the approved revision identifiable. Route equipment substitutions and field deviations through the applicable review and revision process.
- Prepare for required inspections. Use the project’s actual inspection checklist and current documents. Inspection and commissioning tests should follow the applicable procedures and be performed by qualified personnel; a general web checklist is not a live electrical testing instruction.
- Complete closeout and operating authorization. Retain inspection outcomes, unresolved items and as-built drawings. Track the utility’s required authorization separately.
What SolarAPP+ Approval Does and Does Not Settle
A verified automated permitting process can support eligible projects in participating jurisdictions. It does not establish that every jurisdiction or every design is supported.
SolarAPP+’s additional-requirements guidance explains that local requirements may include additional permits, forms or inspections. Those requirements still apply after SolarAPP+ approval. Its inspection preparation guidance tells installers to prepare the approval documents, inspection checklist and supporting documents required by the jurisdiction.
For a revision, SolarAPP+’s published process describes resubmission, updated approval documents and the need to notify the jurisdiction and reconcile its permitting system where applicable. An inspector needs the current checklist, not an obsolete initial approval.
Practical Responsibilities
Designers: associate requirements with drawing details and calculations. Record source dates and local amendments. Confirm equipment compatibility and the limits of any software check rather than promising automated compliance.
Installers: work from the applicable approved revision, document field changes and retain evidence of concealed work. Photographs do not automatically replace required inspection. Resolve identified defects through qualified personnel and the required process.
Sales and project managers: distinguish confirmed requirements and fees from estimates. Explain permit review, installation, inspection and utility authorization as separate milestones. Do not promise approval percentages, universal turnaround times or guaranteed insurability.
After corrections, maintain a searchable record of the actual issue, authority, project conditions and outcome. Use it to improve internal checks, while re-verifying requirements for each later project. A past inspector preference is not necessarily a current binding rule.
Evaluate your design workflow with SurgePV using the documents your authority requires. Confirm demonstrated functions and review responsibilities before relying on software-generated outputs.
Frequently Asked Questions
Which codes must a solar installation meet?
The requirements adopted and applicable to its location, project and equipment. Confirm editions, amendments and required professional reviews. A generic worldwide list cannot determine a particular installation’s compliance.
Does an issued permit mean the installed system is approved?
It does not replace required inspections, approved revisions or utility authorization. Installation changes may need further review, and acceptance records should identify their scope.
Does rapid shutdown always require a particular optimizer?
Do not assume that. Establish the applicable requirement and verify the exact approved equipment configuration and manufacturer instructions. An optimizer or microinverter label alone does not establish system compliance.
Can software guarantee AHJ compliance?
A software check only addresses its supported inputs and rules. Current local requirements, field conditions, equipment compatibility, professional review and authority acceptance still require verification.
Related Glossary Terms
About the Contributors

CEO & Co-Founder · SurgePV
Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
