Quick answer
A residential photovoltaic installation that generates electricity for household use; grid connection, storage, export and backup functions depend on the installation’s equipment and configuration.
Answer: A home solar system is a residential photovoltaic installation that converts sunlight into electricity for household use. Panels produce DC electricity; an inverter supplies AC electricity to compatible household circuits. Grid connection, storage and backup capability depend on the system’s design. Size, annual generation and bill savings require separate assessment of the home, site and applicable utility arrangements.
How electricity moves through the system
Solar panels generate direct current. A solar inverter converts it into alternating current. A string inverter receives electricity from connected module strings; microinverters convert electricity at individual or small groups of modules. A power optimizer adjusts DC operating conditions and still requires an inverter for AC conversion.
Mounting hardware, wiring, protection and connection equipment complete the installation. Monitoring can help track performance but does not replace electrical protection or professional verification. Rooftop and ground-mounted residential systems both need a suitable site and the required reviews.
When generation serves household loads directly, it reduces the electricity imported at that time. Surplus may charge compatible storage, export under the utility agreement or be limited by an export control. At other times, the home imports electricity or uses another configured supply. Do not assume every grid-connected home receives retail-rate net metering.
Grid-connected, storage and off-grid arrangements
| Arrangement | What it provides | What to confirm |
|---|---|---|
| Grid-connected PV | Solar generation alongside utility supply | Connection permission, export rules and outage behavior |
| Grid-connected PV with storage | Configured charging/discharging and potentially backup | Supported operating modes, inverter/storage compatibility, transfer equipment and backed-up circuits |
| Off-grid system | A supply independent of the utility network | Seasonal generation, storage, load management and any supplementary generation |
Adding a battery does not automatically provide whole-home backup. The DOE resilience explanation distinguishes ordinary grid-dependent solar from appropriately configured solar-plus-storage. Confirm the actual equipment’s islanded operating capability, supported circuits, power limits, reserve and transfer arrangements. A kWh capacity rating alone does not establish motor-starting ability or backup duration.
AC coupling describes an electrical architecture; “hybrid” is a product/system label whose functions must be checked. Neither term guarantees a particular outage mode.
Size the system with a stated energy boundary
Start with dated electricity data, roof/site evidence, proposed equipment and a site-specific production estimate. Record whether capacity is module kW DC or inverter kW AC, and where modeled energy is measured. See PV system.
A useful preliminary relationship is:
PV capacity (kW DC) = target annual PV energy (kWh) ÷ modeled specific yield (kWh per kW DC per year)
For a hypothetical target of 9,000 kWh/year and a modeled specific yield of 1,500 kWh/kW DC/year, capacity is 6 kW DC. Fifteen 400 W modules give that nameplate capacity. If the estimate already includes applicable system losses, do not multiply by another generic performance ratio and count those losses twice.
A more simplified irradiance calculation requires a consistently defined irradiation basis and loss assumptions; “peak sun hours” is not a count of daylight hours. Detailed sizing should account for orientation, shading, weather and equipment rather than a universal sun-hour value.
Annual offset is different from self-consumption
Suppose that hypothetical home consumes 10,000 kWh/year and PV generates 9,000 kWh at the stated delivery boundary. Annual energy offset is 90%. If only 3,500 kWh of PV is used directly by the home and there is no battery, the same simplified balance gives:
- PV self-consumption:
3,500 ÷ 9,000 = 38.9%. - Exports:
9,000 − 3,500 = 5,500 kWh. - Imports:
10,000 − 3,500 = 6,500 kWh.
The home still imports substantial electricity. Bill savings need the actual import and export tariffs, timing and applicable fixed charges; a 90% annual energy ratio is not a 90% bill reduction. Storage introduces its own charging, conversion and operating losses.
Practical decisions before a proposal
Use a home assessment checklist to record roof condition, usable geometry, shading, equipment information and access constraints. Structural suitability and the electrical connection method need appropriate qualified review. A service-rating label alone cannot establish that a particular solar installation is acceptable.
Designers should compare buildable layouts with consistent inputs and include planned loads such as EV charging or electrification. Installers should verify project-specific mounting, wiring, protection and commissioning requirements. Sales teams should show the equipment, production assumptions, current quote, warranty conditions and outstanding reviews. Avoid a generic orientation penalty, savings percentage or payback promise.
Check local permitting and utility processes separately. The DOE permitting guidance describes local variation in the United States; it is not a worldwide approval rule. Get current local quotations and independently confirm applicable incentive eligibility instead of assuming a universal subsidy or price per watt.
Frequently asked questions

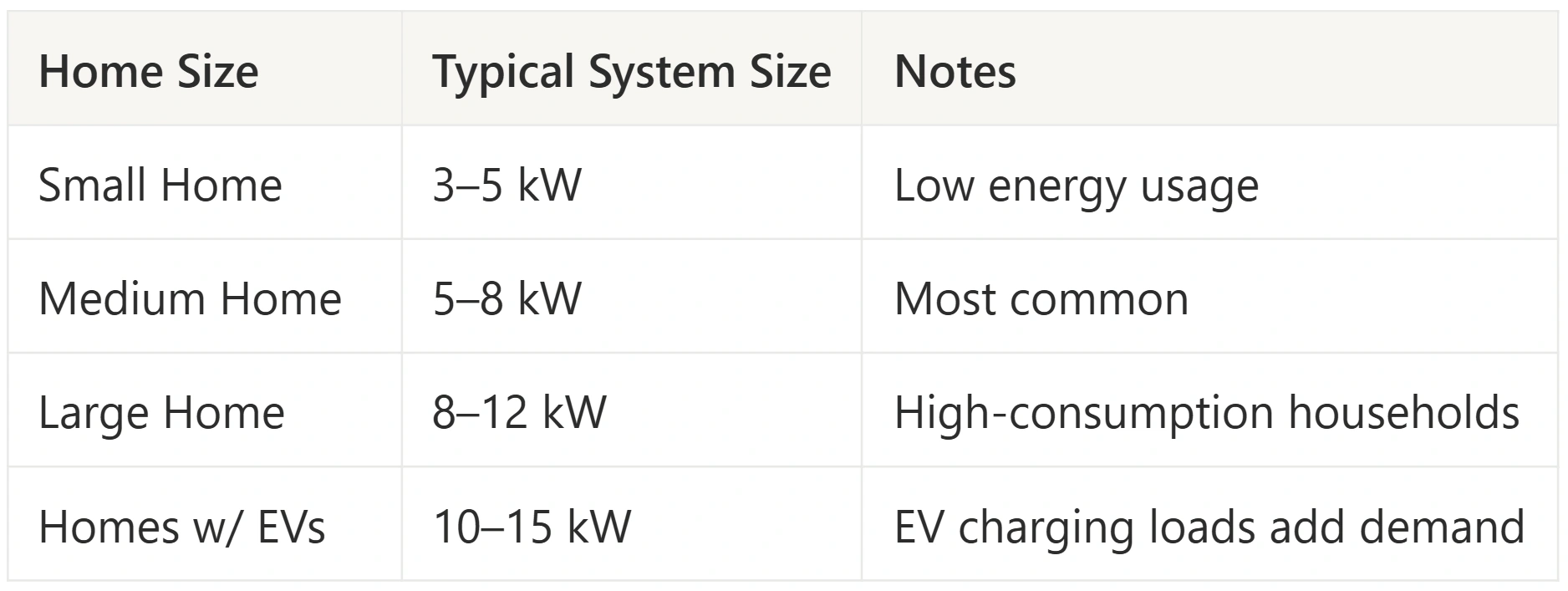

How many panels does a home need?
It depends on the target energy, site-specific yield, module wattage and feasible layout. The 15-panel example above is a declared calculation, not a household benchmark.
Does home solar work during a power outage?
Ordinary grid-dependent PV generally shuts down when grid power is lost. Backup requires equipment and configuration designed for intentional isolated operation; check the exact system and supported loads.
Is a battery required?
Not necessarily for a grid-connected PV installation. Evaluate storage against the homeowner’s operating goals, tariff and backup requirements rather than assuming it will always improve financial returns.
How much will the system cost or save?
Use a dated, itemized local quote and a tariff-based model. Separate cash and financed costs, fixed charges, export compensation and conditional incentives; system capacity alone cannot establish savings.
Related Glossary Terms
About the Contributors

CEO & Co-Founder · SurgePV
Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
