Quick answer
Solar modules with comparatively high rated electrical output per unit of module area under the same stated test conditions; efficiency alone does not determine annual yield or financial return.
Answer: High-efficiency solar panels have greater rated electrical output per unit of module area under the same test conditions. The label has no universal cutoff: compare the exact modules’ efficiency, dimensions and ratings. Higher efficiency can help a space-constrained layout, but does not by itself establish better shade performance, annual energy yield, reliability, warranty coverage or financial return.
What does panel efficiency mean?
Module efficiency is the fraction of incident solar power converted into electrical power under stated conditions. For a rated module comparison, use the module’s maximum power and the manufacturer’s area definition, rather than a cell-efficiency record or a “premium” label.
The national laboratory’s PVWatts system-design documentation defines standard test conditions (STC) as 1,000 W/m² irradiance, 25°C cell temperature and air mass 1.5. That is a reference test point, not a claim that modules operate at 25°C or their nameplate power all day.
Module efficiency (%) = 100 × rated power (W) / [module area (m²) × reference irradiance (W/m²)]
STC power density (W/m²) = module efficiency as a decimal × 1,000 W/m²
A 22% efficient module corresponds to 220 W/m² at that reference irradiance. Use 0.22, not 22, in the second expression. Cell efficiency and complete module efficiency have different area and device boundaries.
An exact product example, not a brand ranking
REC’s Alpha Pure-RX product page lists up to 470 W and 22.6% panel efficiency. The linked US datasheet, labeled UL EN 6.2026 V7, specifies 1,728 × 1,205 mm dimensions and efficiencies of 21.6%, 22.1% and 22.6% for its 450, 460 and 470 W classes.
For the 470 W class, multiplying the external dimensions gives 2.08224 m². Dividing 470 W by that area gives 225.72 W/m², corresponding to 22.57%, consistent with the rounded datasheet value. The example shows how to check a specification; it is not an independent product test, availability confirmation or “highest efficiency” award.

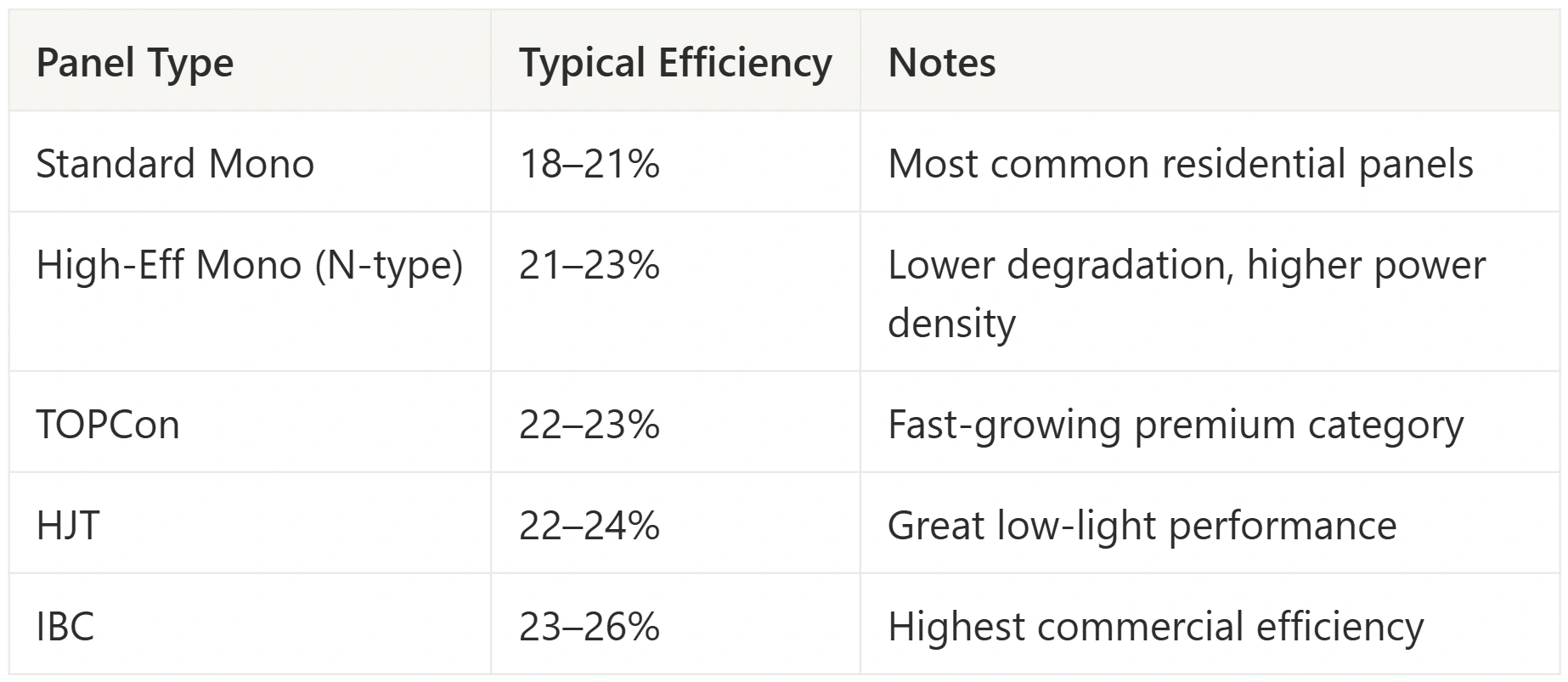

What technologies can contribute?
Technology distinctions help when reading a datasheet: TOPCon and heterojunction (HJT) describe cell structures; back-contact designs describe contact arrangement; half-cut formats and interconnection layouts describe other aspects of module assembly. Compare the actual finished module rather than assigning a guaranteed efficiency, temperature coefficient or price to an entire technology family.
REC identifies the specific example above as HJT and provides its own temperature coefficient and warranty terms. Those facts cannot be generalized to every HJT panel. Likewise, bifaciality and installed rear-side energy gain are different from front-side module efficiency; check the reporting conditions before comparing values.
Laboratory cell records, research modules and purchasable products also have different scopes. A research result is not evidence that the same device is available, warranted or approved for your installation. Verify a dated, region-specific product sheet instead of relying on an undated record list.
Compare area, capacity and annual energy separately
Hypothetical equal-area example: if 25 m² were entirely covered by module face area, 20% efficiency corresponds to 5.0 kW DC at STC and 22% corresponds to 5.5 kW DC. That is 10% more rated power from the assumed module area. It is not a realistic packing guarantee: gaps, module dimensions, roof shape, access paths and setbacks reduce what fits.
A larger-wattage module may simply be larger. Higher efficiency does not always mean fewer modules for the same capacity. For an assumed 10 kW DC target, 25 modules at 400 W total 10,000 W; 30 modules at 335 W total 10,050 W. This counts discrete modules but says nothing about their efficiency, fit, installation time or warranty.
To compare annual energy, model the actual layouts with the same weather and energy boundary. Include temperature behavior, shade timing, electrical configuration, clipping and other supported losses. The laboratory’s PVWatts documentation explicitly cautions that its premium module category need not have the highest output under every operating condition; its categories are model assumptions, not a current market ranking.
Selection checklist for project teams
| Question | Evidence to compare |
|---|---|
| What fits? | Exact dimensions, orientation, clearances and usable geometry |
| What is rated? | Power class, module efficiency and test conditions |
| What is electrically compatible? | Voltage/current data and qualified string/inverter checks |
| What happens in heat or shade? | Model-specific coefficients, cell/diode configuration and matched simulations |
| What is warranted? | Product versus power warranty, exclusions, installer/registration conditions |
| What does it cost? | Current delivered and installed quotes on the same DC-capacity basis |
| What is the return? | Documented output, tariff, maintenance, financing and discount assumptions |
Designers: compare feasible layouts before promising a capacity or energy offset. Check structural and electrical suitability separately; efficiency is not a weight-per-area or approval classification.
Installers: follow the exact manufacturer’s handling, mounting and connector requirements. Confirm substitutions with the designer instead of treating all high-efficiency modules as interchangeable.
Sales teams: show the expected output and cost of each actual option. Avoid guaranteed 15–30% yield increases, better lifetime returns or standard premium warranties based on efficiency alone.
Evaluate the layout workflow with SurgePV and confirm that the specific module data and comparison outputs needed for the project are available.
Frequently asked questions
Is there a universal high-efficiency cutoff?
No. The label is comparative and changes with the product market. State the actual module efficiency and test conditions instead of relying on a category name.
Does higher efficiency mean better shade tolerance?
No. Shade response also depends on module wiring, bypass diodes, electrical topology and shadow timing. Efficiency alone does not establish the result.
Is a higher-wattage panel necessarily more efficient?
No. It may have a larger area. Compare rated watts per square metre and the datasheet’s module-efficiency value.
Are high-efficiency panels always worth a premium?
No. Compare the feasible layout, modeled output and current installed cost. Space constraints may increase their value, but financial performance remains project-specific.
Related Glossary Terms
About the Contributors

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.

CEO & Co-Founder · SurgePV
Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.
