DefinitionG

Grid-Forming Inverter

An inverter whose controls establish an internal AC voltage reference and support network voltage and frequency within its equipment and energy-source limits.

4 min read
Rainer Neumann

Written by

Rainer Neumann

Editorial contributor · SurgePV

Keyur Rakholiya

Edited by

Keyur Rakholiya

CEO & Co-Founder · SurgePV

Quick answer

An inverter whose controls establish an internal AC voltage reference and support network voltage and frequency within its equipment and energy-source limits.

What Is a Grid-Forming Inverter?

Answer: A grid-forming inverter uses controls that establish an internal AC voltage reference and regulate its relationship with the connected network. It can support voltage and frequency rather than relying only on an existing waveform. This control capability does not by itself prove black-start readiness, outage backup, unlimited fault current or approval for a particular grid connection.

Grid-forming and grid-following describe control behavior. In simplified terms, a grid-following inverter tracks an existing AC reference to control injected current, while a grid-forming inverter controls an internal voltage reference. A grid-forming resource can operate while connected to an existing grid; the term does not mean it is always off-grid.

The National Laboratory of the Rockies’ grid-forming introduction describes an internal voltage phasor maintained over short disturbance timescales. That technical definition is more precise than treating grid-forming as a synonym for “whole-building backup.”

How the Controls Support a Network

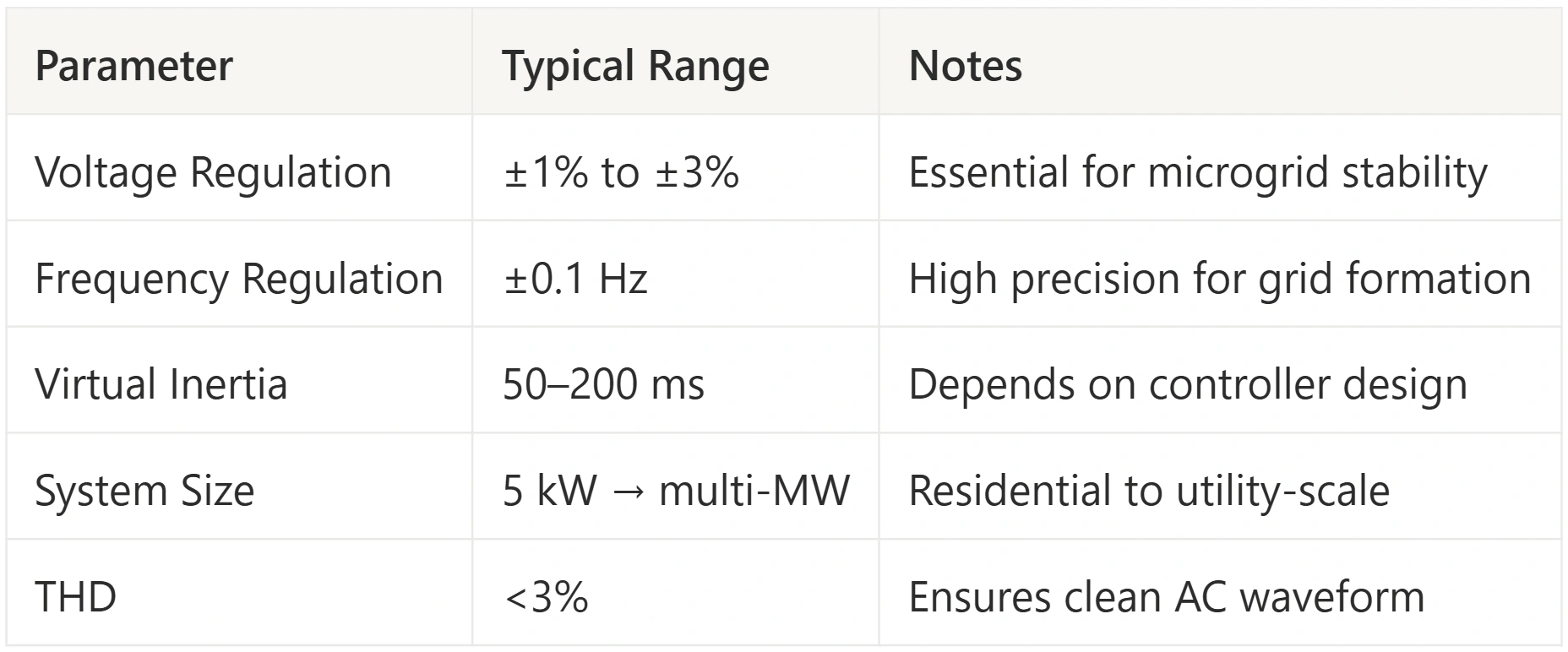

The inverter’s power electronics convert energy from an available source into AC. Controls determine voltage, phase/frequency behavior and power exchange within equipment limits. Filters shape the output waveform; the complete device includes protection and current limiting.

Grid-forming implementations can use approaches such as power-frequency/voltage droop, virtual synchronous-machine controls or oscillator-based controls. These are design approaches, not a ranking that one is best for every project. Their performance depends on the implementation, source capability, settings and connected network.

The DOE inverter overview explains why the grid needs both energy sources and controls. Producing a voltage reference does not create energy: real power support needs available generation, stored energy or another suitable input. Battery power limits and state of charge can therefore constrain a battery-based implementation.

Grid-Forming, Islanding and Black Start Are Different

Capability What it describes What still needs verification
Grid-forming control Internal voltage-reference behavior and interaction with the network Operating limits, disturbance performance and validated controls
Intentional island operation Supplying a defined local network isolated from the utility Isolation, loads, energy source, protection and approved system configuration
Black start Energizing an initially de-energized network without an external live AC reference Auxiliary power, startup sequence, transformer/load inrush and source availability
Uninterrupted backup Maintaining supply within a load’s interruption tolerance Transfer behavior, downstream equipment and load-specific requirements

A device may have grid-forming controls but require additional equipment or conditions for the other capabilities. NLR’s black-start research emphasizes restoration plans, equipment energization and resource testing. It notes that inductive-load inrush can be difficult for typical inverters to supply.

For the installed backup-system requirements, see islanding-capable inverters. A microgrid can also use other voltage/frequency-establishing resources, such as a synchronous generator; every microgrid does not necessarily require a particular inverter architecture.

Current Limits Matter During Disturbances

An inverter is not an unlimited voltage source. Its semiconductors and associated hardware constrain current and overload duration. Engaging a current limiter changes the controlled behavior during a disturbance.

NLR’s 2025 guide to current limiting and stability explains that these changes affect protection, synchronization and transient stability. A grid-forming label therefore does not establish performance for every fault or weak-grid condition. Avoid selecting equipment using a universal short-circuit-ratio cutoff or renewable-penetration percentage.

Fault-current contribution and protection coordination need the actual models and system study. A software energy estimate cannot replace that analysis.

What to Request from the Supplier

  • Exact model, firmware and enabled control mode.
  • Continuous real/apparent-power ratings and the permitted active/reactive operating envelope.
  • Current limits, overload duration and behavior during voltage/frequency disturbances.
  • Source power and energy requirements, including battery-management constraints where applicable.
  • Evidence for any claimed black-start, island operation or transfer performance.
  • Validated models, test scope, protection requirements and applicable interconnection approval.

Do not infer a universal cost premium, synthetic inertia setting or future grid-code approval from the architecture. Quote the proposed equipment and verify the actual grid/operator requirements.

Common Questions

Does grid-forming always require a battery?

No universal battery requirement follows from the control definition. It needs a suitable energy source and operating conditions for the requested service. Battery-based systems are one implementation; evaluate the documented source and limitations.

Can a grid-following inverter work inside an island?

It can participate where a compatible resource establishes the local reference and the complete system supports that operation. Check the equipment, controls and protection rather than assuming any grid-tied inverter will work with any backup source.

Does grid-forming automatically mean black start?

No. Confirm that the proposed system can power its controls, energize its network and start the intended loads under the required initial conditions.

For a project workflow review, request a SurgePV demo and ask which equipment documentation and review outputs it supports. Grid stability and protection approval require the responsible engineering process.
