Quick answer
Solar energy forecasting estimates future power or energy for a stated horizon and system boundary, using appropriate weather, configuration and operating information and evaluated uncertainty.
Answer: Solar energy forecasting estimates future electricity output for a stated period and system boundary. Short-term forecasts support operating decisions using predicted weather and current plant information; long-term production estimates use historical resource data and declared project assumptions. Accuracy depends on the horizon, conditions and evaluation method. A forecast is not guaranteed output, a universal P90 floor or automatic evidence of lender acceptance.
Define the forecast before choosing a method
Specify the issue time, lead time, interval length, target period and output boundary. Predicting next-hour inverter power in kW differs from estimating next-year grid-export energy in kWh. State whether downtime, export limits, site consumption or storage are included.
| Forecast purpose | Relevant inputs | Important limitation |
|---|---|---|
| Intraday/day-ahead operation | Predicted weather, recent irradiance/output, plant status | Cloud changes and unavailable equipment can affect individual intervals |
| Seasonal planning | Historical patterns and applicable seasonal information | A seasonal distribution is not a precise daily weather forecast |
| Long-term production estimate | Historical/multi-year or typical-year resource, design and loss assumptions | A typical year does not predict the weather of a specific calendar year |
| Probabilistic forecast | Defined distribution and uncertainty/evaluation approach | Coverage must be evaluated for the declared horizon and conditions |
NLR’s predictive-analytics resources describe forecasting within energy-management applications. Methods can combine physics, statistical relationships, weather prediction and other observations; machine learning is an option, not a requirement for every forecast.
Keep the useful input categories
Weather/resource, system configuration and operating/loss assumptions form the core input register. Record source versions, coordinates, timestamp conventions, module/inverter models, orientations, shading evidence and relevant availability or curtailment assumptions. Energy modeling describes how these inputs become an electrical-output simulation.
Keep modeled losses distinct from statistical uncertainty. Weather variability, dataset bias and parameter uncertainty are not interchangeable. A narrow reported range can reflect omitted uncertainty rather than stronger evidence.
Power, energy and a checked screening example
A forecast of interval-average power becomes energy through duration: Energy = Σ(power × interval hours).
For a deliberately simplified annual calculation, use plane-of-array irradiation in kWh/m², not irradiance in W/m²:
Screening energy = POA irradiation × module area × assumed conversion efficiency × retained-loss factor × availability factor

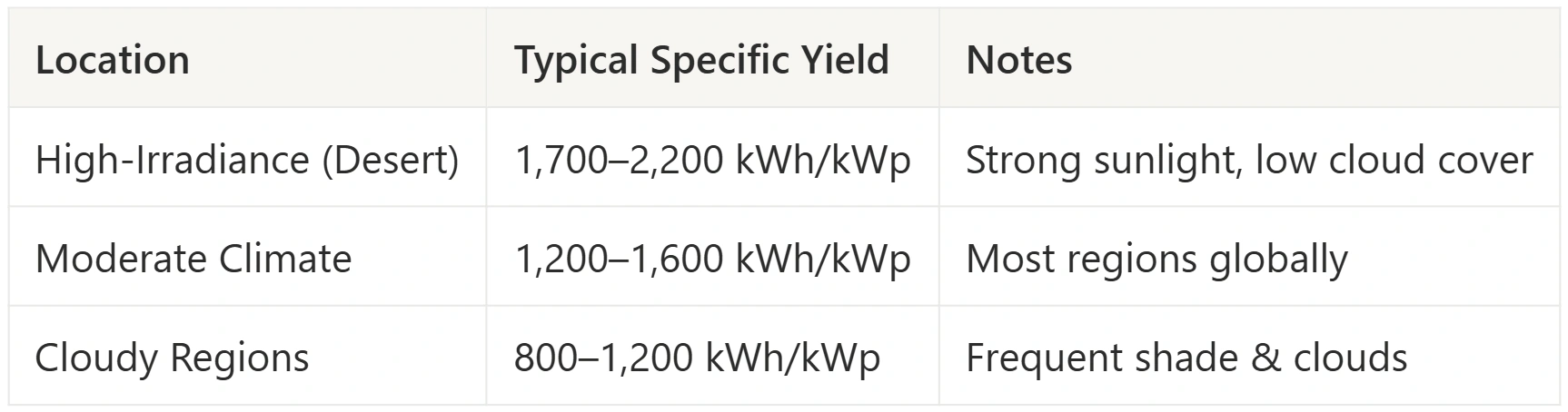

Hypothetical inputs: 2,150 kWh/m²/year, 48 m², efficiency 0.21, retained-loss factor 0.82 and availability 0.99 yield 17,593.33 kWh/year. This is a dimensional screening example, not a Phoenix benchmark or validated component simulation. The area and efficiency imply 10.08 kW at 1 kW/m² reference irradiance; do not also label this as an exactly 10 kW array without reconciling the equipment rating. Availability is separate here only if the retained-loss factor excludes it.
Temperature, electrical limits, shading interactions and time-varying behavior need an appropriate detailed model. Annual scalar factors alone do not establish interval clipping or energy value under a time-dependent tariff.
Evaluate the forecast against a fair reference
Record predictions as issued, then compare with time-aligned observations at the same boundary. Distinguish errors caused by unexpected weather, plant outages and measurement gaps. Avoid evaluating a day-ahead forecast using weather information unavailable when it was issued.
With residual forecast − measured, mean bias error describes average signed error. RMSE is the square root of the mean squared residual: it captures both bias and scatter, rather than being simply the standard deviation of errors. Define the normalization denominator, daytime filtering and exclusions before reporting percentages. Sandia’s validation procedure combines error measures, residual analysis and baseline comparison.
Hypothetical two-interval example: forecasts [100, 120] kW and observations [90, 130] kW give residuals [+10, −10] kW, zero mean bias and 10 kW RMSE. Zero bias does not mean both predictions were accurate. Compare relevant persistence or other reference forecasts over matching periods and lead times; one metric alone is insufficient.
P50/P90 and customer interpretation
Under a stated distribution, P50 is the median exceedance outcome and P90 is met or exceeded with modeled probability 90%. P50 is not necessarily the arithmetic mean. P90 is not a guaranteed minimum, and annual versus multi-year horizons can have different uncertainty treatment. See P50/P90 for the specific interpretation.
For operations, verify probability calibration and the usefulness of the forecast for the intended decision. For investment reporting, disclose weather basis, uncertainty method and limitations instead of promising a fixed P50/P90 gap or universal financing acceptance. Energy production forecasting focuses on project production estimates; weather data integration supports input provenance.
Common questions
Does a typical-year file forecast next year’s weather?
No. It supports representative resource modeling rather than predicting the sequence of a specific future year.
Is RMSE the same as mean bias?
No. Opposite errors can cancel in mean bias while remaining visible in RMSE.
Does P90 guarantee debt repayment?
No. It is a modeled energy outcome; repayment also depends on contracts, costs, financing and other risks.
Does a more complex method always forecast better?
No. Compare held-out observations, appropriate baselines, lead times and conditions before concluding that complexity improves decision usefulness.
