Quick answer
A decline in a defined PV performance measure over time; module measurements, normalized plant trends, forecast assumptions and warranty limits require distinct interpretation.
Answer: PV degradation rate describes a decline in a defined performance measure over time. It can refer to module power, a normalized plant performance trend or an assumption used in a forecast. These quantities require different evidence. Material changes, early-life effects and operating conditions can affect the trend, but raw annual energy decline alone does not establish degradation or prove a warranty claim.
What is changing, and how is it measured?
Module maximum power measured under comparable conditions differs from plant AC energy. A lower annual energy reading may result from weather, soiling, shading changes, outages, curtailment or meter changes. Before diagnosing aging, identify the baseline, measurement boundary, elapsed period, normalization and uncertainty.
NLR’s PV Lifetime project studies module performance over time with controlled measurements and field data. Its reliability research investigates environmental and operating stressors and component failures. These research programs support equipment- and condition-specific assessment, not a universal rate for every technology or climate.
Mechanisms that can affect module performance
| Mechanism or stress | Interpretation boundary |
|---|---|
| Light-induced changes | Early-life behavior depends on cell materials and conditions; do not assume the same initial drop for every module |
| Potential-induced degradation | Electrical stress and construction matter; a generic grounding change is not an approved remedy |
| Moisture and material aging | Encapsulation, insulation and interconnections can change; investigate the actual equipment and exposure |
| Thermal and mechanical stress | Handling, loading and cycling can affect cells or connections; inspections and tests need appropriate methods |
These are useful diagnostic categories, not an exhaustive list or fixed loss table. An n-type label does not establish immunity to every mechanism. Some effects can stabilize or be partly reversible under particular conditions; avoid describing every observed change as permanent material decay. Follow exact manufacturer instructions and qualified assessment rather than prescribing polarity grounding or live testing.
A declared power example
For a hypothetical 400 W starting reference, assume a 2% initial step and then a 0.5% compounded annual reduction. At the end of Year 1, power on this convention is 392 W. After nine subsequent steps, the Year-10 value is 400 × 0.98 × 0.995^9 = 374.71 W. After 24 subsequent steps, the Year-25 value is 347.57 W, or 86.89% of the starting reference.
These are arithmetic assumptions, not observed output or manufacturer warranty values. They do not describe momentary field power under changing sunlight and temperature. A fixed percentage-point warranty slope gives a different result from compounding. See annual degradation rate for detailed time-origin, linear/compound and lifetime-energy conventions.
Measured trend versus warranty limit
PVsyst’s aging documentation distinguishes a warranted module minimum from the average degradation assumed for an array, and treats increasing mismatch as an additional effect. A warranty limit is not automatically the expected field average or plant energy decline.
For equipment comparison, retain the exact model, warranty revision, reference power, first-year provision, subsequent slope, test conditions, exclusions and remedies. Falling below a plotted threshold does not by itself establish an accepted claim: measurement, eligibility and remedy conditions must be checked. Do not substitute a generic retained-power range for the actual document.
Investigating an unexpected decline
Start with the monitoring boundary and data quality. Check missing intervals, sensor or meter changes, replacements, outages and curtailment records. Compare weather and operating conditions, and distinguish recoverable operating losses from module-performance changes. Loss analysis provides the related diagnostic workflow.
Retain commissioning records and follow-up measurements, along with the methods and uncertainty. Qualified personnel can determine whether further inspections or comparable electrical measurements are appropriate. A lower raw kWh total is a reason to investigate, not a sufficient diagnosis of degradation.
Use the evidence in design and customer discussions
Designers should document the forecast source and convention and show sensitivity where uncertain. Installers should follow handling requirements and preserve equipment and event records. Sales teams should distinguish forecast energy, warranty limits and measured performance. Tariff increases do not automatically compensate for reduced energy, and a technology label alone does not establish a higher financial return.
For software evaluation, request a demonstration of the initial-loss and annual-rate inputs, time origin and reported annual outputs. Verify supported conventions rather than assuming manufacturer-specific curves are automatically applied.
Common questions

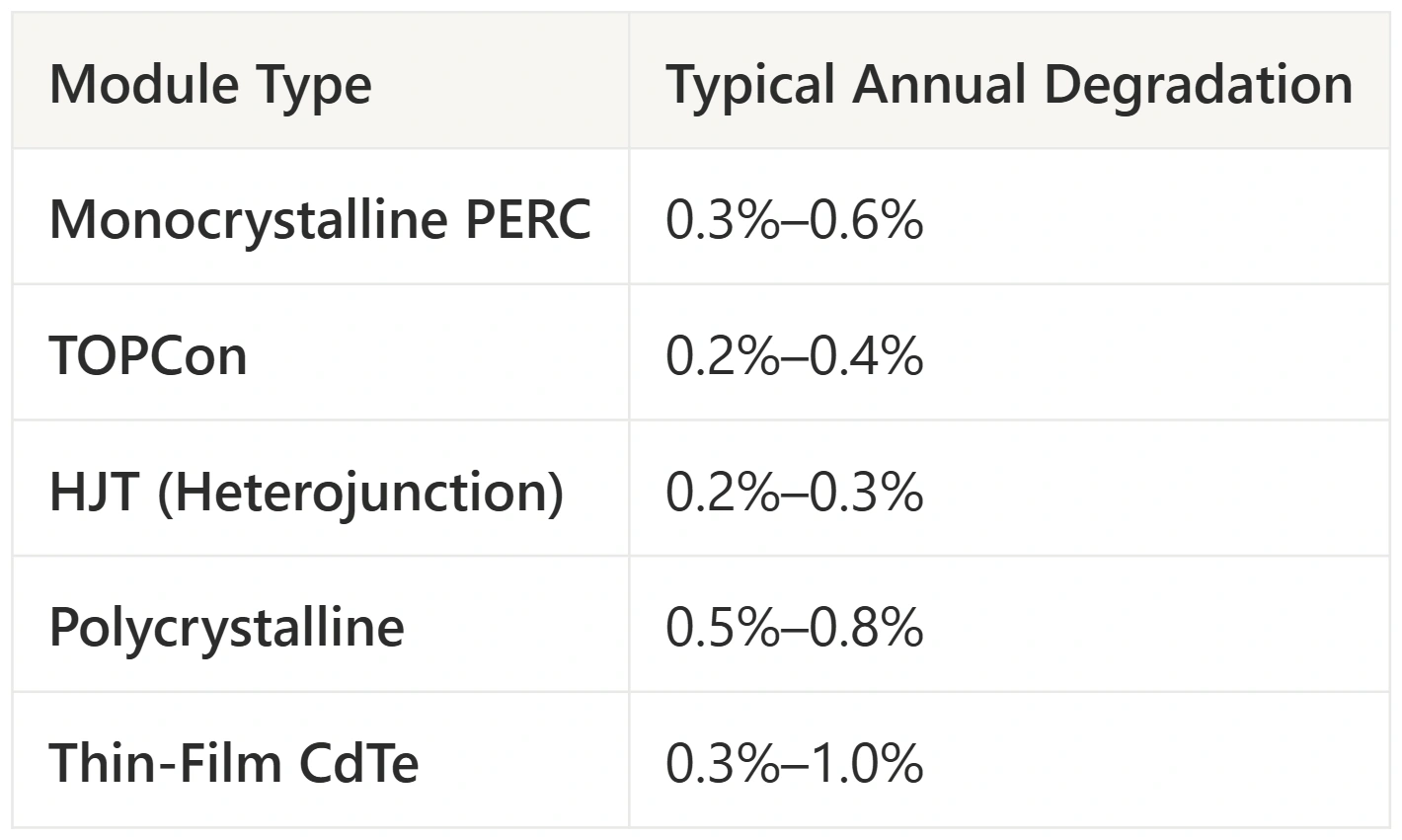

Is there one normal degradation rate for all panels?
No. Equipment, conditions, reference measure and estimation method matter.
Does lower annual production prove panel degradation?
No. Weather, operational losses and data changes can alter production without establishing material aging.
Is a performance warranty a forecast?
No. It defines contractual thresholds and conditions, rather than automatically predicting average output.
Can a module technology eliminate every degradation mechanism?
No universal immunity follows from the technology label; assess the actual equipment and evidence.
