Quick answer
Battery current relative to a specified ampere-hour capacity reference; 1C corresponds to a current numerically equal to that capacity, without guaranteeing exact charging time or runtime.
What Is C-Rate?
Answer: C-rate expresses battery charging or discharging current relative to a specified ampere-hour capacity. For a 100 Ah reference capacity, 1C is 100 A and 0.5C is 50 A. The reciprocal gives an ideal constant-current duration, not guaranteed charging time or backup runtime. Actual limits depend on the exact battery, operating conditions and connected equipment.
The SAM battery model documentation defines C-rate using current divided by rated capacity. Keep that capacity reference and its test conditions with the calculation. A cell rating is not automatically the permitted current of a complete battery installation.
Current and Ideal Duration
C-rate = current in A ÷ reference capacity in Ah.
For an assumed 100 Ah battery:
| Rate | Current | Ideal full-capacity constant-current duration |
|---|---|---|
| 0.1C | 10 A | 10 hours |
| 0.25C | 25 A | 4 hours |
| 0.5C | 50 A | 2 hours |
| 1C | 100 A | 1 hour |
| 2C | 200 A | 0.5 hours |
These are dimensional examples, not approved operating currents. At 100 A, a 200 Ah reference battery instead operates at 0.5C. Specify whether the rating concerns charging or discharging: the permitted values need not be equal.
Charging can taper as voltage limits are reached. Discharge can end at a voltage, temperature or state-of-charge limit before the full reference capacity is delivered. Capacity itself depends on its rating conditions. Consequently, “1C” does not promise a complete charge in exactly one hour.
Continuous and Pulse Ratings
Read current limits separately from capacity. As an exact manufacturer example, the Victron Lithium NG 51.2 V, 100 Ah technical data lists 100 A maximum continuous discharge and 200 A maximum pulse discharge for 10 seconds. Relative to its 100 Ah reference, these are 1C and 2C respectively.
The 10-second limit matters: 200 A is not permission to sustain a half-hour discharge. Check the complete manual for temperature, charging, BMS, installation and compatible equipment conditions. This model’s limits do not establish limits for every LFP battery.
Is kW Divided by kWh the Same as C-Rate?
Power divided by energy is an inverse-hour ratio. For a defined 10 kWh energy reference and 5 kW output, 5 ÷ 10 = 0.5 per hour, suggesting two hours only in an ideal constant-power, fully available-energy case.
It can approximate current-based C-rate when voltage and capacity references are consistent. It is not universally identical. Battery voltage changes; AC output includes conversion losses; an energy specification may already describe a restricted usable window.
For a hypothetical 100 Ah battery with 51.2 V nominal voltage, nominal energy is 5.12 kWh. At an assumed instantaneous terminal voltage of 56 V and current of 50 A, DC power is 2.8 kW. Current-based rate is 0.5C, while 2.8 ÷ 5.12 = 0.547 per hour. This illustrates the reference difference, not an approved operating point or AC output rating.
Matching Storage to the Load
Retain three independent checks:
- Energy: Can the available storage cover the required consumption over the intended period?
- Continuous power/current: Can the battery, inverter and permitted configuration sustain the load at the relevant SOC and temperature?
- Transient demand: Do the permitted surge duration and load-starting requirements match?
For example, a system with a stated 5 kW continuous AC output limit cannot alone sustain an 8 kW AC demand for 15 minutes, even if its stored energy is sufficient. The solution may involve a supported larger configuration, load management or another supply; energy capacity alone does not resolve the power limit.
A larger inverter nameplate is not automatically an incompatible pairing. Verify the manufacturer’s supported combination and enforced charge/discharge limits rather than assuming all inverter power is drawn from the battery.
Heat, Lifetime and Handoff
For fixed resistance, resistive heating follows I²R, so doubling current produces four times that component of heating. This is not a universal multiplier for total battery heat or a prediction of cycle life. Use model-specific performance and lifetime evidence at the relevant temperature, SOC window and duty cycle rather than a fixed percentage penalty above 0.5C.
Designers should record the capacity reference, continuous/pulse limits, allowed duration, load profile and operating conditions. Installers should verify the supported battery/BMS/inverter arrangement, configuration, cabling and manufacturer clearances. Sales teams should explain power capability separately from stored energy and describe backup hours only with a stated load and energy boundary.
When evaluating SurgePV, ask which storage inputs, dispatch assumptions and equipment checks the proposed workflow supports.
Common Questions

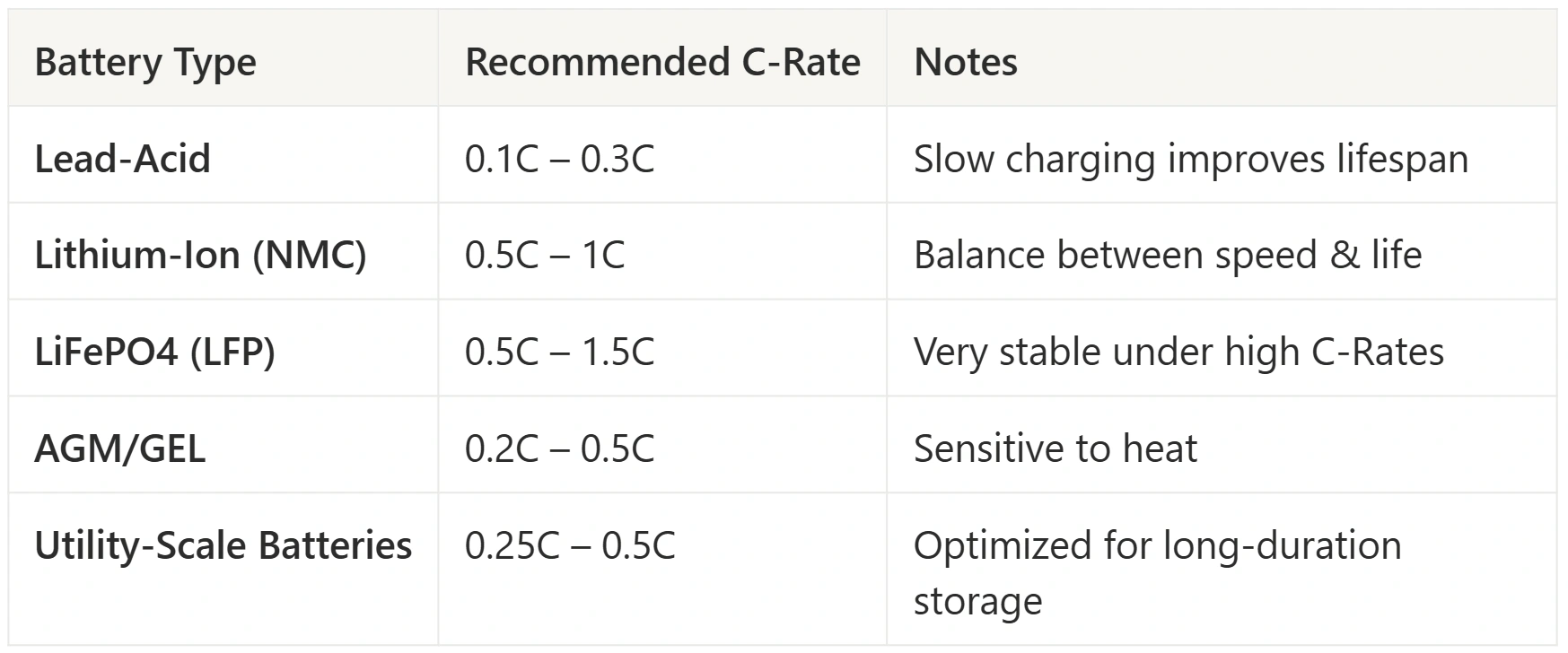

What C-rate do solar batteries use?
There is no universal solar-battery range. Read the exact model’s charging and discharging limits and select a permitted configuration for the actual duty cycle.
Does C-rate affect battery life?
Operating current is one relevant condition. Its lifetime effect depends on the battery and other conditions; no fixed cycle-life reduction follows from C-rate alone.
What is the difference between C-rate and power rating?
C-rate normalizes current to a capacity reference. Power is an absolute rate of energy transfer, measured in watts or kilowatts. Their relationship requires voltage and consistent boundaries.
Related Glossary Terms
About the Contributors

CEO & Co-Founder · SurgePV
Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
