Quick answer
A comparison in which the stated cost of solar electricity equals or falls below a defined retail or wholesale grid-electricity benchmark, using explicit cost and incentive assumptions.
Answer: Grid parity means the cost of electricity from a generating option, such as solar PV, equals or falls below a specified grid-electricity benchmark. The comparison must identify its location, cost method, incentives and retail or wholesale basis. It is a screening concept, not a guarantee of positive cash flow, payback or savings on every generated kilowatt-hour. Project economics still depend on when and how electricity is used or sold.
Choose the benchmark before claiming parity
The term is incomplete without saying what solar is being compared with:
| Comparison | Relevant question |
|---|---|
| Retail or “socket” parity | Does producing useful electricity compete with buying it under the customer’s applicable tariff? |
| Wholesale or contracted supply | Does delivered generation compete with the relevant market revenue or contract price on a comparable basis? |
| Unsubsidized comparison | Are incentives and tax benefits excluded consistently from the stated solar cost? |
| Incentive-inclusive comparison | Which verified incentives are included, and does the project qualify? |
“Socket parity” is also used for retail grid parity; it is not a universal separate test that automatically includes a battery. Define the usage in the analysis rather than treating the labels as standardized financial models.
A solar auction price, wholesale market price, fossil-generation cost and a household’s retail bill are different quantities. Comparing any two requires matched scope. Do not equate a low project bid with a universal country-wide declaration of unsubsidized parity.
Solar cost and electricity value are different

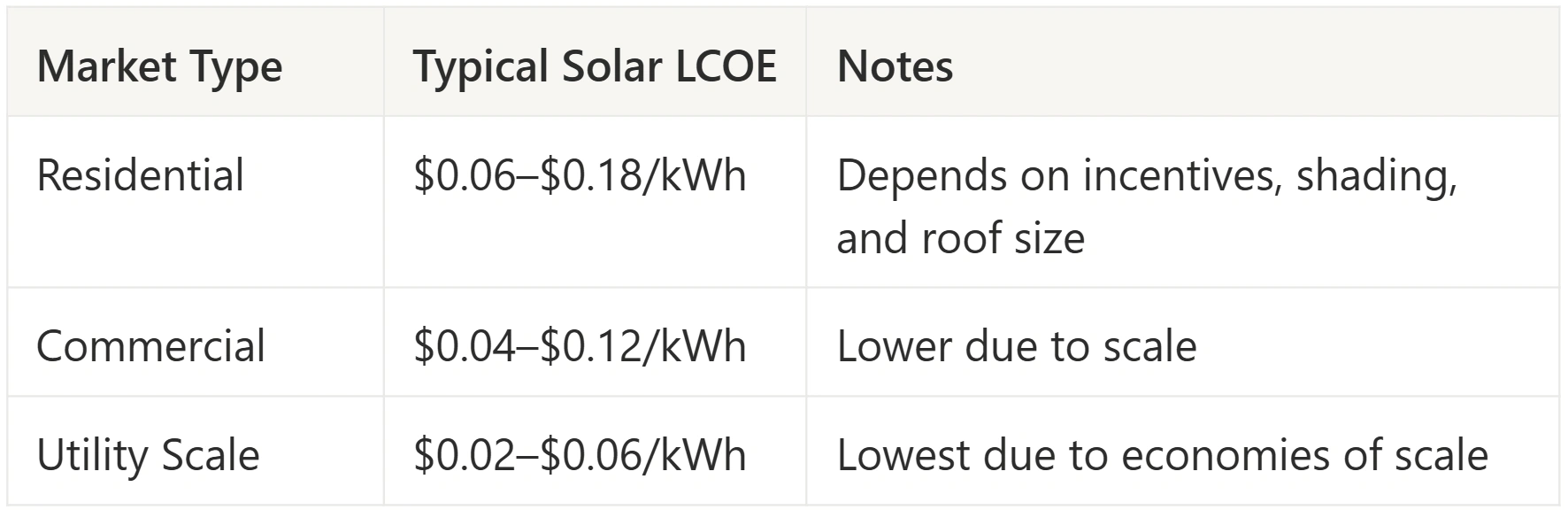

Levelized cost of energy, or LCOE, measures cost per unit of delivered energy over a defined analysis period. The SAM LCOE documentation distinguishes this cost metric from the value of avoided purchases and recommends considering other financial metrics. Its financial-model calculation can include debt, tax and incentive effects; record what your model includes.
For a comparison, use the same currency-year and real or nominal basis. Specify the delivered-energy boundary, operating and replacement costs, degradation assumptions, discount rate and analysis period. A simple lifetime-cost divided by lifetime-energy figure is an undiscounted screening measure unless explicitly calculated otherwise.
A hypothetical example: below retail price, below project value?
Assume a stated, consistently calculated solar cost of $0.10/kWh. The applicable avoidable purchase price is $0.20/kWh, and exported electricity receives $0.03/kWh. These are illustrative inputs, not current tariff or installation-price claims.
Suppose 40% of each year’s delivered solar electricity offsets purchases at that price and 60% is exported. The simplified average value is:
0.40 × $0.20 + 0.60 × $0.03 = $0.098/kWh
At 10,000 kWh, the annual energy value is $980. Solar cost is below the stated retail rate but slightly above this simplified realized value. If self-consumption instead reaches 70%, with the same assumptions, average value becomes $0.149/kWh, or $1,490 for 10,000 kWh.
This comparison omits time-varying prices, demand charges, fixed charges, taxes and timing of cash flows. It is not NPV or a savings guarantee. It shows why retail-price parity alone cannot establish an investment result.
A project review workflow
- Use the actual tariff or sale contract. Identify avoidable charges and export compensation rather than assigning the entire average bill to every solar kWh.
- Match generation and consumption in time. Account for export limits, operating schedules and time-of-use prices. Retain the energy boundary and treatment of curtailed electricity.
- Record full project cost scope. Use installation, financing, maintenance, replacement and other relevant costs. Check incentive eligibility rather than assuming a subsidy-free result.
- Keep scenarios explicit. Compare with and without incentives; test plausible changes to production, rates, financing and replacement costs. An assumed escalation rate is not a utility forecast.
- Check cash-flow metrics. Use the relevant owner or customer perspective, then examine NPV, payback and affordability. Solar financial modeling provides the wider decision context.
For designers, this means pairing a site-specific production estimate with a defined use or sales model. Installers should retain the cost and financing basis behind a proposal. Sales teams should explain the comparison and its sensitivities rather than promising “fixed electricity costs for 25 years.”
Questions about grid parity
Has my area reached grid parity?
A broad market statement cannot answer this for an individual installation. Compare the site’s stated solar cost with the relevant dated electricity benchmark, then evaluate the actual project cash flows.
Does grid parity mean incentives are unnecessary?
Only an explicitly unsubsidized comparison supports that narrow claim. Incentive-inclusive parity must disclose the benefits used, and neither result by itself guarantees financing or a positive project return.
Does a lower LCOE justify a larger system?
Not automatically. Extra generation may be exported at a lower price or curtailed. Assess the marginal useful energy and added cost, including approved grid export limits.
Will a battery improve parity?
It may change when electricity is used, but adds cost, losses and operating constraints. Compare the complete PV-only and PV-plus-storage cases on matching cost and delivered-energy boundaries.
Related Glossary Terms
About the Contributors

CEO & Co-Founder · SurgePV
Keyur Rakholiya is identified by SurgePV as its CEO and a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, testing claims, media appearances, and speaking engagements are not asserted without retained evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
