DefinitionG

Green Tariff

A utility green tariff is a renewable-electricity procurement arrangement under a specific tariff, with eligibility, project linkage, billing and attribute rights defined by the applicable program.

5 min read
Akash Hirpara

Written by

Akash Hirpara

Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Quick answer

A utility green tariff is a renewable-electricity procurement arrangement under a specific tariff, with eligibility, project linkage, billing and attribute rights defined by the applicable program.

Answer: A green tariff is a renewable-electricity purchasing option whose terms depend on the utility and jurisdiction. In the U.S. utility-program context, it generally lets eligible customers procure bundled renewable electricity from a specific project through a special tariff. Check eligibility, billing, project linkage, environmental-attribute retirement and contract risks. The name alone does not guarantee savings, new generation, physical backup or reporting compliance.

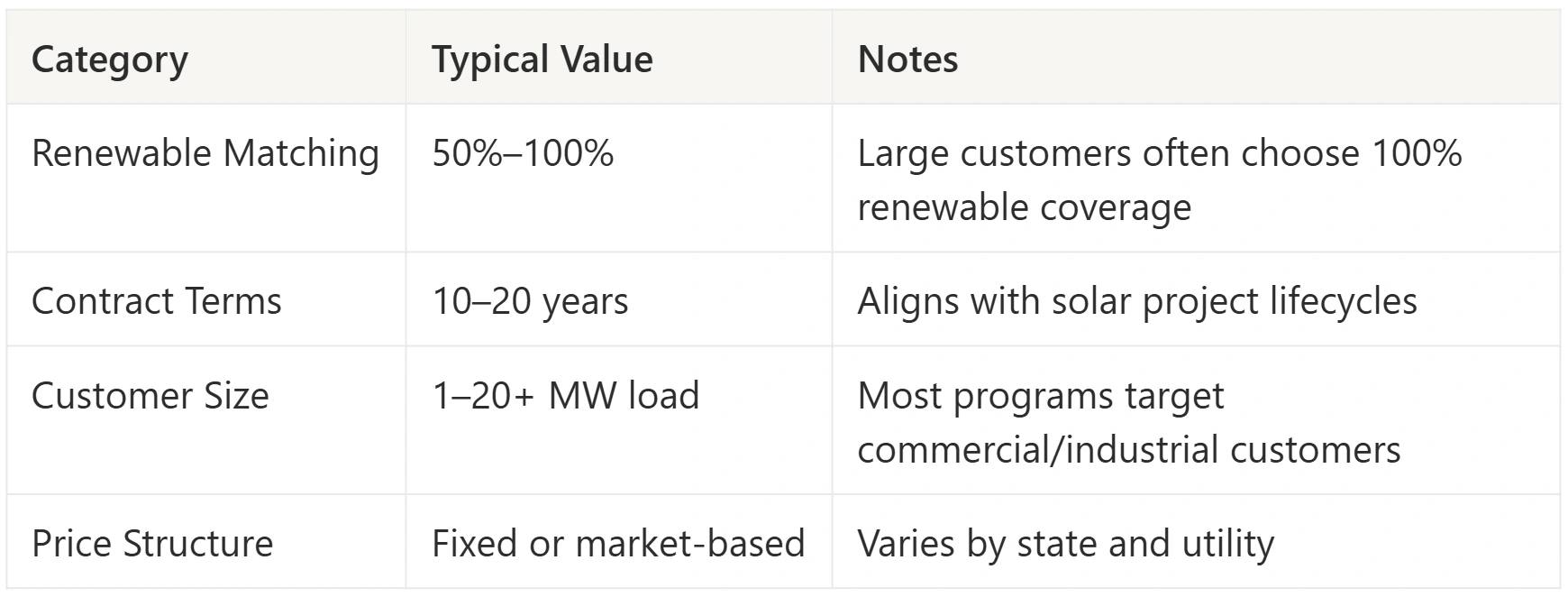

What a utility green tariff provides

The customer contracts through the utility for an eligible renewable procurement arrangement rather than installing an array at the customer’s site. The applicable tariff and agreement specify the project or supply basis, subscription quantity, payment mechanism and attributes.

EPA’s utility green-tariff overview describes optional, commission-approved programs in regulated U.S. markets, generally serving larger commercial and industrial customers. Eligibility and structures vary. Outside that context, “green tariff” may describe a different retail offer, so identify the jurisdiction and actual product.

The arrangement does not create a dedicated physical wire from the renewable plant to the subscriber or provide outage backup. A project-specific purchase is a contractual and accounting relationship within the relevant electricity system.

Distinguish adjacent procurement options

Option What to establish
Utility green tariff Eligible accounts, special tariff, project linkage, billing and bundled attributes
Standard utility green-power product Subscription terms, renewable mix, charges and certificate handling
Physical or sleeved PPA Delivery arrangement, balancing, price, contract parties and attributes
Virtual PPA Financial settlement, market risk and certificate rights; it is not physical delivery to the buyer
Community choice arrangement Applicable local authority and supply offering; renewable content is not inherent in the label
Onsite solar Ownership or contract, production, site requirements, bill effects and attribute rights

These are related choices, not interchangeable types of green tariff. EPA’s green-power supply options separates standardized retail and project-specific products. Use that distinction to ask the supplier what is actually being offered.

A feed-in tariff is different: it concerns payment for eligible generation or export under a defined scheme, rather than simply a customer’s renewable-electricity purchase.

Evaluate billing on a matched basis

Do not compare a generation-only charge with an all-in electricity bill. Establish whether the program replaces an energy component, adds a charge, applies a credit or changes other terms. Check demand, delivery and fixed charges, escalation, settlement adjustments, enrollment fees and exit obligations.

For a hypothetical simplified comparison, assume two otherwise identical all-in volumetric rates of $0.085/kWh and $0.098/kWh, applying to the same 5,000,000 kWh/year:

Rate difference = 0.098 - 0.085 = $0.013/kWh
Annual difference = 5,000,000 × 0.013 = $65,000

These are assumed rates, not a current Colorado program quotation. The result is valid only for the stated simplified bill structure. If a tariff has credits or different component treatment, calculate the full comparable bill instead. A rate premium can be positive or negative; no universal cents-per-kWh range establishes the actual cost.

Five million kWh is 5,000 MWh. If the program supplies eligible attributes covering that whole quantity, verify the corresponding certificate and retirement records. Do not attach an unsupported tonnes-of-CO₂ reduction to the procurement quantity.

Verify attributes and reporting claims

Request the generation source, quantity, vintage, geographic eligibility, ownership and retirement documentation. A renewable energy certificate represents an attribute right, not an avoided-emissions offset. Avoid duplicate claims between the project, utility and customer.

The GHG Protocol Scope 2 guidance sets quality criteria for contractual instruments used in market-based accounting. Program participation alone does not establish that every reporting criterion or separate target-setting rule is met. Check the requirements applicable to the reporting period.

Additionality is a separate question: what evidence shows the customer commitment helped enable new generation or another claimed change? A named project or long contract does not by itself prove that counterfactual. Keep renewable-use documentation and claims about development impact distinct.

Enrollment and contract checklist

  1. Confirm the utility territory, eligible account classes, quantity limits and current capacity availability.
  2. Obtain the current approved tariff and proposed agreement, with their revision dates.
  3. Identify the source project, expected start date and treatment of delays or under-delivery.
  4. Calculate comparable bills, including all affected components and scenario assumptions.
  5. Review term, escalation, credit requirements, termination, transfer and changes in customer load.
  6. Confirm attribute retirement and reporting evidence before making a customer-specific claim.

Do not assume the utility absorbs all risk or that a program has no upfront commitment. The agreement determines exposure. Project construction and delivery dates must be verified, rather than using one standard program timeline.

Compare with onsite solar or a combined approach

Onsite generation and offsite procurement can address different needs. Compare costs, space, ownership, maintenance, production uncertainty and contract flexibility over a consistent period. Tax treatment and incentives require separate current eligibility review. A module warranty is not a guaranteed investment life or bill-saving result.

A combined plan also needs a defined consumption and attribute balance. Avoid procuring or claiming the same quantity twice. Solar and storage may change load timing, but demand-charge savings and backup depend on the tariff, design and approved equipment; neither is automatic.

Green energy provides the broader terminology. For financial comparisons, document each option’s inputs and risks rather than presenting a universal winner.

Frequently asked questions

Is a green tariff the same as a feed-in tariff?

No. A green tariff is a purchasing arrangement in this context. A feed-in tariff specifies eligible generation or export payments under a scheme.

Does the program always cost more?

No. Compare the actual tariff, credits and affected bill components. A generic premium range is not evidence of the customer’s cost.

Can a business combine it with onsite solar?

Potentially, subject to program and contract terms. Reconcile consumption, subscriptions and retained attributes, including how future onsite generation changes eligible purchasing quantities.

Does participation prove new renewable capacity was enabled?

Not automatically. Evaluate the project and commitment evidence separately from the renewable attributes used for purchasing claims.
