DefinitionG

Green Energy

Green energy describes energy associated with environmental benefits, often renewable; the applicable program definition, lifecycle impacts and environmental-attribute claims must be specified.

4 min read
Akash Hirpara

Written by

Akash Hirpara

Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Quick answer

Green energy describes energy associated with environmental benefits, often renewable; the applicable program definition, lifecycle impacts and environmental-attribute claims must be specified.

Answer: Green energy is a broad term for energy associated with environmental benefits, often from renewable sources such as solar and wind. Its precise meaning depends on the program or claim being made. Renewable generation is not impact-free: lifecycle emissions, land and water effects, fuel sourcing and environmental-attribute ownership matter. Explain the technology and evidence behind a claim rather than relying on the label alone.

Green, renewable and clean energy

Renewable energy describes replenishing resources. “Green” emphasizes environmental characteristics, while “clean” often refers to emissions or a policy-defined category. These terms are not one universally interchangeable classification.

For a specific U.S. example, EPA’s voluntary green-power definition includes solar, wind, geothermal, biogas, eligible biomass and low-impact small hydroelectricity, with renewable electricity surplus to regulatory requirements. That program definition is narrower than treating every hydro or biomass project as automatically green.

Nuclear generation can be included in some low-carbon or clean-energy categories, but it is not included in that EPA renewable green-power list. Identify the applicable definition instead of claiming all programs use the same terminology.

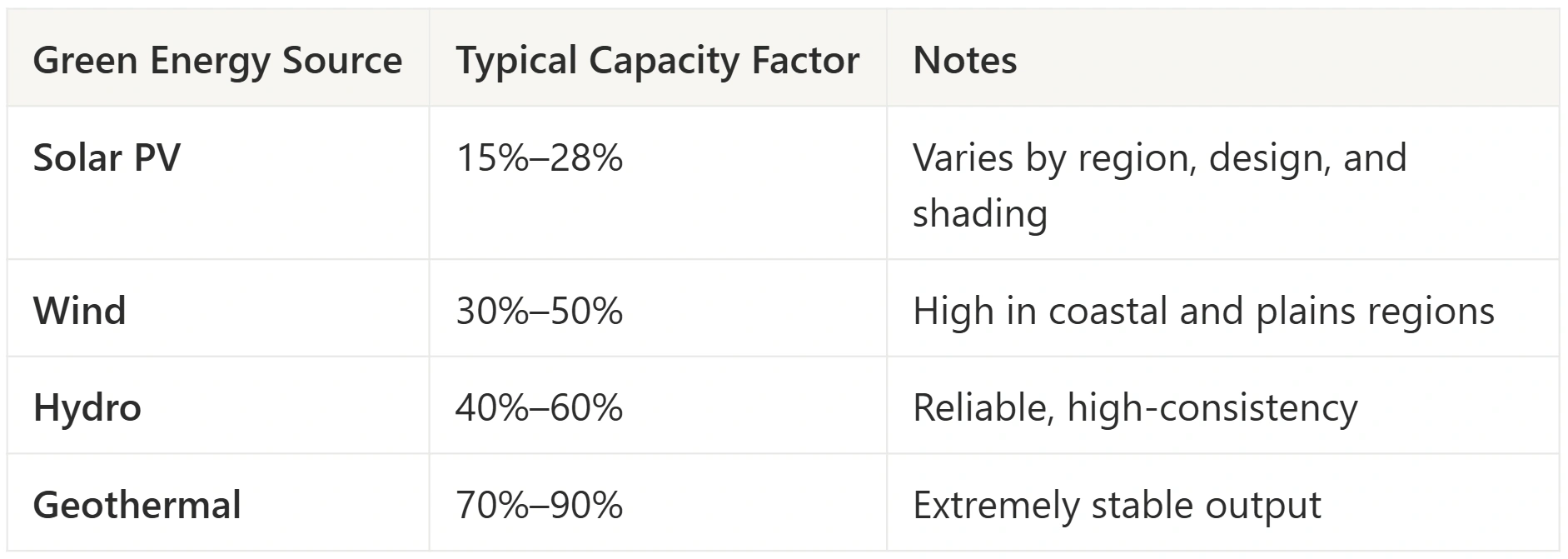

How the main technologies differ

Resource Conversion principle Conditions to consider
Solar PV Semiconductor cells convert sunlight into electrical output Solar resource, shading, materials, land or roof suitability and end-of-life treatment
Wind Turbines convert moving air into electricity Site resource, variable production, wildlife, noise and land or marine conditions
Hydropower Water movement drives generating equipment Water availability, habitat, land effects and reservoir conditions
Geothermal Earth’s heat provides energy for power or thermal uses Resource, design, water and site-specific emissions
Biomass or biogas Organic material or gas provides an energy input Fuel sourcing, combustion emissions, land-use effects and the chosen accounting boundary

Renewable does not mean that combustion never occurs: biomass and biogas can be burned. Pumped storage stores energy using an earlier electricity input; its stored output is not automatically new renewable generation. Solar thermal can supply useful heat, while concentrating solar power can produce electricity. Distinguish them from solar PV.

Generation and environmental claims are different records

Measured solar output shows how much electricity a system generated at its stated meter boundary. It does not by itself establish who may claim the renewable attributes. In the U.S., EPA explains that renewable energy certificates represent environmental and other non-power attributes of renewable generation.

Check who retains, transfers and retires those attributes. Selling a system’s certificates can affect the owner’s renewable-electricity-use claim even though the panels remain onsite. Avoid having the generator and buyer claim the same attributes. A renewable procurement arrangement also does not mean dedicated electrons from a named plant reach the customer every hour.

For corporate reporting, follow the applicable GHG Protocol Scope 2 guidance and contractual-instrument quality criteria. Do not equate a purchasing label with automatic compliance with every reporting or target-setting framework.

Calculate emissions with a declared method

A useful first step is to state the energy quantity, period, location, emissions factor, unit and calculation purpose. For a hypothetical 48 MWh/year and an assumed factor of 0.35 tCO₂/MWh:

48 MWh × 0.35 tCO₂/MWh = 16.8 tCO₂

This is an illustrative factor-based estimate, not verified avoided emissions for Germany or another actual project. A grid-average inventory factor and a marginal displacement estimate answer different questions. EPA AVERT is one U.S. tool for analyzing grid emissions impacts; use a method appropriate to the region and question.

Do not multiply the first-year value by 25 and present it as a verified lifetime outcome. Production, degradation, grid composition and the counterfactual may change. Operational displacement, lifecycle footprint and corporate electricity accounting are separate assessments; keep their boundaries explicit. See solar carbon footprint.

What solar professionals should document

For a proposal, preserve the production run and assumptions, explain onsite consumption and authorized exports, and identify certificate ownership. Match claims to the evidence and actual reporting period. Compare procurement options on the customer’s objectives rather than assuming onsite generation always beats a utility renewable program.

A grid-connected PV system does not automatically provide energy independence or backup during outages. Storage, controls and the actual approved system configuration matter. Avoid equating an annual generation total equal to consumption with renewable supply at every moment.

Frequently asked questions

Is every renewable source automatically green?

No. Environmental effects and eligibility depend on the technology, project and program definition. State which definition you are using.

Does solar have zero lifecycle emissions?

No. Materials, manufacturing, transport, installation and end-of-life activities have impacts. Operational generation and lifecycle assessment have different boundaries.

Does buying renewable electricity prove physical emissions were avoided?

Not by itself. Procurement accounting and a counterfactual avoided-emissions assessment are different questions with different evidence requirements.

Does annual renewable matching mean continuous renewable supply?

No. Annual matching does not establish hourly matching or backup capability. Specify the time basis and system arrangement.
