Energy Payback Time

Energy payback time estimates recovery of a solar system’s declared energy investment using compatible input and output energy bases; its value depends on inventory scope and production assumptions.

3 min read
Akash Hirpara

Written by

Akash Hirpara

Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Quick answer

Energy payback time estimates recovery of a solar system’s declared energy investment using compatible input and output energy bases; its value depends on inventory scope and production assumptions.

Answer: Energy payback time estimates how long a solar system takes to recover the energy invested in producing and installing it, using a stated accounting method. It depends on the inventory boundary, energy-carrier conversions and expected electricity production. It is different from financial payback and carbon payback; a single year range cannot represent every technology, supply chain or installation.

Define the energy investment

The inventory can include material extraction, module manufacture, mounting, electrical equipment, transport and installation. Identify whether maintenance, replacements and end-of-life processes are included, and how recycling credits are allocated. A module-only result cannot represent a complete plant without adding the other included components.

State the database version, manufacturing period and supply-chain assumptions. An inverter replacement is an additional energy investment when the selected boundary includes it. Renewable manufacturing electricity can change emissions without reducing total energy demand by the same amount.

Use compatible energy units

An inventory reported in primary-energy equivalents cannot simply be divided by delivered AC electricity. Declare the conversion convention and reference electricity mix or technology. The IEA PVPS net-energy guidelines require transparent boundaries and warn against comparing unlike energy carriers.

For a simplified example using an already converted, compatible electricity-equivalent basis:

Energy payback time = declared energy investment / annual returned energy

Annual operating energy must be treated consistently with that boundary, rather than omitted or subtracted twice. Where output and operating investment change with time, track cumulative energy instead of assuming constant annual production.

Checked hypothetical comparison

Assume an investment of 18,000 kWh electricity-equivalent, with the conversion already documented. Two otherwise hypothetical production scenarios give:

Annual returned energy on the matching basis Simplified payback
9,500 kWh/year 18,000 / 9,500 = 1.89 years
14,000 kWh/year 18,000 / 14,000 = 1.29 years

These inputs demonstrate arithmetic, not geographic benchmarks or measured product results. They exclude subsequent investments unless those are already included in the declared inventory.

If the first scenario delivers a constant 9,500 kWh/year for an assumed 25 years, gross returned energy is 237,500 kWh. Gross return divided by the declared investment is 13.19, and returned energy minus investment is 219,500 kWh on this simplified basis. Degradation, replacement inventory and a different lifetime would change the result. A warranty term does not prove the operating lifetime.

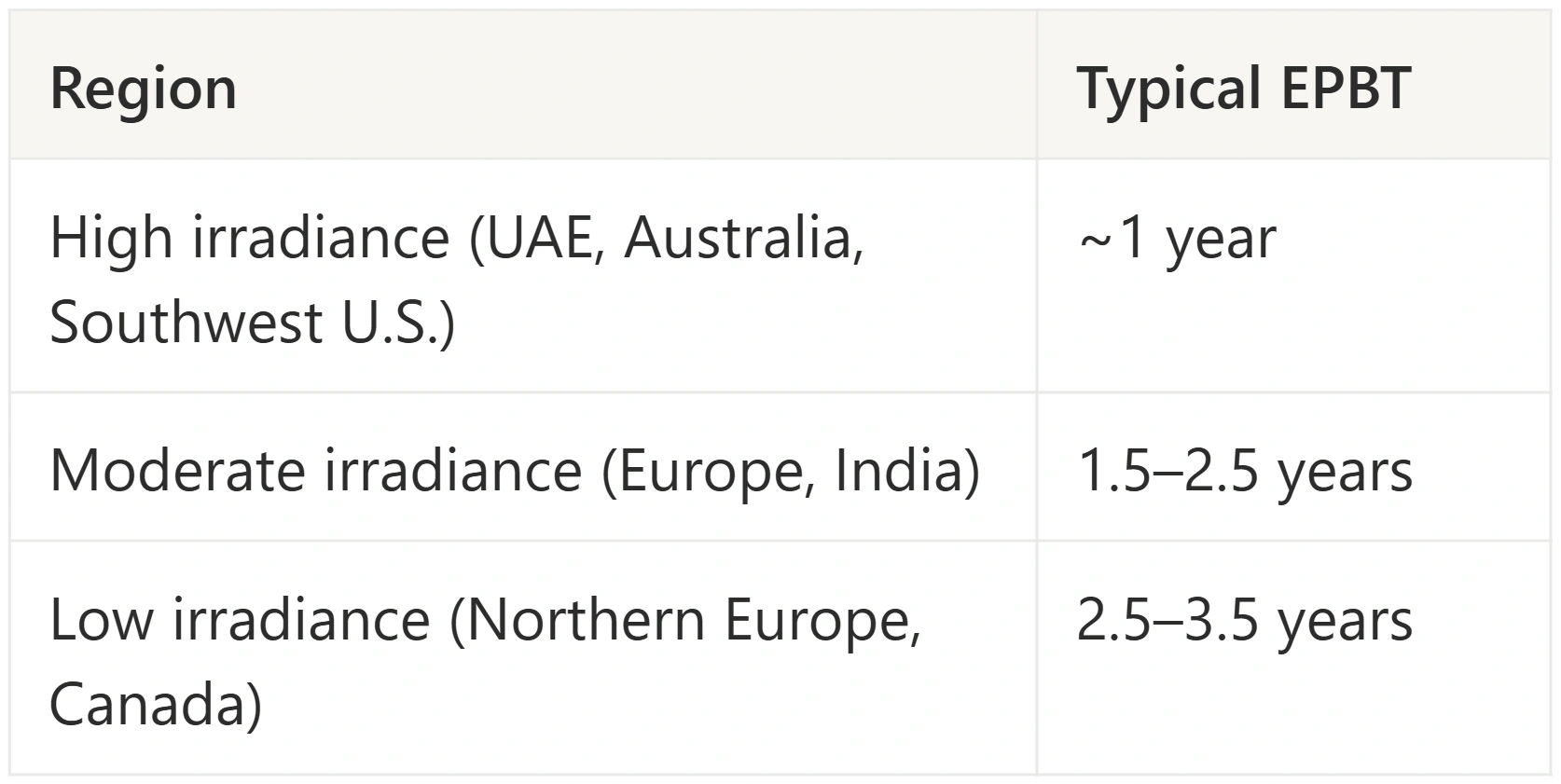

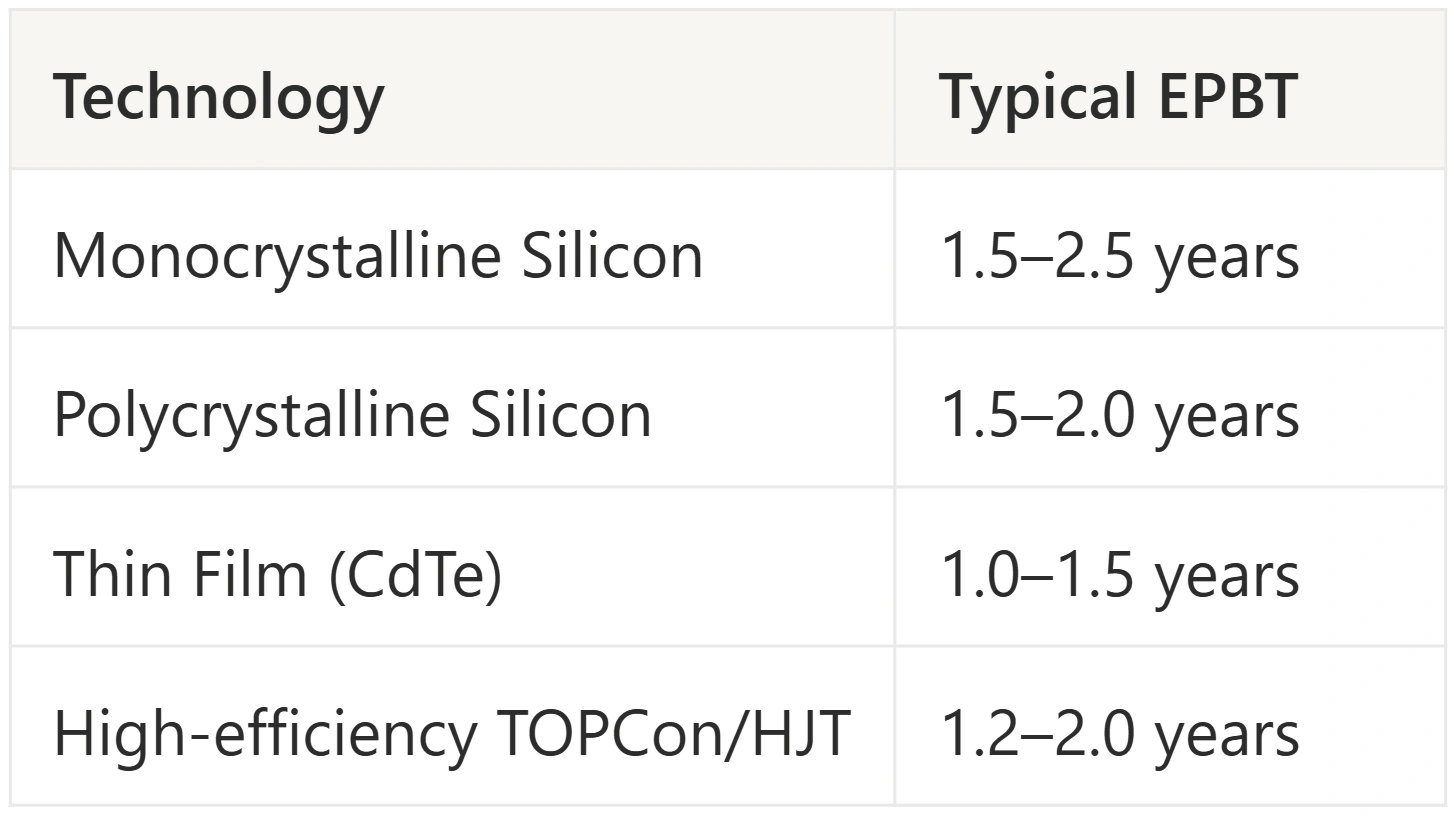

What changes the assessment?

Compare manufacturing inventories, equipment quantities and site-specific delivered energy together. Improved production can shorten payback if the investment remains unchanged; an efficiency increase does not prove that manufacturing energy is unchanged. Shading, temperature, outages and electrical losses affect delivered production rather than manufacturing inventory.

For procurement, request the study boundary and data period behind a manufacturer’s environmental result. Check that its system configuration and irradiation assumptions are relevant to the proposed installation. Report uncertain inputs as scenarios, not a universal solar payback claim.

Energy, carbon and money answer different questions

Financial return uses costs, revenues and financing. Solar carbon footprint uses emissions inventories and a defined electricity counterfactual. LCOE measures a cost per energy unit. None can be substituted for energy payback without changing the question and method.

Common questions

Do all solar panels repay their energy in one to three years?

No universal range follows from the definition. Evaluate a documented study with relevant technology, location, inventory and conversion assumptions.

Is energy payback the same as financial payback?

No. One measures energy recovery; the other depends on monetary cash flows.

Can primary-energy input be divided directly by AC electricity output?

Use a declared compatible accounting basis and conversion method first. Otherwise the ratio mixes different energy carriers.

Does energy payback establish lifetime net energy?

Not by itself. Lifetime output, degradation, operating investment and replacement assumptions are also needed.

About the Contributors

Author
Akash Hirpara
Akash Hirpara

Co-Founder · SurgePV

Akash Hirpara is identified by SurgePV as a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; education, certifications, project totals, financial results, speaking engagements, and media appearances are not asserted without retained evidence.

Editor
Rainer Neumann
Rainer Neumann

Editorial contributor · SurgePV

Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.

Explore More Solar Terms

Browse 300+ terms in our complete solar glossary - or see how SurgePV puts these concepts into practice.

No credit card required · Full access · Cancel anytime

Choose which optional technologies SurgePV may use. Essential storage remains active for security and requested features.
