DefinitionC

Combiner Box

An enclosure joining compatible PV string circuits into combined DC outputs, with model-specific protection, switching and monitoring features.

5 min read
Akash Hirpara

Written by

Akash Hirpara

Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Editorial contributor · SurgePV

Quick answer

An enclosure joining compatible PV string circuits into combined DC outputs, with model-specific protection, switching and monitoring features.

Answer: A solar DC combiner box brings compatible PV string circuits together into one or more combined DC outputs. Depending on the model, it can include overcurrent protection, busbars, monitoring or disconnect equipment. It does not convert DC to AC or create extra inverter capacity. Selection must match the actual string configuration, equipment ratings, environmental conditions and applicable electrical requirements.

Combining strings changes current, not their series count

A PV string connects modules in series. A DC combiner can connect compatible strings in parallel: current contributions add at a common voltage. The combiner does not raise the inverter’s permissible input current, maximum voltage or short-circuit-current rating. Nor does it give every connected string an independent MPPT channel.

Hypothetical operating example: three compatible strings each deliver 10 A at a shared operating voltage of 400 V. Their combined current is 30 A and power is 400 × 30 = 12,000 W, ignoring losses. This illustrates parallel operation; it is not a fuse rating, conductor size or installation approval. Short-circuit current, operating current and worst-case design current are different quantities.

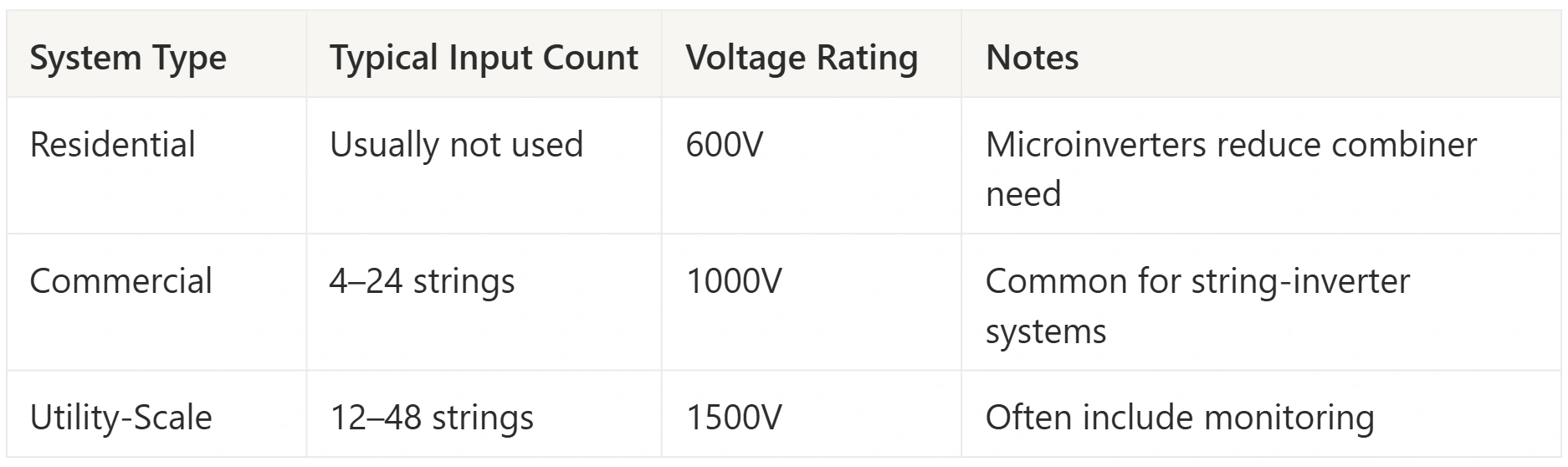

What can be inside the enclosure?

Component Purpose and limits
Input terminals and buses Connect the intended circuits; verify conductor, terminal and assembly ratings
Fuses or DC breakers where provided Overcurrent protection selected for the applicable circuit and equipment
Disconnect equipment where provided A specified isolation or switching function; check actual load-break rating and isolation boundary
Surge protection where provided Address specified transient conditions; does not guarantee protection against every lightning event
Monitoring where provided Observe specified channels and help investigate discrepancies; does not automatically diagnose every failure
Grounding/bonding provisions Support the approved equipment-grounding design, distinct from the current-carrying circuit conductors

Not every box includes every device. “Touch-safe” fuse holders do not by themselves establish that they can interrupt load current. MidNite’s MNPV instructions, revision J, distinguish configurations using breakers or fuses, different model voltage ratings and different positions occupied by devices. The manual also warns against opening its fuse holders under load. These facts apply to those specified products, not every combiner. MidNite MNPV instructions.

When is a separate DC combiner appropriate?

The answer depends on electrical architecture and approved connection options. Some inverters accept multiple strings through integrated input arrangements; others require an external combining arrangement. The number of physical connectors is not necessarily the number of independent MPPT channels.

Adding a box because there are more strings than connectors is not sufficient design justification. Check allowed parallel connections, the tracker’s current limits, maximum short-circuit current, voltage window and string compatibility. Equipment-specific requirements can also govern module type, series count and orientation. SMA model-specific PV input requirements.

A microinverter system has already converted module DC to AC, so any subsequent branch-circuit combining is an AC task. An AC combiner must be selected for the corresponding AC architecture; it is not interchangeable with a PV DC string combiner. A generic junction box provides a wiring connection or transition, whereas the intended combiner assembly joins specified source circuits and any included protective equipment.

A selection review, not a universal fuse formula

Have the qualified electrical designer verify:

  • Voltage: the applicable maximum string voltage under the required temperature basis, plus the ratings of the enclosure assembly, switching devices and protection.
  • Current: source-circuit calculation method, parallel sources and possible reverse/fault contribution, conductor ampacity and equipment limits.
  • Protection: whether overcurrent protection is required for the actual topology; module maximum series-fuse rating, device voltage/interrupting capability and applicable derating.
  • Inverter interface: supported string grouping, tracker assignments, usable current and short-circuit limits.
  • Environment and mounting: the actual enclosure certification, temperature range, exposure, entry hardware, orientation and service access.
  • Documentation: the approved diagram, string identifiers, component schedule and manufacturer instructions.

A rule based only on “three strings” or Isc × 1.56 rounded up does not complete this assessment. Code edition, jurisdiction, calculation method, equipment ratings and permitted exceptions matter. Rounding up must not bypass a module’s protection limit. Do not select wire size, grounding size or a global enclosure classification from a generic glossary table.

Disconnecting the output does not make every part safe

PV source circuits can remain energized in daylight even when the inverter is switched off. Opening a combined-output disconnect does not automatically remove voltage from its incoming string circuits. Rapid shutdown, system isolation and verification of safe conditions have their own boundaries and procedures.

Qualified personnel should use the approved manufacturer and project procedures for installation, inspection and service. Do not treat a glossary as a live-work guide or open connectors/fuse holders under load. Review arc-flash risks and overcurrent protection in the context of the actual system.

Keep design and procurement consistent

Label string assignments against the approved electrical single-line diagram. Check the selected assembly and component list after equipment substitutions or string revisions. Spare positions alone do not establish capacity for future expansion.

For placement, compare access, routing, voltage drop, thermal exposure and maintenance requirements; the shortest possible cable route is not automatically the best location. Explain the actual protection and monitoring scope in proposals without guaranteeing fault detection, savings or payback.

See string inverters and stringing electrical design for adjacent topics. To assess available SurgePV outputs, request a demo with the required drawing and procurement checks rather than assuming automatic combiner, fuse or conductor approval.

Frequently asked questions

Does a combiner box perform inverter conversion?

No. A DC combiner joins specified source circuits; the inverter performs DC-to-AC conversion.

Does every three-string system require the same combiner?

No. Review the actual inverter architecture, protection requirements, equipment ratings and applicable rules.

Can I choose a fuse only by rounding Isc × 1.56 upward?

That alone is insufficient. Qualified selection must also satisfy the applicable method and module, conductor and protective-device limits.

Does its disconnect de-energize all incoming PV strings?

Not necessarily. Incoming source circuits may remain energized; use the actual isolation and safe-work procedure.
