Quick answer
A preliminary cost estimate provided to a solar customer before a detailed site survey or engineering design — giving an approximate price range based on system size, roof type, and local pricing to qualify interest before investing in a full proposal.
Answer: A solar budgetary quote is an early cost estimate prepared from limited project information. It helps a customer assess affordability before detailed design and site verification. State the proposed scope, price basis, assumptions, exclusions and next review step. The document’s label alone does not establish its legal effect; its terms and applicable law matter.
What should the estimate contain?
Use the following editorial checklist to make the estimate reviewable.
| Item | Information to show |
|---|---|
| Project basis | Site, intended use and source of consumption data |
| Preliminary design | Estimated DC capacity and proposed equipment basis |
| Cost | Gross price or range, currency, date and included work |
| Assumptions | Roof condition, access, electrical work and resource inputs |
| Exclusions | Unassessed upgrades, unusual construction and other omitted costs |
| Incentives | Separate verified eligibility and timing assumptions |
| Next step | Site assessment, design review and revised offer |
Define what additional information could change the price. Roof condition, access, electrical work and equipment substitutions should not emerge as unexplained additions after the customer has relied on the estimate.
A transparent hypothetical example
Suppose an installer is exploring an 8 kWp system and uses its own assumed installed-cost range of $2.80–$3.20/W for the stated scope. The preliminary range is:
8,000 W × $2.80–$3.20/W = $22,400–$25,600
These are hypothetical prices, not current market benchmarks. Identify whether that scope includes permits, taxes, electrical upgrades or storage. If roof repairs remain unassessed, record them as an unresolved item rather than hiding them inside an unexplained contingency.
A generation estimate also needs its own assumptions. Capacity alone does not establish annual energy, export credits or payback. Keep the cost estimate separate from any financial model until the tariff, production and consumption inputs are documented.

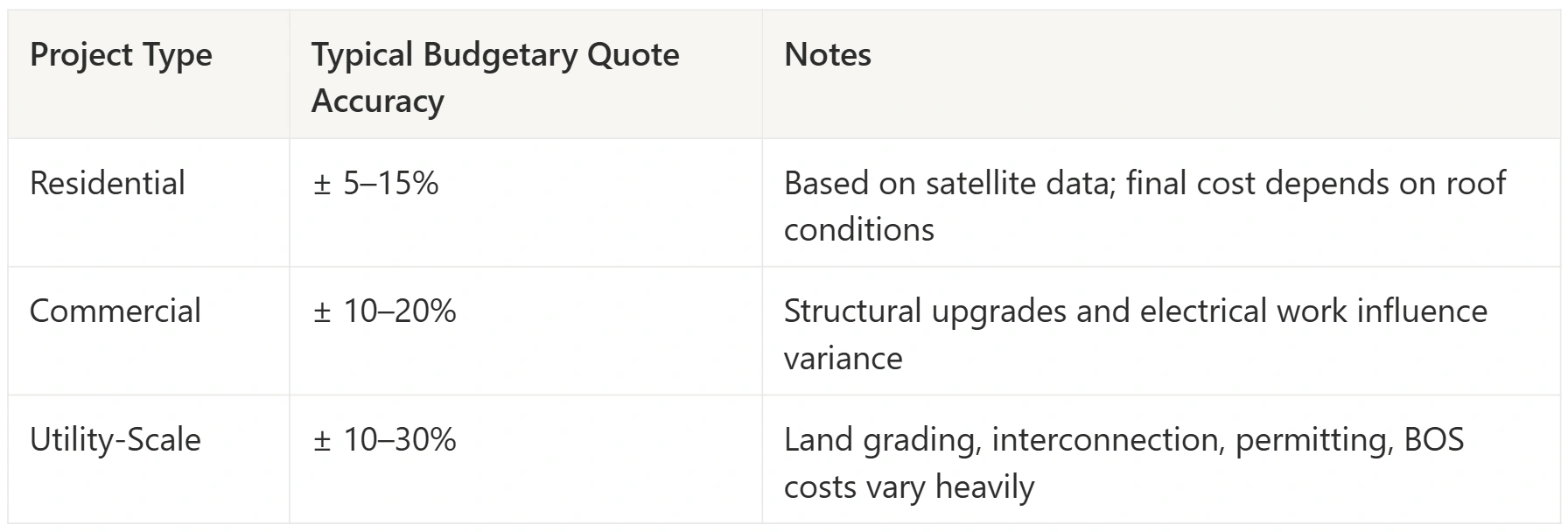

Accuracy comes from evidence
There is no verified universal accuracy percentage for a phone estimate, desktop quote or detailed budgetary quote. More site information can reduce uncertainty, but the benefit depends on what information was missing.
Track estimate-to-final differences for your own projects. Distinguish scope changes from estimating errors: adding a battery is different from discovering an electrical upgrade that the original scope should have addressed. Use those records to revise cost assumptions and explain recurring exclusions.
Do not turn conditional incentives into discounts
Show gross cost before incentives. Verify the applicant, project type, date and programme rules before presenting any incentive scenario.
For US residential projects, the IRS residential clean energy credit page states that the credit is unavailable for property placed in service after 31 December 2025. Do not automatically subtract 30% from a new 2026 residential estimate. A tax credit also differs from an immediate reduction in the amount owed to the installer. Other programmes and business projects require their own eligibility assessment.
Moving from estimate to proposal
Confirm the site and design, resolve exclusions and update equipment and labour pricing before presenting the next offer. Document the estimate’s review date and how changes will be communicated. Do not promise one fixed preparation time, validity period or conversion uplift without evidence from your own workflow.
Use solar proposal software to evaluate how your team presents scope, assumptions and revised offers. Verify the required workflow in a representative project; software presentation does not establish contractual certainty, survey accuracy or incentive eligibility. For energy inputs, see load analysis and the system-size calculator.
Reviewed 30 September 2026. The pricing example is hypothetical. No customer outcomes, lead-conversion statistics or quote-accuracy guarantees are asserted. Tax information is limited to the linked IRS rule; project terms and local requirements need separate review.
Related Glossary Terms
About the Contributors

Co-Founder · SurgePV
Nirav Dhanani is identified by SurgePV as a company co-founder. His SurgePV author page lists only role information that can be tied to the public profile below; credentials, project totals, conversion results, and market-expansion claims are not asserted without retained evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
