Quick answer
Solar asset management is the coordinated oversight of a solar investment’s technical condition, contracts, revenue, costs and obligations. Asset managers connect plant information with owner decisions, supervise service delivery and maintain records for investors and other stakeholders. The scope depends on the ownership structure, contracts, location and portfolio.
What solar asset management covers
Solar asset management links operating information to the financial and contractual responsibilities of a solar investment. An asset manager may oversee one project company or a portfolio, coordinate service providers, reconcile revenue and costs, manage warranty or insurance processes, and report material risks to the owner.
SolarPower Europe’s asset management guidelines distinguish this oversight from the technical plant work performed by operations and maintenance providers. Responsibilities can overlap, especially in smaller businesses, but the contract should identify who performs, reviews and authorizes each task.
Asset management does not begin with a generic production-improvement target. It begins with the asset register, accepted design, operating records, contracts and obligations of the actual investment.
Asset management versus O&M
Operations and maintenance covers plant operation, inspections, preventive tasks and fault response. Asset management connects that work to owner objectives, contract performance, budgets, reporting and longer-term decisions. An O&M provider may carry out a repair while the asset manager coordinates its authorization, claim documentation and financial consequences.
The same organization can perform both roles. That makes clear responsibilities and review boundaries particularly useful: the party doing the work should know which evidence the owner expects and who accepts it.
| Responsibility | Evidence to retain | Decision supported |
|---|---|---|
| Performance oversight | Meter data, monitoring status, weather inputs and model versions | Investigate a material deviation |
| Maintenance coordination | Service records, accepted scope and fault history | Prioritize work and verify completion |
| Revenue control | Meter reconciliation, invoices and settlement terms | Resolve a billing difference |
| Cost and cash-flow review | Budget, invoices, commitments and forecast | Authorize spending or update forecasts |
| Warranty and insurance | Equipment records, claim conditions and event evidence | Submit or assess a claim |
| Obligations | Permit, connection and contract requirements | Assign an action before its deadline |
This is an editorial scope matrix, not a substitute for the project’s contracts or local legal requirements.

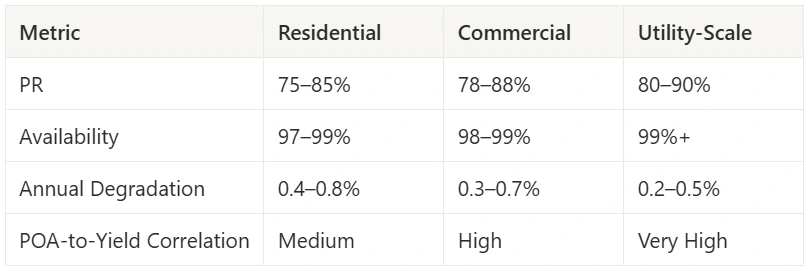

Define metrics before setting targets
The National Laboratory of the Rockies O&M research programme examines performance, availability, lost production and costs alongside climate information. A useful owner report therefore needs more than a comparison with the original annual estimate.
Choose the reporting period, measurement boundary, data-quality rules and contractual exclusions before calculating metrics. Do not apply universal availability, cost or performance-ratio thresholds to every project.
- Specific yield: measured energy divided by installed DC nameplate capacity, with period and meter boundary stated.
- Performance ratio: final yield divided by reference yield based on plane-of-array irradiation. It is different from actual energy divided by the original P50 forecast.
- Performance index: actual energy compared with a clearly defined expected-energy model. Identify whether expected energy uses long-term typical weather or conditions during the reporting period.
- Availability: define the eligible hours or energy, equipment scope and exclusions. Time availability does not describe the energy consequence of an outage by itself.
- Financial results: reconcile revenue, operating expenditure and cash flow against the actual settlement and accounting basis.
The IEA PVPS climate-specific O&M guidelines, sections 2.1 and 2.2, explain yield-based performance metrics and time versus energy-based availability. Their definitions support consistent reporting; targets and contractual guarantees still need a project-specific basis.
Example: a forecast comparison is not a fault diagnosis
Hypothetical figures: a plant has a long-term annual forecast of 1,000 MWh. Its measured output is 900 MWh, while a model evaluated using that year’s weather predicts 920 MWh.
| Comparison | Calculation | Result |
|---|---|---|
| Actual versus long-term forecast | 900 / 1,000 | 90% |
| Actual versus weather-period expectation | 900 / 920 | 97.83% |
| Difference from weather-period expectation | 920 − 900 | 20 MWh |
These invented numbers demonstrate the denominator distinction. They do not establish that weather caused the entire forecast gap, or that the remaining difference is an equipment fault. Validate the weather inputs, metering, model assumptions, curtailment treatment and missing-data rules before assigning a cause or penalty.
Preserve the handover record
Retain the accepted design and model assumptions, as-built drawings, equipment identifiers, commissioning records, warranties, connection terms and operating instructions. Document who can access monitoring and who responds to alarms. A communications gap needs investigation; it does not necessarily establish lost generation.
When equipment, shading or operating settings change, record the event and evaluate whether the expected-energy model needs revision. A warranty degradation limit is a contractual condition, not automatically the best estimate of actual future degradation.
For designers and EPCs, the solar design workflow provides a useful starting point for discussing which design records can support handover. Confirm the available outputs and the owner’s required format. A design platform should not be described as an operational asset-management system without verified capabilities.
Match the service to the portfolio
Residential owners may need monitoring access, an identified service contact, equipment documentation and a response procedure. Commercial assets can add tenant, lease or power-purchase-agreement responsibilities. Larger or multi-country portfolios can require project-company reporting, lender obligations and jurisdiction-specific oversight.
Ask prospective providers to specify the assets covered, service boundaries, response responsibilities, reporting frequency, data rights and exclusions. Separate monitoring subscriptions, field maintenance, specialist inspections and commercial management in quotations. There is no defensible universal fee or guaranteed energy uplift for all these scopes.
Questions about solar asset management
Does asset management guarantee higher energy production?
No. It can help identify issues and coordinate appropriate action, but the outcome depends on the asset, operating conditions and service scope. Do not promise a fixed percentage improvement without applicable evidence.
Is the original design forecast a sufficient operational benchmark?
It is an important retained reference, but current performance assessment also needs the reporting period’s conditions, reliable measurements and stated model boundaries. A shortfall against a typical-weather forecast does not by itself identify a fault.
Who should approve asset-management spending?
The management agreement and owner’s authorization process should establish responsibility and spending limits. Emergency work, warranty claims and planned improvements can require different procedures.
How is asset management different from fleet management?
Fleet management can focus on coordinated monitoring and operations across multiple systems. Asset management also connects those activities to the investment’s contracts, financial reporting and owner obligations. Define the scope rather than assuming the labels are interchangeable.
Related Glossary Terms
About the Contributors

Solar-industry contributor
Nimesh Katariya contributes to SurgePV content concerning solar project workflows. This profile intentionally does not assert certifications, project totals, seminar counts, or technical-review authority without retained verification evidence.

Editorial contributor · SurgePV
Rainer Neumann is credited as an editorial contributor on SurgePV content. This profile does not assert engineering credentials, project totals, software-testing experience, education, speaking engagements, or media citations because independent verification evidence is not retained in the publication record.
